STOCK TITAN

IREN August 2025 Monthly Update

(Moderate)

Sentiment and the balance of points

Rhea-AI Sentiment reads the wording of the document, how positive or negative its language is on a 1 to 5 scale. The balance of points shown with the takes weighs what the document actually discloses, so the two can disagree, for example when a trial that missed its main goal is described in upbeat language.

Rhea-AI Summary

IREN (NASDAQ: IREN) released its August 2025 monthly update, highlighting significant expansion in its AI Cloud and Bitcoin mining operations. The company is scaling its AI Cloud from 1.9k to 10.9k NVIDIA GPUs, with ~9k Blackwell GPUs scheduled for delivery at Prince George. IREN secured $200 million in non-dilutive GPU financing and achieved NVIDIA Preferred Partner status.

In Bitcoin mining, IREN maintained an average operating hashrate of 44.0 EH/s, mining 668 BTC with hardware profits of $50.8m and a 66% margin. The AI Cloud segment generated $2.4m in revenue with a 98% hardware profit margin. The company's expansion includes development across British Columbia (160MW), Childress (750MW), and Sweetwater (2,000MW) facilities, with capacity for over 60,000 GPUs across British Columbia campuses.

Loading...
Loading translation...

Positive

  • Secured $200m non-dilutive GPU financing covering 100% of purchase price
  • AI Cloud expansion from 1.9k to 10.9k NVIDIA GPUs with potential $200-250m annualized revenue by Dec 2025
  • Achieved NVIDIA Preferred Partner status
  • Generated $53.2m total hardware profit in August 2025
  • AI Cloud business showing 98% hardware profit margins
  • Substantial infrastructure capacity with >60k GPU potential across British Columbia

Negative

  • Bitcoin mining hashrate decreased from 45.4 EH/s to 44.0 EH/s month-over-month
  • Bitcoin mining hardware profit margin declined from 72% to 66% due to higher electricity costs
  • Monthly Bitcoin production dropped from 728 BTC to 668 BTC
  • Net electricity cost per Bitcoin mined increased to $38,791 from $32,266
Argus Sep 8 session
+0.15% close to close 0.8x rel. volume Open Argus
Details

News Market Reaction – IREN

On Sep 8, the day this news came out, IREN closed 0.15% above the previous close.

Data tracked by StockTitan Argus for the Sep 8 session.

AI-generated analysis. How Rhea-AI works. Not financial advice.

See more from StockTitan in Google Search and AI answers. Adds StockTitan as a preferred source · opens Google
Add on Google

NEW YORK, Sept. 08, 2025 (GLOBE NEWSWIRE) -- IREN Limited (NASDAQ: IREN) (together with its subsidiaries “IREN” or “the Company”) today published its monthly update for August 2025.

August Highlights

  • AI Cloud expanding to 10.9k NVIDIA GPUs (>80% Blackwells), supported by non-dilutive GPU financing
  • Expansion opportunity of >60k GPUs9 across British Columbia campuses, anchored by >20k at Prince George10
  • NVIDIA Preferred Partner status secured
  • Liquid-cooling installation at Prince George for GB300 NVL72 deployments

Cover

Key MetricsAug 25Jul 25*

Bitcoin Mining
Average operating hashrate44.0 EH/s45.4 EH/s
Bitcoin mined4668 BTC728 BTC
Revenue per Bitcoin mined$114,816$114,891
Net electricity cost per Bitcoin mined2($38,791)($32,266)*
Revenue$76.7m$83.6m
Net electricity costs1($25.9m)($23.5m)*
Hardware profit3$50.8m$60.1m
Hardware profit margin566%72%

AI Cloud
Revenue$2.4m$2.3m
Net electricity costs1($0.04m)($0.04m)
Hardware profit3$2.4m$2.3m
Hardware profit margin598%98%

*Restatement of July 2025 net electricity cost per Bitcoin mined reflects revised Childress net electricity cost based on invoice received post issue of July 2025 investor report.

Management Commentary

“Demand for our AI Cloud is accelerating as we prepare for the delivery of approximately 9,000 NVIDIA Blackwell GPUs over the coming months,” said Daniel Roberts, Co-Founder and Co-CEO of IREN.

“At Prince George, retrofits to support this expansion are progressing to schedule, with construction of a new liquid-cooled data center for NVIDIA GB300 NVL72 systems well underway. Following record fiscal year and quarterly earnings, we delivered another month of solid performance, generating $53m of hardware profit in August despite seasonal curtailment and electricity prices.”

Technical Commentary

AI Cloud

  • NVIDIA Preferred Partner status secured – supporting ongoing customer expansion and diversification, with current fleet deployed across leading AI ecosystem partners including Together AI, Hume, and Fluidstack
  • 10.9k GPU expansion underway – scaling from 1.9k to 10.9k NVIDIA GPUs, including ~9k Blackwell GPUs scheduled for delivery at Prince George over the coming months (targeting $200-250m annualized revenue by Dec 20257)
  • Capital-efficient growth through GPU financing – ~$200m of non-dilutive GPU financing secured, representing 100% of the purchase price of the underlying GPUs, with additional financing workstreams ongoing
  • Customer pipeline progressing – active engagement with hyperscaler and non-hyperscaler customers across the full site portfolio, spanning powered shells, turnkey colocation, and cloud services

Bitcoin Mining

  • Robust hardware profits – delivered >$1.6m in average daily hardware profits3 in August despite elevated summer electricity costs and lower average operating hashrate in part due to seasonal curtailment and planned site outages, including for BC Hydro line upgrade and energization of the second bulk substation at Childress
  • Substantial cashflow generation – 50 EH/s currently producing >$1bn in annualized revenue8

Events

  • FY25 Results Webcast
    Replay available here
  • All-In Summit
    Los Angeles, September 7-9, 2025
  • H.C. Wainwright Investment Conference
    New York, September 9-10, 2025
  • YOTTA, Digital Infrastructure Conference
    Las Vegas, September 9-10, 2025
  • AI Infra Summit
    Santa Clara, September 10-11, 2025

Schwab

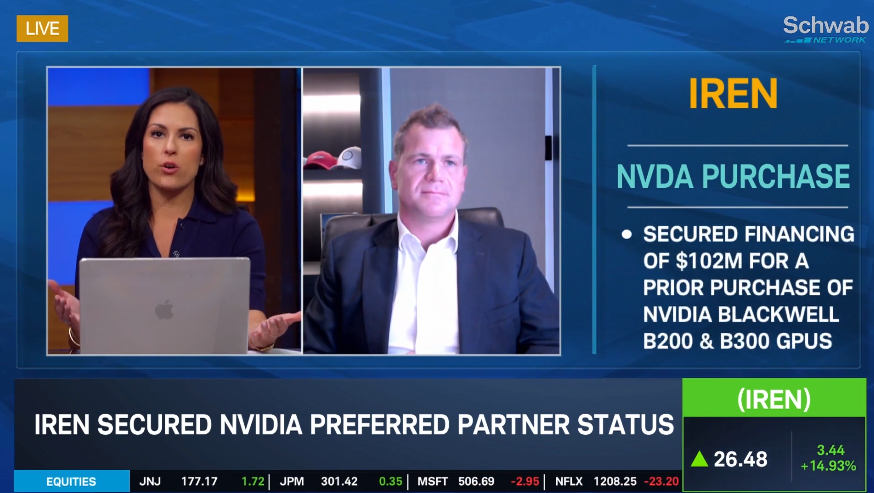

Daniel Roberts (Co-founder & Co-CEO) on Schwab Network (August 2025)

Project Update

IREN - 2025 Aug - PG-16
Prince George Data Center (August 2025)

Horizon

Horizon 1 & 2 (August 2025)

SW2

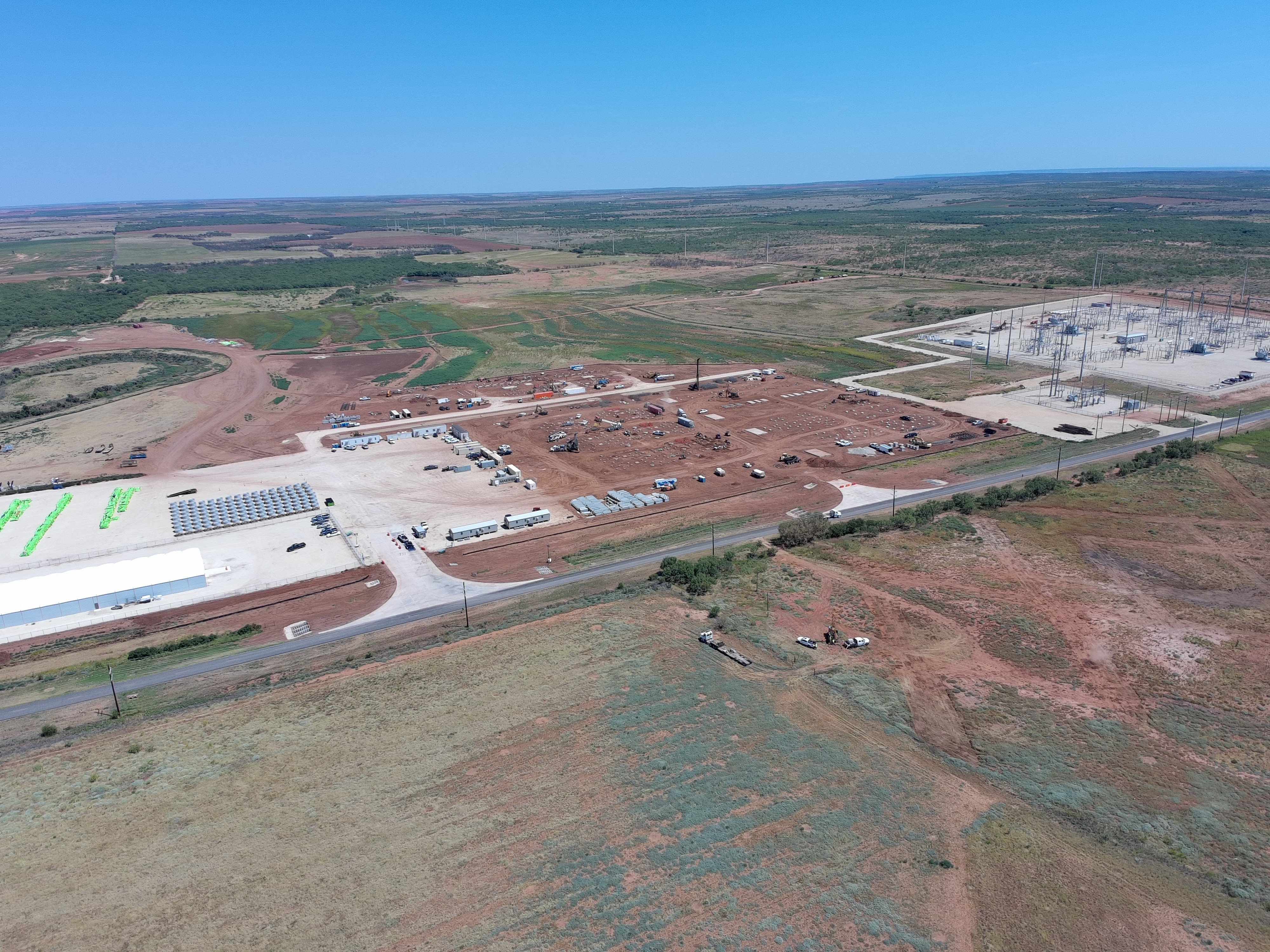

Sweetwater 1 (September 2025)

British Columbia (160MW)

  • 160MW of operating data centers across three campuses (capacity for >60k GPUs9)
  • Transitioning ASICs to GPUs at Prince George (capacity for >20k GPUs10)
  • Construction progressing for new 10MW (IT load) liquid-cooled data center at Prince George (capacity for >4.5k GB300s11)
  • Installing power redundancy for all GPUs

Childress (750MW)

  • 650MW of operating data centers
  • Second bulk substation transformer energized to support Horizon 1 & 2 (100MW IT load)
  • Horizon 1 on track for Q4 2025 delivery; data center halls & liquid cooling plant under construction
  • Horizon 2 site works & procurement underway

Sweetwater (2,000MW)

  • Design work complete for direct fiber loop connecting Sweetwater 1 (1,400MW) and 2 (600MW)
  • Construction of bulk power station and first primary substation progressing at Sweetwater 1 to achieve Apr 2026 energization
  • Sweetwater 2 targeting late 2027 energization

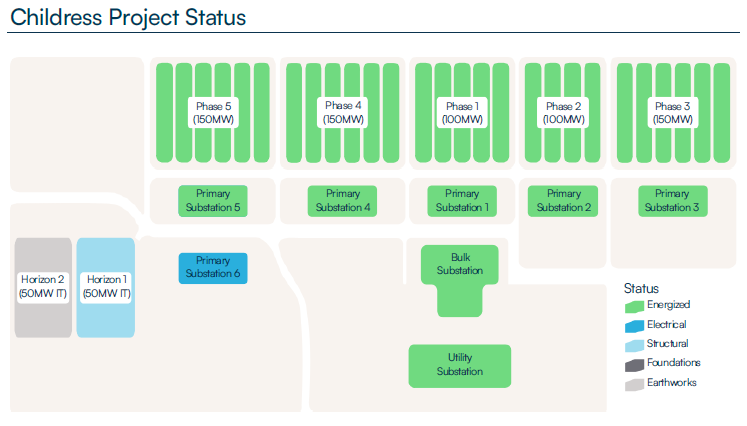

Childress Project Status

Childress Project Status

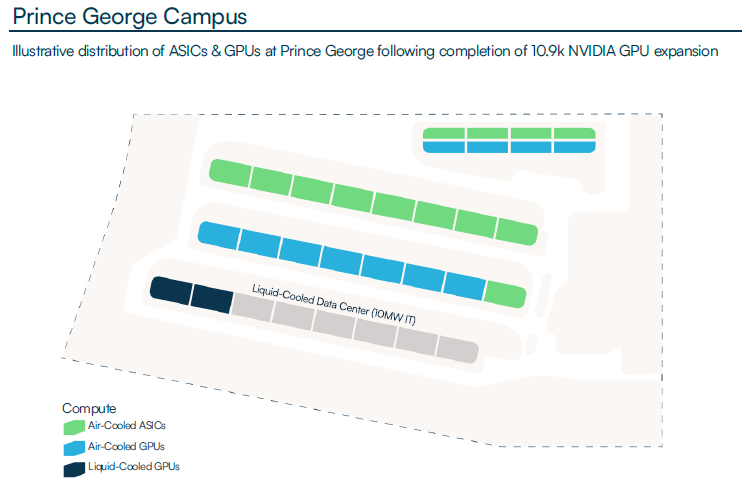

Prince George Campus

Prince George Campus

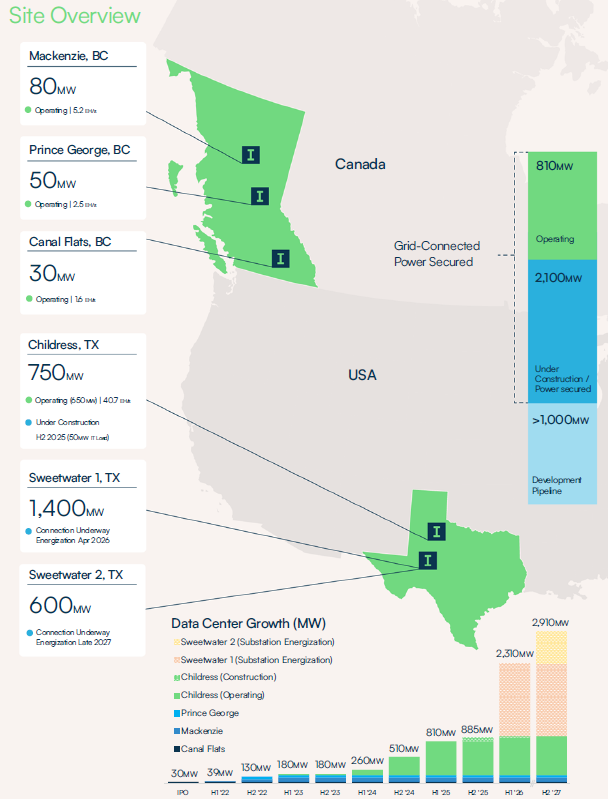

Site Overview

Site Overview

Assumptions and Notes

  1. Total net electricity costs are presented on a net basis and calculated as GAAP electricity charges, demand response program revenue and demand response fees. Figures are based on current internal estimates and exclude Renewable Energy Certificate (“REC”) purchases.
  2. Net electricity costs per Bitcoin mined is calculated as Net electricity costs for Bitcoin mining divided by Bitcoin mined.
  3. Hardware profit is calculated as revenue less net electricity costs. Average daily hardware profit reflects total monthly Bitcoin mining hardware profit divided by the number of days in the applicable period. Hardware profit is a non-GAAP financial measure and is provided in addition to, and not as a substitute for, measures of financial performance prepared in accordance with GAAP. Refer to the Forward-Looking Statements disclaimer.
  4. Bitcoin and Bitcoin mined in this investor update are presented in accordance with our revenue recognition policy which is determined on a Bitcoin received basis (post deduction of mining pool fees).
  5. Hardware profit margin for Bitcoin Mining and AI Cloud is calculated as revenue less net electricity costs, divided by revenue (for each respective revenue stream) and excludes all other costs.
  6. AI Cloud annualized revenue reflects weighted average price per GPU hour (including storage and ancillaries) for contracted GPUs as of August 31, 2025, multiplied 8,760 hours per year.
  7. AI Cloud annualized revenue is presented as an illustrative measure of potential revenue based on a 10.9k GPU deployment. It is not fully contracted, there can be no assurance that it will be achieved, and actual revenue may differ materially. Assumes on time delivery and commissioning of GPUs.
  8. Bitcoin Mining annualized revenue of >$1bn is presented as an illustrative measure of potential revenue of 50EH/s mining capacity based on the following assumptions: Bitcoin price of $115k, hardware operates at 100% uptime, network hashrate of 928 EH/s, block reward of 3.125 Bitcoin and transaction fees of 0.1 Bitcoin per block. Source: CoinWarz Bitcoin Mining Calculator.
  9. >60k Blackwell GPUs reflects internal estimate of capacity based on 160MW power capacity, 1.1 PUE across British Columbia sites and NVIDIA B200 reference architecture.
  10. >20k Blackwell GPUs reflects internal estimate of capacity based on 50MW power capacity at Prince George, 1.1 PUE and NVIDIA B200 reference architecture.
  11. >4.5k GB300s reflects internal estimate of capacity based on 10MW (IT load) power capacity at Prince George liquid-cooled data center.

Reconciliation of Non-GAAP metrics

 UnitsAug 25Jul 25*
Electricity charges$’m(27.2)(24.7)
Add/(deduct) the following:
Demand response program revenue$’m1.31.3
Demand response program fees$’m(0.1)(0.1)
Total net electricity costs1$’m(26.0)(23.5)
Net electricity costs – Bitcoin mining1$’m(25.9)(20.4)
Total Bitcoin mined#668728
Net electricity costs per Bitcoin mined2$(38,791)(32,266)

Bitcoin mining revenue$’m76.783.6
Add/(deduct) the following:
Net electricity costs – Bitcoin mining1$’m(25.9)(23.5)
Bitcoin mining Hardware Profit3$’m50.860.1
Bitcoin mining Hardware Profit Margin5%66%72%

AI Cloud Services revenue$’m2.42.3
Add/(deduct) the following:
Net electricity costs – AI Cloud Services1$’m(0.04)(0.04)
Al Cloud Services Hardware Profit3$’m2.42.3
Al Cloud Services Hardware Profit Margin5%98%98%

Total Hardware Profit3$’m53.262.4
*Restatement of July 2025 net electricity cost per Bitcoin mined from $27,976 to $32,266 reflects final Childress net electricity cost based on invoice received post issue of July 2025 investor report.

Contacts

Media

Megan Boles
Aircover Communications
+1 562 537 7131
megan.boles@aircoverpr.com

Jon Snowball
Sodali & Co
+61 477 946 068
+61 423 136 761
Investors

Mike Power
IREN
mike.power@iren.com

To keep updated on IREN’s news releases and SEC filings, please subscribe to email alerts at https://iren.com/investor/ir-resources/email-alerts.

Forward-Looking Statements

This investor update includes “forward-looking statements” within the meaning of Section 27A of the Securities Act of 1933, as amended (“Securities Act”), and Section 21E of the Securities Exchange Act of 1934, as amended (“Exchange Act”), that involve substantial risks and uncertainties. Forward-looking statements include information concerning possible or assumed future results of operations, including descriptions of our business plan and strategies and trends we expect to affect our business. These statements often include words such as “anticipate,” “expect,” “suggests,” “plan,” “believe,” “intend,” “estimates,” “targets,” “projects,” “should,” “potential,” “could,” “would,” “may,” “will,” “forecast,” and other similar expressions. Forward-looking statements may also be made, verbally or in writing, by members of our Board or management team. Such statements are subject to the same limitations, uncertainties, assumptions and disclaimers set out in this investor update.

Forward-looking statements may also be made, verbally or in writing, by members of our Board or management team in connection with this investor update. Such statements are subject to the same limitations, uncertainties, assumptions and disclaimers set out in this document. We base these forward-looking statements or projections on our current expectations, plans and assumptions that we have made in light of our experience in the industry, as well as our perceptions of historical trends, current conditions, expected future developments and other factors we believe are appropriate under the circumstances and at such time. The forward-looking statements are subject to and involve risks, uncertainties and assumptions and you should not place undue reliance on these forward-looking statements. Although we believe that these forward-looking statements are based on reasonable assumptions at the time they are made, you should be aware that many factors could affect our actual financial results or results of operations, and could cause actual results to differ materially from those expressed in the forward-looking statements. Factors that may materially affect such forward-looking statements include, but are not limited to: Bitcoin price and foreign currency exchange rate fluctuations; our ability to obtain additional capital on commercially reasonable terms and in a timely manner to meet our capital needs and facilitate our expansion plans; the terms of any future financing or any refinancing, restructuring or modification to the terms of any future financing, which could require us to comply with onerous covenants or restrictions, and our ability to service our debt obligations, any of which could restrict our business operations and adversely impact our financial condition, cash flows and results of operations; our ability to successfully execute on our growth strategies and operating plans, including our ability to continue to develop our existing data center sites, design and deploy direct-to-chip liquid cooling systems, and diversify and expand into the market for high-performance computing (“HPC”) solutions (including the market for AI Cloud and potential colocation services such as powered shell, build-to-suit and turnkey data centers (“Colocation Services”) (collectively “HPC and AI services”)); our limited experience with respect to new markets we have entered or may seek to enter, including the market for HPC and AI services); our ability to remain competitive in dynamic and rapidly evolving industries; expectations with respect to the ongoing profitability, viability, operability, security, popularity and public perceptions of the Bitcoin network; expectations with respect to the useful life and obsolescence of hardware (including hardware for Bitcoin mining and any current or future HPC and AI services we offer); delays, increases in costs or reductions in the supply of equipment used in our operations including as a result of tariffs and duties, and certain equipment being in high demand due to global supply chain constraints; expectations with respect to the profitability, viability, operability, security, popularity and public perceptions of any current and future HPC and AI services we offer; our ability to secure and retain customers on commercially reasonable terms or at all, particularly as it relates to our strategy to expand into markets for HPC and AI services; our ability to establish and maintain a customer base for our HPC and AI services business and customer concentration; our ability to manage counterparty risk (including credit risk) associated with any current or future customers, including customers of our HPC and AI services and other counterparties; the risk that any current or future customers, including customers of our HPC and AI services or other counterparties, may terminate, default on or underperform their contractual obligations; changing political and geopolitical conditions, including changing international trade policies and the implementation of wide-ranging, reciprocal and retaliatory tariffs, surtaxes and other similar import or export duties, or trade restrictions; Bitcoin global hashrate fluctuations; our ability to secure renewable energy, renewable energy certificates, power capacity, facilities and sites on commercially reasonable terms or at all; delays associated with, or failure to obtain or complete, permitting approvals, grid connections and other development activities customary for greenfield or brownfield infrastructure projects; our reliance on power and utilities providers, third party mining pools, exchanges, banks, insurance providers and our ability to maintain relationships with such parties; expectations regarding availability and pricing of electricity; our participation and ability to successfully participate in demand response products and services and other load management programs run, operated or offered by electricity network operators, regulators or electricity market operators; the availability, reliability and/or cost of electricity supply, hardware and electrical and data center infrastructure, including with respect to any electricity outages and any laws and regulations that may restrict the electricity supply available to us; any variance between the actual operating performance of our miner hardware achieved compared to the nameplate performance including hashrate; electricity market risks relating to changes in regulations and requirements of market operators and regulatory bodies, including with respect to grid stability, interconnection and curtailment obligations; our ability to curtail our electricity consumption and/or monetize electricity depending on market conditions, including changes in Bitcoin mining economics and prevailing electricity prices; actions undertaken by electricity network and market operators, regulators, governments or communities in the regions in which we operate; the availability, suitability, reliability and cost of internet connections at our facilities; our ability to secure additional hardware, including hardware for Bitcoin mining and any current or future HPC and AI services we offer, on commercially reasonable terms or at all, and any delays or reductions in the supply of such hardware or increases in the cost of procuring such hardware; our ability to operate in an evolving regulatory environment; our ability to successfully operate and maintain our property and infrastructure; reliability and performance of our infrastructure compared to expectations; malicious attacks on our property, infrastructure or IT systems; our ability to maintain in good standing the operating and other permits and licenses required for our operations and business; our ability to obtain, maintain, protect and enforce our intellectual property rights and confidential information; any intellectual property infringement and product liability claims; whether the secular trends we expect to drive growth in our business materialize to the degree we expect them to, or at all; any pending or future acquisitions, dispositions, joint ventures or other strategic transactions; the occurrence of any environmental, health and safety incidents at our sites, and any material costs relating to environmental, health and safety requirements or liabilities; damage to our property and infrastructure and the risk that any insurance we maintain may not fully cover all potential exposures; ongoing proceedings relating to the default under certain equipment financing facilities, ongoing securities litigation, and any future litigation, claims and/or regulatory investigations, and the costs, expenses, use of resources, diversion of management time and efforts, liability and damages that may result therefrom; our failure to comply with any laws including the anti-corruption laws of the United States and various international jurisdictions; any failure of our compliance and risk management methods; any laws, regulations and ethical standards that may relate to our business, including those that relate to Bitcoin and the Bitcoin mining industry and those that relate to any other services we offer, including laws and regulations related to data privacy, cybersecurity and the storage, use or processing of information and consumer laws; our ability to attract, motivate and retain senior management and qualified employees; increased risks to our global operations including, but not limited to, political instability, acts of terrorism, theft and vandalism, cyberattacks and other cybersecurity incidents and unexpected regulatory and economic sanctions changes, among other things; climate change, severe weather conditions and natural and man-made disasters that may materially adversely affect our business, financial condition and results of operations; public health crises, including an outbreak of an infectious disease and any governmental or industry measures taken in response; damage to our brand and reputation; evolving stakeholder expectations and requirements relating to environmental, social or governance (“ESG”) issues or reporting, including actual or perceived failure to comply with such expectations and requirements; that we do not currently pay any cash dividends on our Ordinary shares, and may not in the foreseeable future and, accordingly, your ability to achieve a return on your investment in our Ordinary shares will depend on appreciation, if any, in the price of our Ordinary shares; and other important factors discussed under the caption “Risk Factors” in IREN’s annual report on Form 10-K filed with the SEC on August 28, 2024 as such factors may be updated from time to time in its other filings with the SEC, accessible on the SEC’s website at www.sec.gov and the Investor Relations section of IREN’s website at https:// investors.iren.com.

The foregoing list of factors is not exhaustive and does not necessarily include all of the important factors that could cause actual results to differ materially from those expressed in any of our forward-looking statements. The forward-looking statements included in this investor update are made only as of the date of this investor update and should be read carefully in conjunction with other uncertainties and potential events described in “Item 1A. Risk Factors” in our Annual Report on Form 10-K, filed with Securities and Exchange Commission (the “SEC”) on August 28, 2025 and our other filings with the SEC. Except as required by law, we do not undertake any obligation to update any forward-looking statements to reflect subsequent events or circumstances.

Preliminary Financial Information

The financial information presented in this investor update is not subject to the same closing procedures as our unaudited quarterly financial results and our audited annual financial results, and has not been reviewed or audited by our independent registered public accounting firm. The preliminary financial information included in this investor update does not represent a comprehensive statement of our financial results or financial position and should not be viewed as a substitute for unaudited financial statements prepared in accordance with International Financial Reporting Standards. Accordingly, you should not place undue reliance on the preliminary financial information included in this investor update.

Non-GAAP Financial Measures​

This investor update includes non-GAAP financial measures, including net electricity costs, net electricity costs per Bitcoin mined, hardware profit, hardware profit margin, Bitcoin Mining annualized revenue and AI Cloud annualized revenue. We provide these measures in addition to, and not as a substitute for, measures of financial performance prepared in accordance with GAAP. There are a number of limitations related to the use of non-GAAP financial measures. For example, other companies, including companies in our industry, may calculate these measures differently. The Company believes that these measures are important and supplement discussions and analysis of its results of operations and enhances an understanding of its operating performance.​

Net electricity costs are calculated as GAAP electricity charges, demand response program revenue and demand response fees. Figures are based on current internal estimates and excludes the cost of RECs. Net electricity costs per Bitcoin mined is calculated as Net electricity costs for Bitcoin mining divided by Bitcoin mined. Hardware Profit is calculated as revenue less net electricity costs (excludes all other site, overhead and REC costs). Hardware Profit Margin is calculated as revenue less net electricity costs divided by revenue (excludes all other site, overhead and REC costs).

Photos accompanying this announcement are available at:
https://www.globenewswire.com/NewsRoom/AttachmentNg/081e100c-6a84-4a3f-a5f2-b2a09fcee630
https://www.globenewswire.com/NewsRoom/AttachmentNg/ba1299cd-e73b-4a9b-99ef-93af22fb2f1b
https://www.globenewswire.com/NewsRoom/AttachmentNg/97b0529d-c28e-4476-b516-c35fa8d07bb8
https://www.globenewswire.com/NewsRoom/AttachmentNg/fdf63a15-8d7b-4e1f-b2b0-1dcc65882186
https://www.globenewswire.com/NewsRoom/AttachmentNg/82829a41-fbb8-48d0-b1a6-6e3b080cf0dc
https://www.globenewswire.com/NewsRoom/AttachmentNg/09fde392-3b48-4ce8-af4a-e51eee9aca20
https://www.globenewswire.com/NewsRoom/AttachmentNg/74edac46-13cf-4665-9a7b-f0c901dd85c7
https://www.globenewswire.com/NewsRoom/AttachmentNg/3ebdb848-5a79-444c-b883-4af5b6b36083

FAQ

AI-generated questions and answers. How Rhea-AI works. Not financial advice.

What is IREN's current AI Cloud expansion plan and timeline?

IREN is expanding from 1.9k to 10.9k NVIDIA GPUs, including ~9k Blackwell GPUs at Prince George, targeting $200-250m annualized revenue by December 2025. The expansion is supported by $200m in non-dilutive GPU financing.

How many Bitcoin did IREN mine in August 2025 and at what cost?

IREN mined 668 Bitcoin in August 2025 at a net electricity cost of $38,791 per Bitcoin, generating $76.7m in mining revenue with a 66% hardware profit margin.

What is IREN's total data center capacity across its facilities?

IREN operates 160MW in British Columbia (capacity for >60k GPUs), 750MW at Childress, and is developing 2,000MW at Sweetwater, with Sweetwater 1 (1,400MW) targeting April 2026 energization.

How profitable is IREN's AI Cloud business compared to Bitcoin mining?

IREN's AI Cloud business achieved a 98% hardware profit margin in August 2025, generating $2.4m revenue, compared to Bitcoin mining's 66% margin with $76.7m revenue.

What is IREN's relationship status with NVIDIA?
