Ivanhoe Mines Reports 71,266 Tonnes of Copper Produced by Kamoa-Kakula in Q3 2025; Recovery Efforts Advancing Well
Ivanhoe Mines (OTCQX: IVPAF) reported Q3 2025 operational results: combined Phase 1–3 concentrators milled 3.46 Mt and produced 71,266 tonnes of copper in concentrate, with year-to-date copper at 316,393 t. The company maintained 2025 copper guidance of 370,000–420,000 t. Stage Two dewatering at Kakula is >20% complete and expected to finish end-November 2025; full mine dewatering is projected by February 2026. Heat-up of the on-site, 500 ktpa direct-to-blister smelter is due in early November; unsold concentrate inventory stood at 59,000 t on Sept 30, 2025.
Kipushi set a quarterly zinc record (reported 57,200 t), following an August debottlenecking program.
Ivanhoe Mines (OTCQX: IVPAF) ha riportato i risultati operativi del terzo trimestre 2025: i concentratori combinati delle fasi 1–3 hanno macinato 3,46 Mt e hanno prodotto 71.266 tonnellate di rame in concentrato, con rame da inizio anno pari a 316.393 t. L'azienda ha mantenuto la guidance 2025 per il rame tra 370.000–420.000 t. L'evacuazione di Stadio Due a Kakula è >20% completa e si prevede che termini entro la fine di novembre 2025; l'evacuazione completa della miniera è prevista per febbraio 2026. L'accensione dell'impianto onsite da 500 ktpa direct-to-blister è prevista all'inizio di novembre; l'inventario di concentrato invenduto ammontava a 59.000 t al 30 settembre 2025.
Kipushi ha registrato un record trimestrale di zinco (riportato 57.200 t), a seguito di un programma di debottlenecking di agosto.
Ivanhoe Mines (OTCQX: IVPAF) informó resultados operativos del tercer trimestre de 2025: los concentradores combinados de las fases 1–3 molieron 3,46 Mt y produjeron 71.266 toneladas de cobre en concentrado, con cobre acumulado en el año de 316.393 t. La empresa mantuvo la guía de cobre para 2025 en 370.000–420.000 t. El drenaje de la Etapa Dos en Kakula está >20% completo y se espera que termine a finales de noviembre de 2025; se proyecta el drenaje completo de la mina para febrero de 2026. El calentamiento de la planta in situ de 500 ktpa direct-to-blister está previsto para principios de noviembre; el inventario de concentrado no vendido fue de 59.000 t al 30 de septiembre de 2025.
Kipushi estableció un récord trimestral de zinc (informado 57.200 t), tras un programa de descongestionamiento/debottlenecking de agosto.
Ivanhoe Mines (OTCQX: IVPAF)는 2025년 3분기 운영 실적을 발표했습니다: 1–3단계 컨센트레이터 합산으로 물질량은 3.46 Mt를 기록했고, 구리 71,266톤을 구리집광으로 생산했으며 연간 누적 구리는 316,393 t입니다. 회사는 2025년 구리 가이던스를 370,000–420,000 t로 유지했습니다. Kakula의 단계 2 탈수는 20% 이상 완료되었고 2025년 11월 말에 완료될 예정이며, 광산의 전체 탈수는 2026년 2월까지 완료될 것으로 예상됩니다. 현장 500 ktpa의 직접-블리스터(direct-to-blister) 제련소의 예열은 11월 초에 시작될 예정이며, 2025년 9월 30일 기준 미판매 정광 재고량은 59,000 t입니다.
Kipushi는 8월 디보터넥킹 프로그램 이후 1분기 아연 기록을 세웠습니다(보고된 57,200 t).
Ivanhoe Mines (OTCQX: IVPAF) a publié les résultats opérationnels du T3 2025 : les concentrateurs combinés des phases 1 à 3 ont moulu 3,46 Mt et ont produit 71 266 tonnes de cuivre en concentré, avec 316 393 t de cuivre cumulées à ce jour. L'entreprise a maintenu sa guidance cuivre 2025 entre 370 000 et 420 000 t. Le drainage de la Stage Two à Kakula est >20% terminé et devrait s'achever fin novembre 2025 ; le drainage minier complet est prévu pour février 2026. Le réchauffement de l'usine sur site, le convertisseur direct-to-blister de 500 ktpa, est prévu début novembre ; l'inventaire de concentré invendu était de 59 000 t au 30 septembre 2025.
Kipushi a établi un record trimestriel de zinc (rapporté 57 200 t), à la suite d'un programme de débottellement d'août.
Ivanhoe Mines (OTCQX: IVPAF) berichtete operative Ergebnisse für Q3 2025: kombinierte Phase-1–3 Konzentratoren mahlten 3,46 Mt und produzierten 71.266 Tonnen Kupfer im Konzentrat, bei 316.393 t Kupfer kumuliert bis dato. Das Unternehmen bestätigte die Kupferprognose für 2025 von 370.000–420.000 t. Stage Two Dewatering bei Kakula ist zu >20% abgeschlossen und soll Ende November 2025 beendet werden; das vollständige Entwässern der Mine wird voraussichtlich bis Februar 2026 abgeschlossen. Das Aufheizen des vor Ort vorhandenen Direct-to-Blister-Schmelzs mit 500 ktpa ist für Anfang November vorgesehen; der unverkaufte Konzentratsbestand lag am 30. September 2025 bei 59.000 t.
Kipushi setzte einen Quartalsrekord bei Zink (gemeldet 57.200 t), nach einem August-Entlastungsprogramm.
ايفانو ماينز (OTCQX: IVPAF) أبلغت عن نتائج تشغيلية للربع الثالث من عام 2025: مُصَغِّرات المراحل 1–3 المجمَّعة طحنت 3.46 Mt وأنتجت 71,266 طنًا من النحاس في المركز، مع النحاس التراكمي حتى تاريخه 316,393 t. حافظت الشركة على توجيهات النحاس لعام 2025 بين 370,000–420,000 t. تغطية Stage Two لإزالة الماء في Kakula أكثر من 20% مكتملة ومن المتوقع أن تنتهي بنهاية نوفمبر 2025؛ من المتوقع إتمام إزالة الماء من المنجم بالكامل بحلول فبراير 2026. من المتوقع أن يبدأ تسخين المصهر المباشر إلى البلستر بمقدار 500 ktpa في أوائل نوفمبر؛ وكانت مخزون المركز غير المبيع حتى 30 سبتمبر 2025 يبلغ 59,000 t.
Kipushi حصدت رقمًا قياسيًا ربع سنويًا في الزنك (المبلغ عنه 57,200 t) عقب برنامج إزالة الاختناقات في أغسطس.
Ivanhoe Mines (OTCQX: IVPAF) 报告了 2025 年第 3 季运营业绩:阶段 1–3 的联合选矿厂磨矿量为 3.46 Mt,铜精矿产量为 71,266 吨,迄今为止年度铜产量为 316,393 t。公司维持 2025 年铜的指引区间为 370,000–420,000 t。Kakula 的二阶段排水已完成 >20%,预计于 2025 年11月末完成;矿山的全面排水预计在 2026 年 2 月完成。现场 500 ktpa 直接出 Blister 冶炼厂的升温计划在 11 月初开始;截至 2025 年 9 月 30 日,未售出精矿库存为 59,000 t。
Kipushi 创下季度锌产量纪录(披露为 57,200 t),这是在 8 月去瓶颈化计划之后。
- Q3 copper production of 71,266 tonnes
- YTD copper of 316,393 tonnes
- Maintained 2025 guidance of 370,000–420,000 tonnes
- Kipushi zinc record quarterly production of 57,200 tonnes
- Smelter heat-up scheduled in early November 2025
- Combined feed grade declined to 2.47% Cu in Q3 2025 (vs 3.58% in Q2 2025)
- Combined copper recovery fell to 82.7% in Q3 2025 (from 85.4% in Q2)
- Stage Two dewatering only 20% complete; full dewatering expected Feb 2026
- Unsold concentrate inventory of 59,000 tonnes as of Sept 30, 2025
Stage Two dewatering advancing on schedule; approximately
Start-up of Africa's largest copper smelter to commence in early November
Kipushi produced a record 57,200 tonnes of zinc in Q3 2025, a quarterly increase of
First platinum-palladium-nickel-gold-rhodium-copper production from Platreef Phase 1 expected in Q4 2025; Phase 2 development underway
Ivanhoe Mines to issue Q2 2025 financial results after market close on October 29; host conference call for investors on October 30
Johannesburg, South Africa--(Newsfile Corp. - October 7, 2025) - Ivanhoe Mines' (TSX: IVN) (OTCQX: IVPAF) Executive Co-Chair Robert Friedland and President and Chief Executive Officer Marna Cloete announced today the company's third-quarter production results and an update on operational and project activities.
During the third quarter, Kamoa-Kakula's Phase 1, 2, and 3 concentrators milled a total 3.46 million tonnes of ore, producing 71,226 tonnes of copper. Copper production year to date totaled 316,393 tonnes. Production guidance of 370,000 tonnes to 420,000 tonnes of copper in concentrate is maintained, with mining of higher-grade areas on the western side of the Kakula Mine expected from mid-November.
Stage Two dewatering activities are over
Smelter start-up is scheduled to commence in early November, as the installation of a 60 MW uninterruptible power supply (UPS) unit nears completion. The UPS will safeguard the smelter complex from potential power interruptions during the ramp-up period.
Production rates from Kipushi notably improved during the quarter following the completion of the debottlenecking program in August. In the third quarter, the Kipushi concentrator milled a record 168,862 tonnes of ore at an average milled grade of
Phase 1 operations at the Platreef Mine are expected to commence shortly, with the first feed of ore into the concentrator expected in the coming weeks. Project development work on the Phase 2 expansion is already underway, with the appointment of the engineering, procurement and construction management (EPCM) contractor in the fourth quarter. First production from the Phase 2 concentrator is targeted for Q4 2027.
Founder and Co-Chairman Robert Friedland commented:
"Our recovery efforts at the Kakula Mine are advancing well due to exceptional execution from our operating teams under a decisive plan of action put in place by our management team and joint-venture employees. We are on track to restore Kamoa-Kakula towards its previous copper production levels as we rehabilitate the existing workings and develop new high-grade areas across this Tier-One ore body. Insights gathered during the dewatering efforts will be combined with input from our world-class team of independent experts to design an updated mine plan that will chart Kamoa-Kakula's bright future as a leading producer in the copper industry.
"This quarter should mark a turning point in operations, as we anticipate higher grades from Kakula's western side from next month, with selective mining of the existing workings on the eastern side of Kakula planned from Q1 2026. We're also on the cusp of starting operations at Africa's largest and greenest, direct-to-blister copper smelter, which is expected to drive lower cash costs as we complete its ramp-up.
"In addition, we're extremely excited for imminent first production at the Platreef Mine, which is on schedule for later this month. Given rising prices and interest in platinum-group metals, we are bringing the world's next great precious metals complex online at an exceptionally opportune moment. Platreef's major endowment of nickel, copper, and gold makes it one of the lowest-cost and scalable producers of platinum, palladium, nickel, gold, rhodium and copper on our planet ... and we are already at work on a Phase 2 expansion that will propel Platreef into a Top 10 producer globally."
In preparation for the heat-up of Kamoa-Kakula's state-of-the-art, 500,000-tonne-per-annum, direct-to-blister copper smelter, an operator oversees a training exercise on the slag cleaning furnace blister ladles.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_002full.jpg
Summary of quarterly production data from Kamoa-Kakula
Q3 2024 | Q4 2024 | Q1 2025 | Q2 2025 | Q3 2025 | |||||
Phase 1 & 2 | |||||||||
Ore tonnes milled (000's tonnes) | 2,215 | 2,329 | 2,211 | 1,991* | 1,838 | ||||
Feed grade of ore processed (% copper) | |||||||||
Copper recovery (%) | |||||||||
Copper in concentrate produced (tonnes) | 94,214 | 102,042 | 97,575 | 71,401* | 37,744 | ||||
Phase 3 | |||||||||
Ore tonnes milled (000's tonnes) | 1,050 | 1,326 | 1,512 | 1,631 | 1,618 | ||||
Feed grade of ore processed (% copper) | |||||||||
Copper recovery (%) | |||||||||
Copper in concentrate produced (tonnes) | 22,099 | 31,777 | 35,545 | 40,608 | 33,522 | ||||
Combined Phase 1, 2, and 3 | |||||||||
Ore tonnes milled (000's tonnes) | 3,266 | 3,655 | 3,723 | 3,622 | 3,456 | ||||
Feed grade of ore processed (% copper) | |||||||||
Copper recovery (%) | |||||||||
Copper in concentrate produced (tonnes) | 116,313 | 133,819 | 133,120 | 112,009 | 71,266 |
Data in red denotes a quarterly record
*Phase 1 & 2 production was impacted in the second quarter by seismic activity at the Kakula Mine as announced on May 20, 2025.
Kakula head grades to improve in Q4 2025 as dewatering activities open up higher-grade mining areas
During the third quarter, the Phase 1, 2, and 3 concentrators milled 3.46 million tonnes of ore, producing 71,226 tonnes of copper. Total copper production year to date is 316,393 tonnes.
As announced on June 11, 2025, mining operations on the western side of the Kakula Mine restarted on June 7, 2025. Since mid-June, the mining rate has increased to an average rate of 350,000 tonnes per month (4.2 million tonnes on an annualized basis). To assist with the increase in the mining rates from the western side of the Kakula Mine, the cut-off grade has been lowered to
Mining on the western side of the Kakula Mine has been focused on higher-elevation areas in the north and southwest, where copper grades are lower than those of the higher-grade centre, which is currently submerged. From mid-November, mining crews plan to advance towards the centre of the western side of the Kakula Mine, improving head grades to between
The Phase 1 and 2 concentrators will continue to process ore from the western side of the Kakula Mine, as well as surface stockpiles, until Q1 2026, when the stockpiles are depleted. Thereafter, selective mining will commence within the existing workings on the eastern side of the Kakula Mine, which will augment rising production from higher-grade areas on Kakula's western side to underpin improved underground mining rates.
The Phase 3 concentrator milled 1.62 million tonnes of ore in the third quarter, producing 33,522 tonnes of copper. For a second consecutive quarter, the Phase 3 concentrator averaged a milling rate equivalent to 6.5 million tonnes annualized, which is
Stage Two dewatering of the Kakula Mine is advancing to plan at over
The four Stage Two high-capacity submersible pumps were commissioned over the course of two weeks between the end of August and mid-September. The four pumps are operating at the total design rate of approximately 2,600 litres per second. Including the mobile Stage One pump stations located underground, the total pumping rate at the Kakula Mine, has the potential to pump up to 6,400 litres per second, or 550 megalitres per day, subject to available underground access.
Stage Two dewatering of the Kakula Mine is over
To date, approximately 13 kilometres of lateral development has been rehabilitated. As the water level declines, the mining crews are primarily focused on rehabilitating the access drives required for repositioning the Stage One underground pumping infrastructure, as well as the access towards the Stage Three pump stations, which are currently submerged.
Stage Three pumping will complete the remaining dewatering below the water level accessible by the Stage Two high-capacity submersible pumps, as shown in Figure 1. The mining crews expect to start gaining access to the existing Stage Three pumping infrastructure from November. Each pump station will be refitted and recommissioned with new pump motors and associated electrical infrastructure. Stage Three pumping is expected to be complete in Q1 2026.

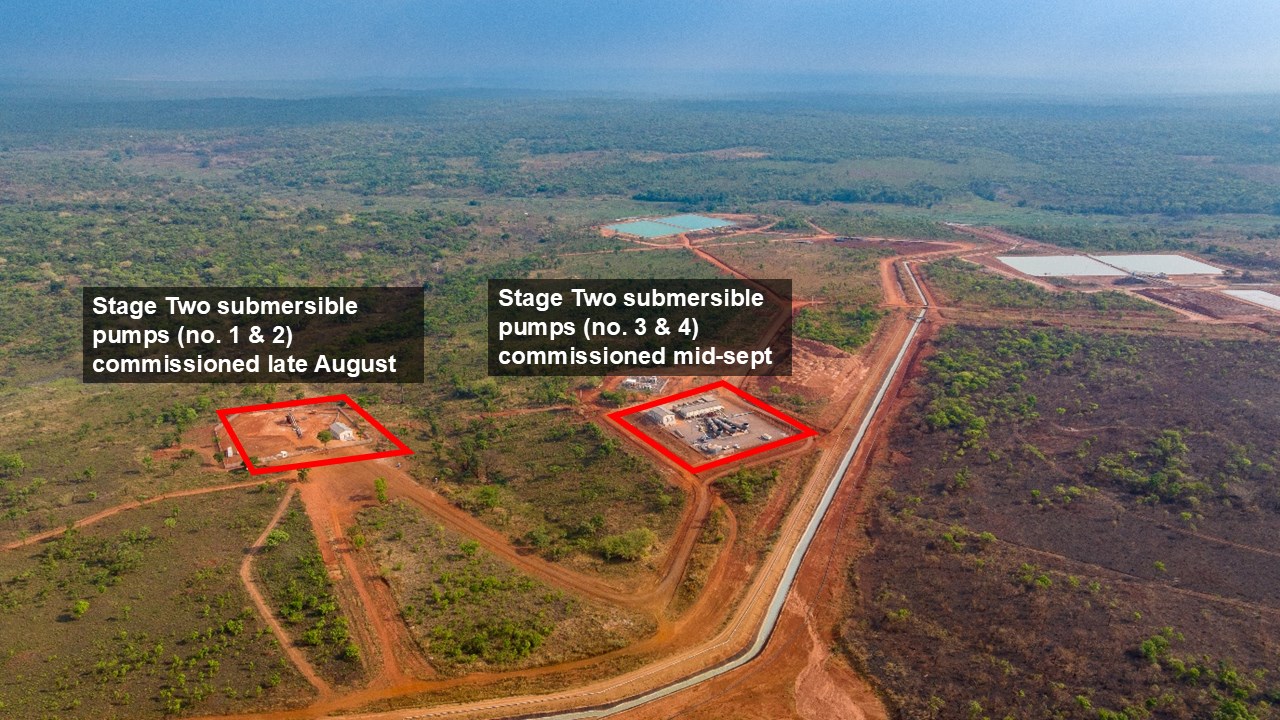

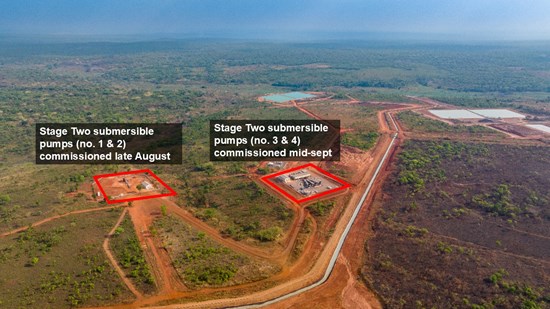

Aerial view looking south over the two adjacent sites where the four Stage Two high-capacity, submersible pumps were installed, in pairs, at the bottom of two existing 400-metre deep shafts.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_003full.jpg

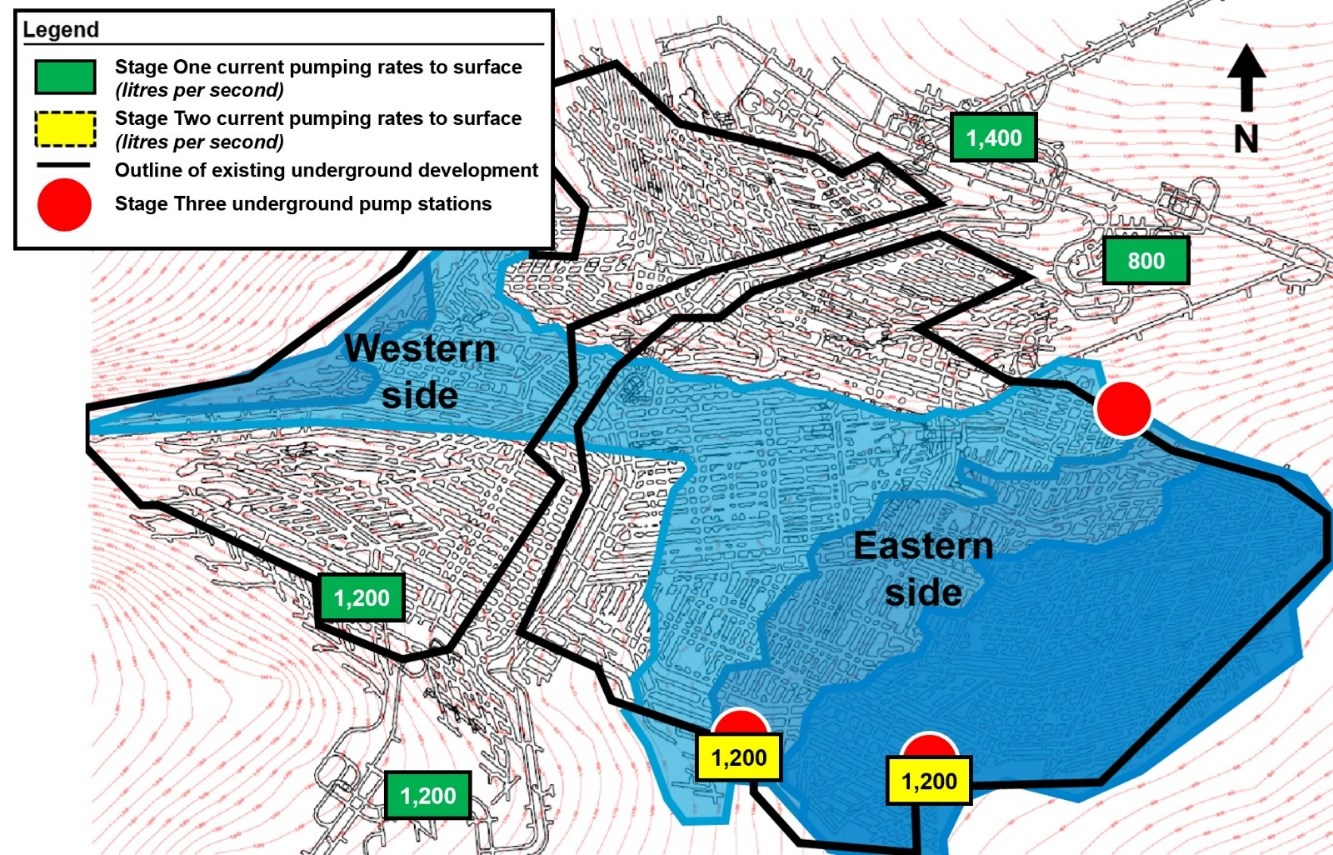

Figure 1. A schematic of the projected decrease in underground water levels at the Kakula Mine from the end of September (light blue) to the end of November 2025 (dark blue). Dewatering of the entire Kakula mine is expected to be completed in February 2026.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_004full.jpg

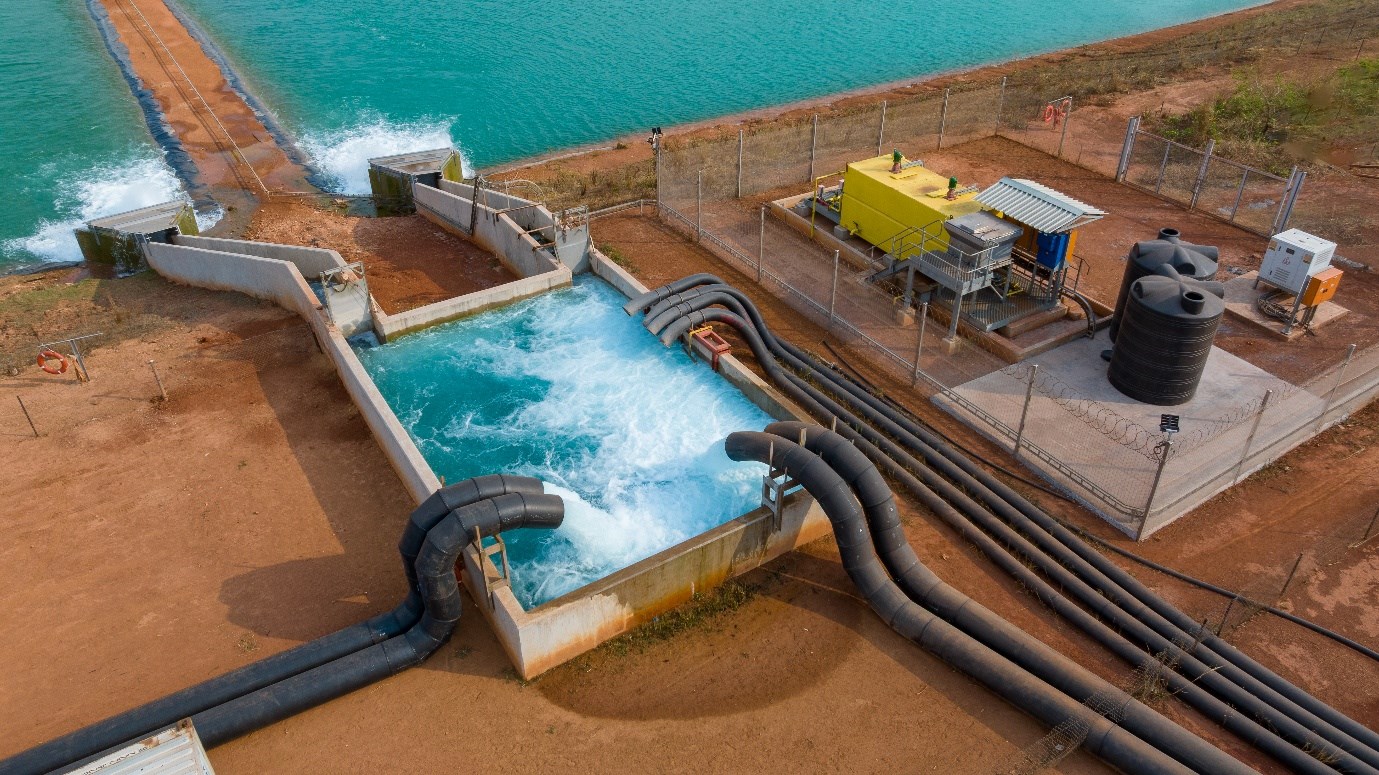

Water pumped out from the Kakula Mine is fed into nearby settling ponds. Stage Two dewatering of the Kakula Mine is expected to be complete at the end of November 2025.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_005full.jpg

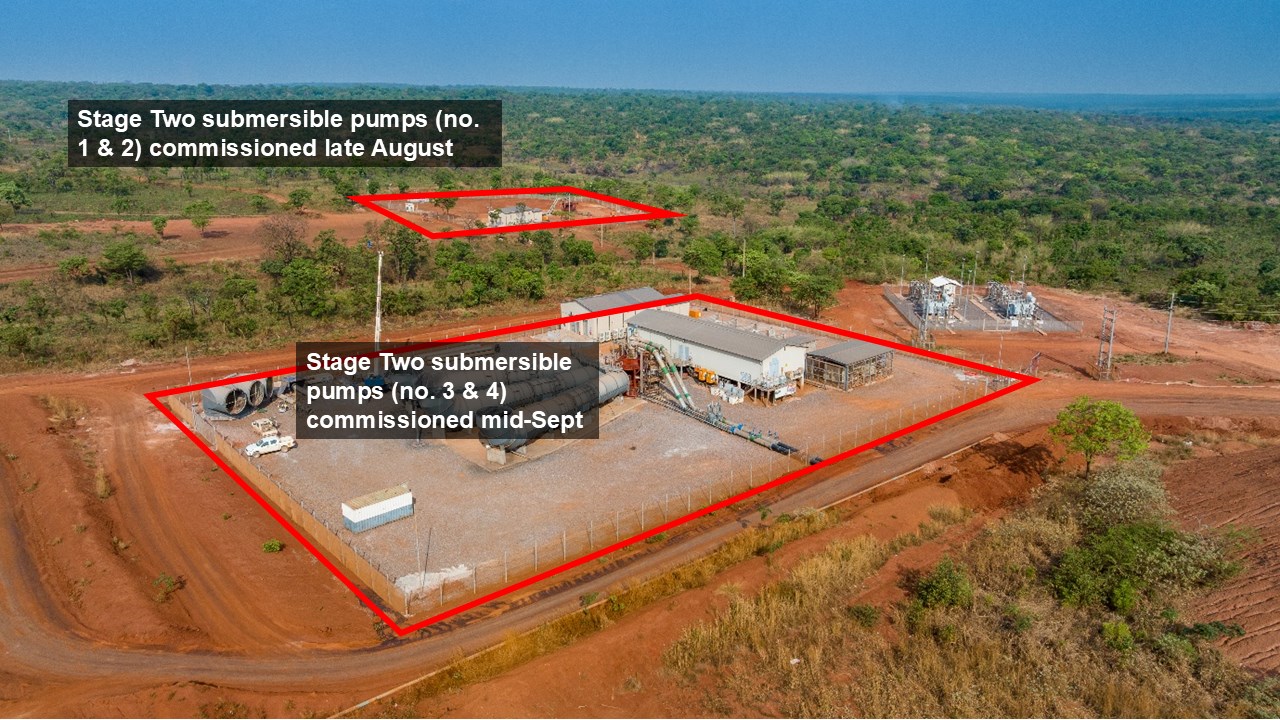

The two sites where the Stage Two dewatering infrastructure is located. Both sites were established, with all pumping infrastructure installed and commissioned within just 6 weeks.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_006full.jpg
Mine planning and scheduling is well advanced to support the ramp-up of underground mining activities from both the Kakula and Kamoa mines, with a medium-term target of returning the milling rate to 17 million tonnes per year, and ultimately targeting annualized copper production of over 550,000 tonnes
Copper production guidance for 2026 and 2027 will be released once sufficient physical inspection of the newly dewatered areas of the Kakula Mine has been completed. The new life-of-mine plan is expected to be released in Q1 2026.
Smelter start-up scheduled for early November; installation nearing completion of 60-megawatt, battery-powered, uninterruptible power supply facility
Heat-up of Kamoa-Kakula's on-site, direct-to-blister copper smelter is expected to commence in early November 2025. Kamoa-Kakula's management team expects to prioritize the processing of all concentrates produced by the Phase 1, 2, and 3 concentrators through the on-site smelter, with any excess concentrate continuing to be toll-treated at the nearby Lualaba Copper Smelter (LCS), in Kolwezi.
The smelter start-up will commence as the installation of the uninterruptible power supply (UPS) facility nears completion later this month. The 60 MW UPS is designed to provide up to 2 hours of instantaneous back-up power to the smelter, protecting the operation from voltage fluctuations in the DRC grid. In addition to the UPS, there is a further 60 MW of dedicated diesel-powered, back-up generator capacity.
There is sufficient on-site copper concentrate inventory for the smelter start-up in early November. As of September 30, 2025, Kamoa-Kakula's unsold copper in concentrate inventory totaled 59,000 tonnes, which includes 7,300 tonnes located at LCS. The first feed of concentrate into the smelter is expected approximately four to six weeks after heat-up commences.

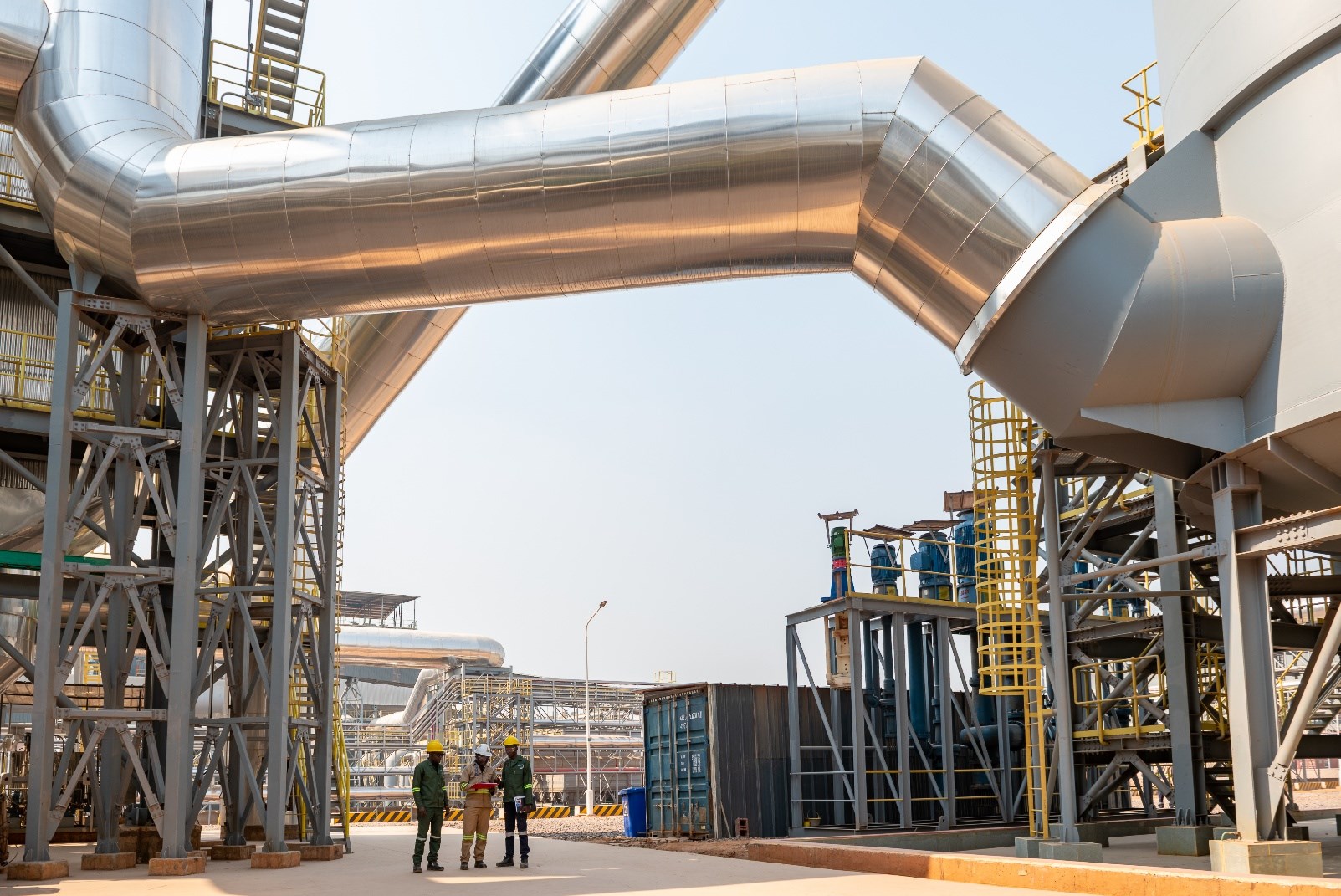

Members of the smelter team are inspecting the sulphuric acid plant ahead of the furnace heat-up. The smelter is expected to produce up to 700,000 tonnes per annum of high-strength sulphuric acid, which is in high demand across the Central African Copperbelt.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_007full.jpg
Kipushi concentrator produced record 52,700 tonnes of zinc in Q3 2025, following completion of the debottlenecking program, which was delivered under budget and ahead of schedule
Summary of quarterly production data from Kipushi
Q3 2024 | Q4 2024 | Q1 2025 | Q2 2025 | Q3 2025 | |
Kipushi Concentrator | |||||
Ore tonnes milled (tonnes) | 108,065 | 119,619 | 151,403 | 153,342 | 168,862 |
Feed grade of ore processed (% zinc) | 32.12 | 31.72 | 32.16 | 33.37 | 37.81 |
Zinc recovery (%) | 75.78 | 85.07 | 87.93 | 85.22 | 89.36 |
Zinc in concentrate produced (tonnes) | 18,946 | 32,490 | 42,736 | 41,788 | 52,700 |
Data in red denotes a quarterly record
Zinc production from the Kipushi concentrator notably improved during the second half of the third quarter, with multiple records achieved. The improvement in production rates was attributed to the completion of the debottlenecking program, as well as upgrades to the dense media separation (DMS) upstream of the concentrator. Both workstreams were completed in August.
Engineering work on the debottlenecking program commenced in September 2024 to boost the concentrator throughput rate by
Multiple concentrator records have since been achieved in the latter half of the third quarter. A record 6,064 tonnes of zinc in concentrate were produced over 7 days in late August, equivalent to an annual production rate of over 315,000 tonnes of zinc, after accounting for availability. Sustaining this production rate would make the Kipushi Mine the world's fourth-largest zinc mining operation.
Despite the improved production rates, operations continue to be impacted by grid instability. An additional six megawatts of back-up generator capacity is in the process of being installed and will be commissioned in the coming weeks. The new generators will increase the total onsite back-up power to 20 megawatts, sufficient to maintain operational continuity during periods of grid instability.
In addition to delivering the debottlenecking program ahead of schedule and under budget, the Kipushi project team has done so with an industry-leading safety record. Throughout construction of the Kipushi concentrator, which started in September 2022 and was completed in June 2024, as well as the recently completed debottlenecking program, the project team at Kipushi did not record a single lost time injury (LTI). This is an outstanding and incredibly rare industry achievement.
Total year-to-date production from the Kipushi concentrator is 137,224 tonnes of zinc in concentrate. Following improved production rates from the recently completed debottlenecking program, Kipushi's 2025 production guidance remains unchanged at between 180,000 and 240,000 tonnes of zinc.

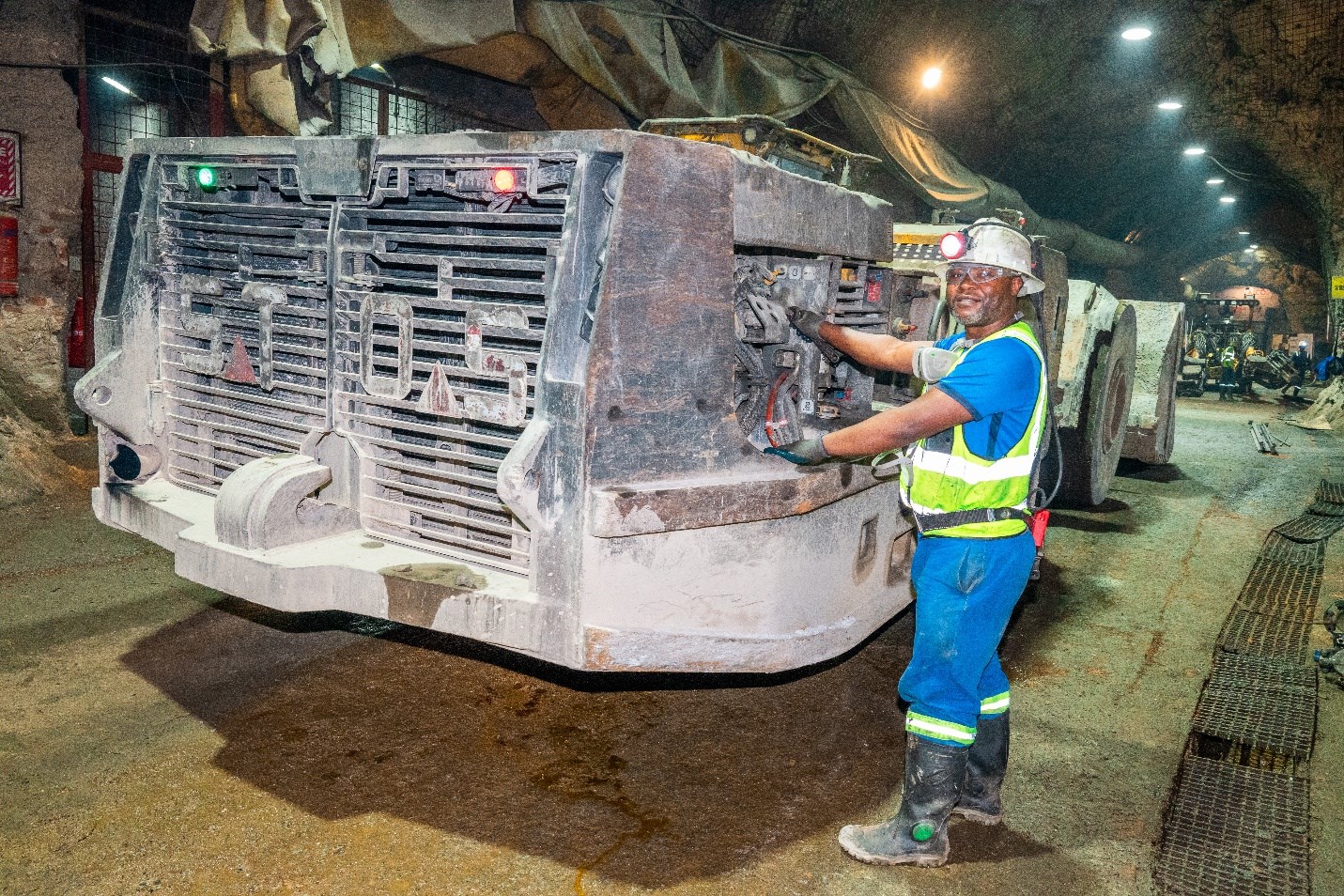

Temwani Nyirenda, Kingki Mining Technician, is conducting scheduled maintenance on an Epiroc Scooptram at the underground workshop in Kipushi.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_008full.jpg
First production from Platreef Mine's Phase 1 concentrator is expected in the coming weeks
The Ivanplats project team is almost operationally ready for the first feed of ore into the Platreef Mine's Phase 1 concentrator, which was completed on schedule in June 2024, and has been kept under a regular care and maintenance program. The first feed of platinum-palladium-nickel-gold-rhodium-copper ore into the Phase 1 concentrator is expected by the end of October.
As announced on May 8, 2025, underground development of the thick, high-grade Flatreef platinum-palladium-nickel-gold-rhodium-copper orebody, on the 850-metre level commenced on April 30, 2025. Since then, a total of 165 metres of reef development in ore has been completed, and of the total 17,125 tonnes of ore blasted, 10,215 tonnes of ore have been hoisted to surface. Reef development on the 750-metre level has also recently commenced. Development ore continues to be hoisted to surface via Shaft #1 and stored in surface stockpiles. The development ore stockpiles will feed the 0.8 Mtpa Phase 1 concentrator during the initial stages of ramp-up.
Equipping of Shaft #3 continues to progress well and is on schedule for completion in Q1 2026. Long hole stoping (production mining) is expected to commence in Q2 2026, once Shaft #3 is commissioned and is ready to hoist.
The underground delineation drilling program, which commenced last year ahead of developing the first long hole ore blocks, has progressed very well with a total of 16,110 meters drilled to date. All assays reconcile well with Ivanplats' geological models and mine plan.
Recruitment continues ahead of the ramp-up of Phase 1, with a total Ivanplats workforce now at over 2,200 employees and contractors, including more than
Project development on Phase 2 expansion underway, targeting completion in Q4 2027
The Ivanplats project engineering team has already commenced work on the development of Phase 2, with the concentrator expansion targeted for completion in Q4 2027. The EPCM contractor for the 3.3-million-tonne-per-annum Phase 2 concentrator is also expected to be appointed in Q4 2025, with earthworks on the site adjacent to the Phase 1 concentrator scheduled to commence shortly thereafter.
In addition, Shaft #2's concrete headgear is now completed, and the expansion of the shaft to a diameter of 10 metres will commence following the appointment of the contractor in Q1 2026. Raise boring of Shaft #2 to its initial diameter of 3.1 metres was completed in Q4 2024.

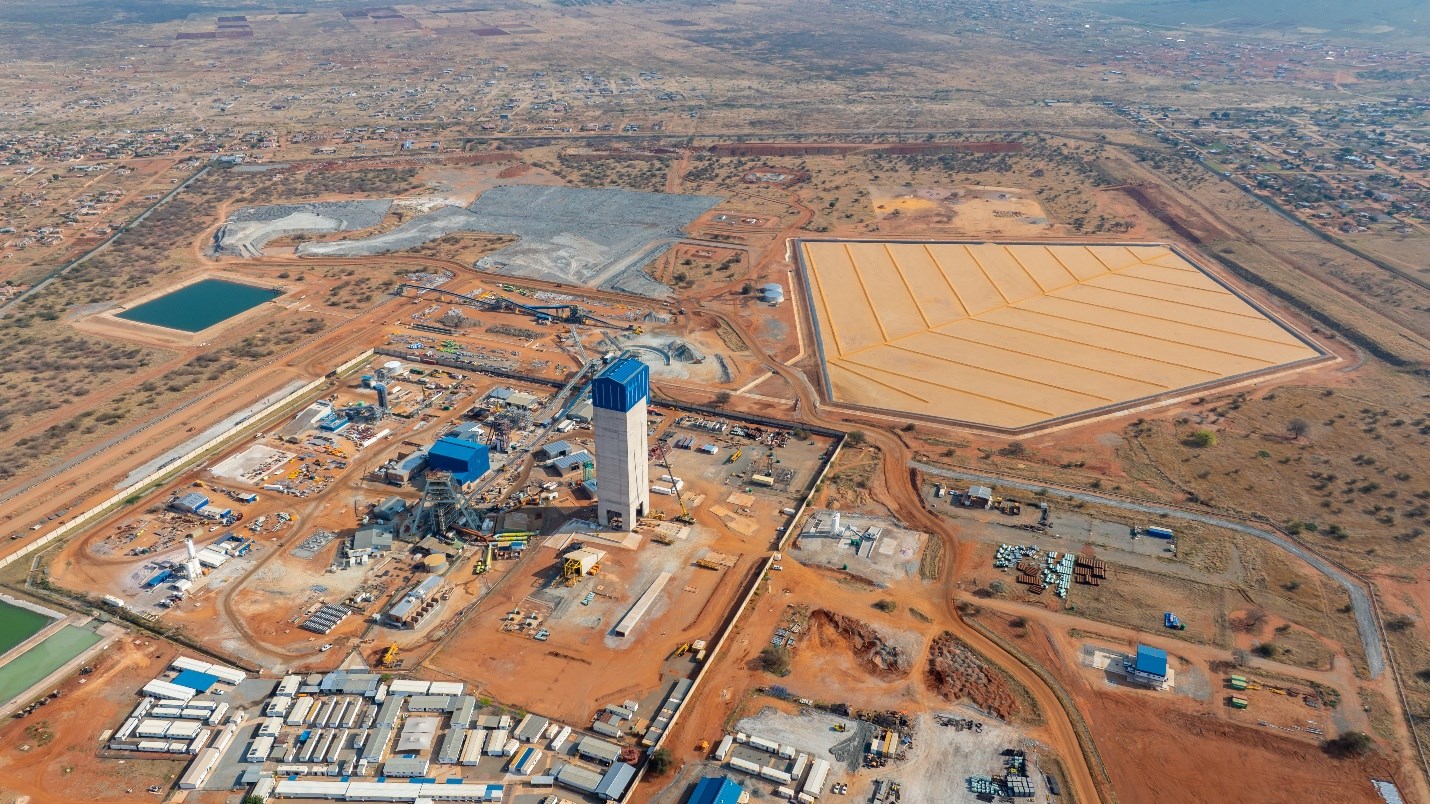

Aerial view of the Platreef Mine site, with Shafts #1, #2 and #3 (centre), the run of mine surface stockpiles (top left) and the dry stack tailings facility (top right).
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_009full.jpg

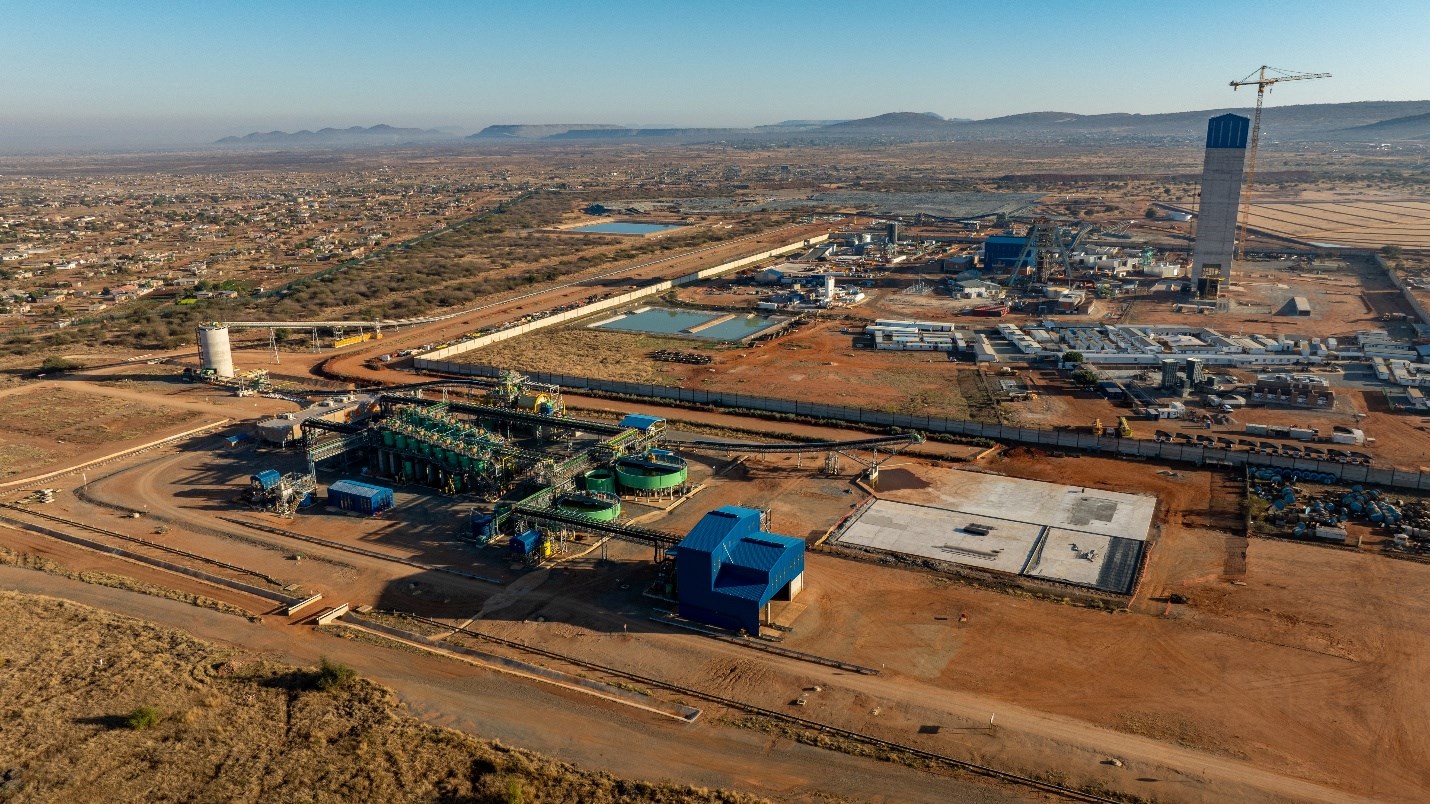

The Platreef Mine's 0.8 Mtpa Phase 1 concentrator in the foreground with the mine site central infrastructure and shaft headframes in the background. The 3.3 Mtpa Phase 2 concentrator will be positioned alongside the Phase 1 concentrator
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/269440_e19269f6348088ec_010full.jpg
Ivanhoe Mines to issue Q3 2025 financial results after market close on October 29, and host conference call for investors on October 30, 2025
Ivanhoe Mines will report its Q3 2025 financial results and a detailed update on its operations after market close on Wednesday, October 29, 2025.
The company plans to hold an investor conference call to discuss the second quarter financial results the following day on Thursday, October 30, 2025. Details of the call will be shared closer to the date.
An audio webcast recording of the conference call, together with supporting presentation slides, will be available on Ivanhoe Mines' website at www.ivanhoemines.com.
After issuance, the Financial Statements and Management's Discussion and Analysis will be available at www.ivanhoemines.com and www.sedarplus.ca.
Qualified Persons
Disclosures of a scientific or technical nature at the Kamoa-Kakula Copper Complex, the Platreef Mine and the Kipushi Mine in this news release, have been reviewed and approved by Steve Amos, who is considered, by virtue of his education, experience, and professional association, a Qualified Person under the terms of NI 43-101. Mr. Amos is not considered independent under NI 43-101 as he is Ivanhoe Mines' Executive Vice President, Projects. Mr. Amos has verified such technical data disclosed in this news release.
Ivanhoe has prepared an independent, NI 43-101-compliant technical report for the Kamoa-Kakula Copper Complex, the Platreef Mine, and the Kipushi Mine, each of which is available on the company's website and under the company's SEDAR+ profile at www.sedarplus.ca
- Kamoa-Kakula Integrated Development Plan 2023 Technical Report dated March 6, 2023, prepared by OreWin Pty Ltd., China Nerin Engineering Co. Ltd., DRA Global, Epoch Resources, Golder Associates Africa, Metso Outotec Oyj, Paterson and Cooke, SRK Consulting Ltd., and The MSA Group.
- The Kipushi 2022 Feasibility Study, dated February 14, 2022, prepared by OreWin Pty Ltd., MSA Group (Pty) Ltd., SRK Consulting (South Africa) (Pty) Ltd, and METC Engineering.
- The Platreef Integrated Development Plan 2025, dated February 15, 2025, prepared by OreWin Pty Ltd., Mine Technical Services, SRK Consulting Inc., DRA Projects (Pty) Ltd, and Golder Associates Africa.
The technical reports include relevant information regarding the assumptions, parameters, and methods of the mineral resource estimates on the Kamoa-Kakula Copper Complex, the Kipushi Mine and the Platreef Mine cited in this news release, as well as information regarding data verification, exploration procedures and other matters relevant to the scientific and technical disclosure contained in this news release.
