Tudor Gold Intersects 2.57 g/t Gold Equivalent over 54.00 Meters at Treaty Creek, Northwest British Columbia
Tudor Gold (TSXV: TUD) has announced significant drilling results from its 80%-owned Treaty Creek Project in British Columbia's Golden Triangle. The first two drill holes of the 2025 exploration program revealed notable gold equivalent (AuEQ) intersections:
Hole GS-25-188 yielded 2.57 g/t AuEQ over 54.00 meters, including high-grade sections of 5.64 g/t AuEQ over 6.00 meters. The hole successfully expanded the 300N Zone mineralization by 45 meters northward. Hole GS-25-189 intersected 1.29 g/t AuEQ over 204.00 meters in the CS-600 Zone, with several high-grade intervals including 7.06 g/t AuEQ over 3.00 meters.
The results indicate potential for additional high-grade structural corridors, suggesting possible reinterpretation of the 300N Zone. The company has filed for an underground development permit to conduct more efficient drilling between the 300N and SC-1 Zones.
Tudor Gold (TSXV: TUD) ha comunicato risultati di perforazione importanti dal progetto Treaty Creek, di cui detiene l'80%, ubicato nel Golden Triangle della British Columbia. I primi due fori del programma esplorativo 2025 hanno mostrato intersezioni significative in equivalente oro (AuEQ):
Il foro GS-25-188 ha restituito 2,57 g/t AuEQ su 54,00 metri, con zone ad alto tenore come 5,64 g/t AuEQ su 6,00 metri, ampliando la mineralizzazione della Zona 300N di 45 metri verso nord. Il foro GS-25-189 ha incontrato 1,29 g/t AuEQ su 204,00 metri nella Zona CS-600, con vari intervalli ad alta gradazione, incluso 7,06 g/t AuEQ su 3,00 metri.
I risultati suggeriscono la presenza di corridoi strutturali ad alta gradazione e la possibilità di una reinterpretazione della Zona 300N. La società ha inoltre presentato una richiesta di permesso per sviluppo sotterraneo, al fine di eseguire perforazioni più efficienti tra le zone 300N e SC-1.
Tudor Gold (TSXV: TUD) ha anunciado resultados importantes de perforación en su proyecto Treaty Creek, del que posee el 80%, en el Golden Triangle de Columbia Británica. Los dos primeros sondeos del programa de exploración 2025 mostraron intersecciones notables en equivalente oro (AuEQ):
El pozo GS-25-188 informó 2,57 g/t AuEQ sobre 54,00 metros, incluyendo tramos de alta ley de 5,64 g/t AuEQ sobre 6,00 metros, ampliando la mineralización de la Zona 300N 45 metros hacia el norte. El pozo GS-25-189 intersectó 1,29 g/t AuEQ sobre 204,00 metros en la Zona CS-600, con varios intervalos de alta ley, incluido 7,06 g/t AuEQ sobre 3,00 metros.
Los resultados indican potencial para corredores estructurales de alta ley y plantean una posible reinterpretación de la Zona 300N. La compañía ha solicitado un permiso para desarrollo subterráneo para realizar perforaciones más eficientes entre las zonas 300N y SC-1.
Tudor Gold (TSXV: TUD)는 브리티시컬럼비아의 골든 트라이앵글에 있는 자사 80% 지분 Treaty Creek 프로젝트에서 의미 있는 시추 결과를 발표했습니다. 2025년 탐사 프로그램의 첫 두 개 시추공에서 금 환산(AuEQ)으로 주목할 만한 교차구간이 확인됐습니다:
시추공 GS-25-188은 54.00미터 구간 평균 2.57 g/t AuEQ를 기록했으며, 그중 6.00미터 구간은 5.64 g/t AuEQ의 고등급을 보였습니다. 이 시추로 300N 존의 광화대가 북쪽으로 45미터 확장되었습니다. 시추공 GS-25-189은 CS-600 존에서 204.00미터 구간 평균 1.29 g/t AuEQ를 관통했으며, 3.00미터 구간 7.06 g/t AuEQ 등 여러 고등급 간격이 포함되어 있습니다.
결과는 추가 고등급 구조적 통로의 가능성을 시사하며 300N 존의 재해석 여지를 제공합니다. 회사는 300N과 SC-1 존 사이를 보다 효율적으로 시추하기 위해 지하 개발 허가를 신청했습니다.
Tudor Gold (TSXV: TUD) a annoncé des résultats significatifs de forage sur son projet Treaty Creek, dont elle détient 80 %, situé dans le Golden Triangle de la Colombie-Britannique. Les deux premiers trous du programme d'exploration 2025 ont révélé des intersections notables en équivalent or (AuEQ) :
Le trou GS-25-188 a donné 2,57 g/t AuEQ sur 54,00 mètres, comprenant des sections à teneur élevée à 5,64 g/t AuEQ sur 6,00 mètres, étendant la minéralisation de la zone 300N de 45 mètres vers le nord. Le trou GS-25-189 a intercepté 1,29 g/t AuEQ sur 204,00 mètres dans la zone CS-600, avec plusieurs intervalles à haute teneur, dont 7,06 g/t AuEQ sur 3,00 mètres.
Ces résultats indiquent le potentiel de corridors structuraux à haute teneur et suggèrent une possible réinterprétation de la zone 300N. La société a déposé une demande de permis de développement souterrain afin de réaliser des forages plus efficaces entre les zones 300N et SC-1.
Tudor Gold (TSXV: TUD) hat bedeutende Bohrergebnisse aus dem zu 80 % gehaltenen Treaty Creek-Projekt im Golden Triangle von British Columbia bekanntgegeben. Die ersten beiden Bohrlöcher des Explorationsprogramms 2025 zeigten bemerkenswerte Goldäquivalent-(AuEQ)-Schnitte:
Bohrloch GS-25-188 ergab 2,57 g/t AuEQ über 54,00 Meter, darunter hochgradige Abschnitte mit 5,64 g/t AuEQ über 6,00 Meter. Das Loch erweiterte die Mineralisierung der 300N-Zone um 45 Meter nach Norden. Bohrloch GS-25-189 schnitt 1,29 g/t AuEQ über 204,00 Meter in der CS-600-Zone, mit mehreren hochgradigen Intervallen, darunter 7,06 g/t AuEQ über 3,00 Meter.
Die Ergebnisse deuten auf das Potenzial zusätzlicher hochgradiger struktureller Korridore hin und legen eine mögliche Neuauslegung der 300N-Zone nahe. Das Unternehmen hat eine Genehmigung für unterirdische Erschließung beantragt, um effizienter zwischen den Zonen 300N und SC-1 bohren zu können.
- Discovery of new high-grade hydrothermal breccia stockwork system between previously identified corridors
- Successful 45-meter northward expansion of the 300N Zone mineralization
- Strong drill results including 2.57 g/t AuEQ over 54.00 meters and 1.29 g/t AuEQ over 204.00 meters
- Underground development permit filed for more cost-effective drilling operations
- True widths of mineralization remain undetermined as the mineralized body is still open in all directions
- Additional drilling required to determine mineralized body orientation
Vancouver, British Columbia--(Newsfile Corp. - September 8, 2025) - Tudor Gold Corp. (TSXV: TUD) (FSE: H56) (the "Company" or "Tudor") is pleased to announce the results from the first two drill-holes completed from the 2025 exploration drilling program (the "Program") at its
Drilling Highlights:
Hole GS-25-188 intersected a 45-meter ("m") northward step-out of the 300N Zone and a potential SC-1 Zone structural corridor. Highlights of the mineralized intercept:
2.57 g/t gold equivalent ("AuEQ") over 54.00 m (2.31 g/t Au, 16.98 g/t Ag,
0.07% Cu), including 5.64 g/t AuEQ over 6.00 m (4.07 g/t Au, 99.86 g/t Ag,0.45% Cu)11.16 g/t AuEQ over 1.50 m (5.90 g/t Au, 343.00 g/t Ag,
1.45% Cu)
Hole GS-25-189 intersected a robust interval of the CS-600 Zone, and intersected several higher-grade intervals above and below CS-600 Zone mineralization.
7.06 g/t AuEQ over 3.00 m (7.01 g/t Au, 4.22 g/t Ag,
0.01% Cu)1.29 g/t AuEQ over 204.00 m (0.65 g/t Au, 4.78 g/t Ag,
0.48% Cu)4.14 g/t AuEQ over 10.20 m (3.72 g/t Au, 6.04 g/t Ag, 0.29 % Cu), including 6.29 g/t AuEQ over 3.50 m (5.81 g/t Au, 1.00 g/t Ag,
0.38% Cu)
Click the following links to view a plan map and cross sections for holes GS-25-188 and GS-25-189.
GS-25-188 was drilled to step out from previously drilled 300 North Zone ("300N") mineralization at an azimuth more favorable to cross cutting and identifying SC-1 Zone structural corridors. This drill hole expands the mineralized footprint of 300N by 45 m to the north and the intercepted mineralization occurs along a structural orientation similar to the previously identified four sub-parallel gold-bearing breccia systems of the SC-1 Zone. See Table 1 below.
GS-25-189 was drilled to identify potential high-grade mineralization occurring between previous intercepts included in the SC-1 Zone and 300N and to infill a strongly mineralized section of the CS-600 Zone. The hole intersected high-grade gold mineralization (7.01 g/t gold over 3.0 m) within an area occurring between the SC-1 Zone and 300N Domains, which was expected to host additional high-grade mineralized corridors. The drillhole continued through the CS-600 Zone with an extensive mineralized intercept before intersecting a high-grade gold (5.81 g/t gold over 3.5 m) potential 170-m stepout to the SC-1 Zone. See Table 1 below.
The SC-1 Zone was identified and expanded throughout the 2024 drilling campaign to represent a significant potential economic target that is within, and peripheral to, the CS-600 Zone (see press release dated December 16, 2024). The drill results from GS-25-188 and -189 indicate strong potential for additional high-grade structural corridors and may require the reinterpretation of 300N as additional high-grade SC-1 Zone like structures.
Ken Konkin, P.Geo., Senior Vice-President, Exploration: "The discovery of another high-grade hydrothermal breccia stockwork system between the previously identified corridors demonstrates the potential for the continuity for high-grade gold at depth at Treaty Creek. The 300 North Zone appears to share the similar trend as the previously discovered high-grade SC-1 Zone. With our underground development permit filed, we plan to fill-in the gaps between 300N and the SC-1 Zone with more efficient and cost-effective underground drilling."
Table 1: Select Drill Results for Holes GS-25-188 and GS-25-189
Hole | Collar Coords | Dip/ Azimuth | From (m) | To (m) | Interval (m) | Gold (g/t) | Silver (g/t) | Copper (%) | AuEQ(3) (g/t) |
GS-25-188 | 429024 mE 6273658 mN | -62/283 | 900.00 | 954.00 | 54.00 | 2.31 | 16.98 | 0.07 | 2.57 |
Including | 900.00 | 906.00 | 6.00 | 4.07 | 99.86 | 0.45 | 5.64 | ||
and | 901.50 | 903.00 | 1.50 | 5.90 | 343.00 | 1.45 | 11.16 | ||
GS-25-189 | 429024 mE 6273658 mN | -71/293 | 836.00 | 845.00 | 9.00 | 2.45 | 0.94 | 0.01 | 2.48 |
882.50 | 885.50 | 3.00 | 7.01 | 4.22 | 0.01 | 7.06 | |||
1130.00 | 1334.00 | 204.00 | 0.65 | 4.78 | 0.48 | 1.29 | |||
1355.40 | 1365.60 | 10.20 | 3.72 | 6.04 | 0.29 | 4.14 | |||
Including | 1357.50 | 1361.00 | 3.50 | 5.81 | 1.00 | 0.38 | 6.29 |
• All assay values are uncut and intervals reflect drilled intercept lengths. |
• HQ and NQ diameter core samples were sawn in half and typically sampled at standard 1.5 m intervals. |
• The following metal prices were used to calculate the Au Eq metal content: Gold |
• True widths have not been determined as the mineralized body remains open in all directions. Further drilling is required to determine the mineralized body orientation and true widths. |

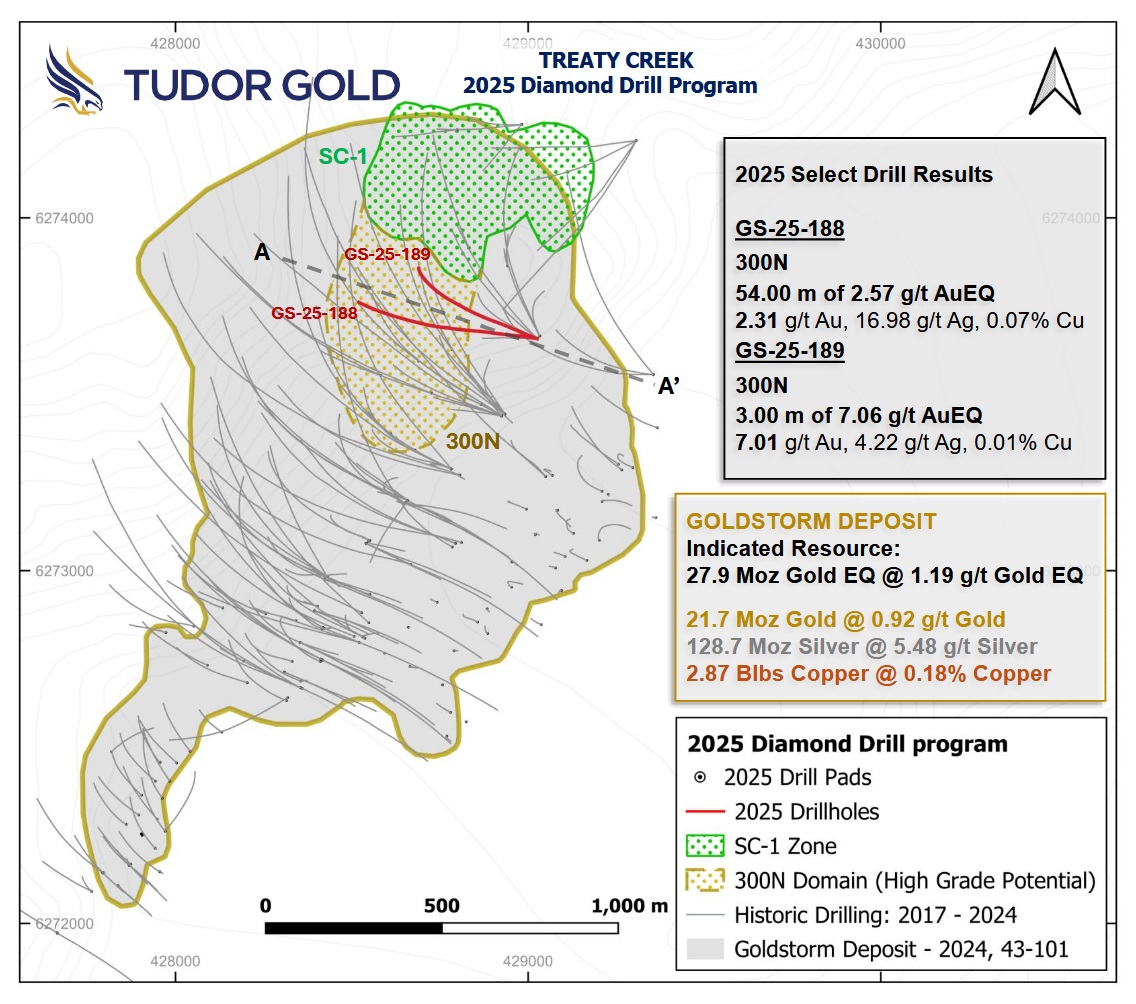

To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/4494/265493_planmap2025-09-08.jpg
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/4494/265493_sections2025-09-08jpg.jpg
