Ivanhoe Mines Issues 2025 Second Quarter Financial Results, Overview of Construction and Exploration Activities
- None.
- None.
Ivanhoe Mines' reports Q2 2025 profit of
Kamoa-Kakula produced 112,009 tonnes of copper in Q2 2025, Phase 1 and 2 operating at
Mining rates on the western side of Kakula improve; operations in line with revised 2025 production guidance
Stage One dewatering of the Kakula Mine advances; Stage Two dewatering to commence imminently
Kamoa-Kakula capex reviewed for dewatering and ramp-up plan; upper end of 2025 guidance range lowered
Africa's largest and greenest copper smelter on schedule to commence start-up in September
Recent rise in platinum and palladium prices improves Platreef NPV
Kipushi operations achieved another record quarter; imminent completion of debottlenecking program to boost processing rates by
Ivanhoe Mines' balance sheet has
Democratic Republic of the Congo and AFC/M23 sign declaration of principles agreement in Qatar to end fighting in eastern DRC
Johannesburg, South Africa--(Newsfile Corp. - July 30, 2025) - Ivanhoe Mines' (TSX: IVN) (OTCQX: IVPAF) President and Chief Executive Officer, Marna Cloete, and Chief Financial Officer David van Heerden are pleased to announce the company's financial results for the second quarter of 2025, as well as an operations and project development update.
Ivanhoe Mines is a leading Canadian mining company with three principal tier-one mining operations in Southern Africa. The company is primarily focused on operations at the Kamoa-Kakula Copper Complex in the Democratic Republic of the Congo (DRC); ramping up production and debottlenecking the ultra-high-grade Kipushi zinc-copper-lead-germanium mine in the DRC; and soon, commencing the startup of the Platreef platinum, palladium, rhodium, nickel, gold, and copper mine in South Africa.
In addition, Ivanhoe Mines is expanding the Makoko District copper discovery in the Western Forelands, as well as exploring for new sedimentary-hosted copper discoveries across its expansive and highly prospective exploration licence packages across the DRC, Angola, Zambia, and Kazakhstan. All figures are in U.S. dollars unless otherwise stated.
Watch a video highlighting Ivanhoe Mines' second quarter financial results, as well as an operational update: https://vimeo.com/1105228328/945ffda895?share=copy
To view an enhanced version of this graphic, please visit:
https://vimeo.com/1105228328/945ffda895?share=copy
Founder and Co-Chairman Robert Friedland commented:
"More important than the financial results of this second quarter are the milestones achieved beneath the surface at Kakula. Since resuming operations in early June, our underground teams have delivered remarkable outcomes, exceeding our expectations and demonstrating extraordinary dedication under challenging circumstances. Their efforts are driving steady, week-on-week improvements, as we work our way back towards full capacity. Guided by technical assessments and strategic leadership directives, this progress showcases robust momentum and a clear path forward.
"Equally commendable are our colleagues in China, whose exceptional coordination has been instrumental in sourcing, assembling, and shipping four high-capacity submersible pumps. These critical infrastructure components, set to begin operation in August, will expedite the dewatering efforts of Kakula. By the end of 2025, these pumps are expected to enable us access back into the mine's eastern high-grade zones.
"However, the most groundbreaking transformation is yet to come. With the Platreef Mine poised to begin production next quarter, this will be a new frontier for the global platinum group metals industry and South Africa. Platreef signifies the future of sustainable mining, combining large-scale operations, mechanization, cost efficiency, environmental stewardship, and an emphasis on social and community partnership. It is not merely a new mine but a redefinition of how platinum group metals, as well as nickel and copper, are produced responsibly. The dawn of the Platreef era is upon us, and the world is watching."
FINANCIAL HIGHLIGHTS
- Ivanhoe Mines' Q2 2025 adjusted EBITDA was
$123 million , compared with$226 million for Q1 2025, which includes an attributable share of EBITDA from Kamoa-Kakula of$128 million . Ivanhoe Mines recorded a profit after tax of$35 million for Q2 2025, compared to$67 million for the same period in 2024 and$122 million in Q1 2025.
- Kamoa-Kakula sold 101,714 tonnes of copper (net of payability) during the second quarter at an average realized copper price of
$4.34 /lb., compared with 109,963 tonnes in Q1 2025 at an average realized copper price of$4.19 /lb. Sales continued to lag production due to a build-up of inventory for the smelter, which is expected to start up in September. At the end of the second quarter, there were approximately 53,600 tonnes of unsold copper in inventory, up from approximately 48,000 tonnes at the end of Q1 2025.
- Kamoa-Kakula recognized revenue of
$875 million , an operating profit of$190 million , and EBITDA of$325 million for the quarter, equivalent to an EBITDA margin of37% . This compares with Q1 2025 EBITDA of$594 million .
- Kamoa-Kakula's cost of sales per pound (lb.) of payable copper sold was
$2.85 /lb. for the second quarter, compared with$1.87 /lb. in Q1 2025. Cash cost (C1) per pound of payable copper produced in the quarter averaged$1.89 /lb., compared with$1.69 /lb. during Q1 2025. The costs of sales include abnormal costs while Phase 1 and Phase 2 concentrators were temporarily suspended after May 18, 2025.
- Kamoa-Kakula revised its 2025 cash cost (C1) guidance range to
$1.90 /lb. -$2.20 /lb., from previously$1.65 /lb. -$1.85 /lb. of payable copper produced. Kamoa-Kakula is anticipating higher cash costs during the second half of 2025, which is primarily due to the processing of lower-grade ore. Additionally, the financial benefits of operating the smelter are unlikely to have a significant positive impact until ramp-up is advanced towards the end of the year.
- In June, Kamoa Copper signed an offtake agreement with Trafigura Asia Trading Pte Ltd for the remaining
20% of the smelter's annual anode production. The agreement is over a three-year term and also includes a$200 million offtake-linked advance payment facility. The facility has an interest rate of the 1-month Secured Overnight Financing Rate (SOFR) plus3.75% . Offtake agreements for the other80% of anode production were signed in Q1 with CITIC Metal (HK) Limited and Gold Mountains International Mining Company Limited, a subsidiary of Zijin Mining. CITIC Metal and Gold Mountains also provided advance payment facilities totaling$500 million .
- 2025 capital expenditure guidance for Kamoa-Kakula has been comprehensively reviewed with respect to the ongoing dewatering and ramp-up plan. The lower end of guidance is maintained at
$1,420 million with the upper end lowered to$1,600 million from$1,670 million . Discretionary Phase 3 optimization expenditure in the original 2025 budget is deferred to 2026, partially offset by increased sustaining costs associated with the rehabilitation and dewatering of Kakula and the ramp-up of Kamoa.
- Despite operational challenges during the second quarter, the Kamoa-Kakula joint venture returned a positive net cash flow of
$169 million .
- Kipushi sold 43,348 tonnes of zinc (net of payability) during the quarter, up by almost
45% from the 30,108 tonnes of zinc sold in Q1 2025. Kipushi recognized a quarterly revenue of$97 million , a segmented loss of$6 million and EBITDA of$9 million . Kipushi's cost of sales per pound of payable zinc sold was$1.05 /lb. and the cash cost (C1) per pound of payable zinc sold totaled$0.96 /lb.
- Kipushi Mine's cash costs (C1) for the first half of 2025 are just below the mid-point of guidance at
$0.94 /lb. of payable zinc. Ivanhoe Mines maintains Kipushi's 2025 cash cost (C1) guidance of$0.90 /lb. to$1.00 /lb. of payable zinc.
- Platreef capital expenditure is tracking at the lower end of 2025 guidance, with the Phase 1 project nearing completion. Negotiations are progressing well for a
$700 million Phase 2 senior project finance facility, which is expected to close in Q1 2026.
- Ivanhoe Mines has a strong balance sheet with cash and cash equivalents on hand of
$672 million and attributable group pro-rata cash and cash equivalents of$774 million on hand, as at June 30, 2025.
OPERATIONAL HIGHLIGHTS
- During the second quarter, Kamoa-Kakula's Phase 1, 2, and 3 concentrators milled 3.62 million tonnes of ore, producing 112,009 tonnes of copper, representing an
11% increase when compared with the same period in 2024. This included a monthly record of approximately 50,000 tonnes of copper in April, prior to the occurrence of seismic activity in May 2025. Copper production for the first half of 2025 totaled 245,127 tonnes.
- Quarterly copper production was significantly impacted by seismic activity on the eastern side of the Kakula Mine, as reported on May 20, 2025. This resulted in the suspension of underground mining activities at the Kakula Mine. Mining recommenced on the western side of the Kakula Mine on June 7, 2025. Kamoa-Kakula's 2025 production guidance was revised to between 370,000 and 420,000 tonnes of copper.
- The Phase 1 and 2 concentrators commenced the processing of ore from the western side of the Kakula Mine on June 8, 2025. For the remainder of the year, the Phase 1 and 2 concentrators are expected to operate at between
80% and85% of plant capacity, targeting50% of ore feed from surface stockpiles and50% from ore mined from the western side of Kakula. The processing of surface stockpiles is expected to continue until they are depleted in Q1 2026.
- The Phase 3 concentrator milled a record 1.6 million tonnes of ore in the second quarter, producing a record 40,608 tonnes of copper. The milling record is equivalent to an annualized rate of 6.5 million tonnes, which is
30% higher than the Phase 3 concentrator's design capacity of 5.0 million tonnes per annum. The average quarterly feed grade for the Phase 3 concentrator was a record2.92% copper.
- Stage One dewatering continues as planned, with water levels modestly decreasing. The delivery of the four Stage Two, submersible, high-capacity dewatering pumps has recently commenced with the first of three cargo flights arriving in Lubumbashi. Stage Two dewatering is on schedule to start in August.
- Ivanhoe Mines is targeting to provide in September 2025 an update on Kamoa-Kakula's recovery plan and ramp-up to steady-state operations over the medium term. Work has also commenced on an updated life-of-mine integrated development plan, which is targeted for completion in the first quarter of 2026.
- Kamoa-Kakula's 500,000-tonne-per-annum on-site, direct-to-blister copper smelter, the largest in Africa, is expected to commence start up in September. All concentrates produced by Phase 1, 2, and 3 concentrators are expected to be treated by the on-site smelter.
- Site clearance and early earthworks for Kamoa-Kakula's 60-megawatt (MW), on-site solar (PV) facility with battery storage have commenced. The solar facility is expected to be operational in mid-2026, supplying up to
25% of Kakula's energy requirements.
- Mechanical and electrical equipment installation for the refurbished Turbine #5 at the Inga II hydroelectric facility is now completed. Pre-commissioning activities have already commenced and are expected to be completed early in the fourth quarter.
- At Kipushi, during Q2 2025, the concentrator milled a record 153,342 tonnes of ore at a record average grade of
33.4% zinc, producing a near-record 41,788 tonnes of zinc in concentrate at a contained grade of over51% zinc.
- The first phase of Kipushi's debottlenecking program was completed in June with the second phase on schedule to be completed in the coming weeks, requiring a shutdown to tie in the newly installed equipment. In mid-July following completion of the first phase, Kipushi achieved a daily production record equivalent to 327,000 tonnes of zinc in concentrate on an annualized basis, and a weekly production record equivalent to 289,000 tonnes of zinc in concentrate on an annualized basis.
- Kipushi produced 84,524 tonnes of zinc during H1 2025. The production rate in H2 2025 is expected to significantly improve following improved availability of the dense media separation (DMS) circuit and the imminent completion of the debottlenecking program. Kipushi's 2025 production guidance is maintained at 180,000 to 240,000 tonnes of zinc in concentrate.
- At Platreef, the first feed of ore into the Phase 1 concentrator is on schedule to take place in Q4 2025. Phase 1 is the first step of a three-phase expansion plan, which aims to make the Platreef Mine one of the world's largest producers of platinum, palladium, rhodium, and gold, with significant copper and nickel credits.
- Phase 2 expansion activities are underway and on track for first production in Q4 2027. Platreef's Phase 2 expansion is expected to produce over 460,000 ounces of platinum, palladium, rhodium, and gold per annum, plus approximately 9,000 tonnes of nickel and 6,000 tonnes of copper.
- The Platreef Mine is projected to be the lowest-cost primary platinum-group-metals producer globally. The Phase 2 life-of-mine total cash cost is estimated to be
$599 per ounce of 3PE+Au, net of nickel and copper by-product credits. This compares very favourably with a basket spot price of approximately$1,600 per ounce of 3PE+Au, as at July 29, 2025.
- On May 8, 2025, mining crews at the Platreef Mine started underground development into the high-grade polymetallic Flatreef orebody for the first time, as the mine rapidly advances to commercial production later this year. This significant milestone comes 15 years after the discovery of the 26-metre thick, flat-lying Flatreef orebody was made. Development ore is being stockpiled on the surface and will be used in the ramp-up of the Phase 1 concentrator. The Ivanplats team aims to accumulate a stockpile of approximately 60,000 tonnes of development ore ahead of the first feed of ore into the Phase 1 concentrator.
- Equipping of Shaft #3 is progressing well. Installation of the rock winder has commenced, with the mechanical and electrical work nearing completion. Shaft #3 is expected to be "ready to hoist" from Q1 2026 with a capacity of approximately 4 million tonnes per annum.
- In the Western Forelands, Ivanhoe continues exploration across its vast licence area, adjacent to Kamoa-Kakula. Drilling activity increased as the wet season ended in late April, with the deployment of four more rigs. In total, nine contractor-operated diamond drill rigs were active during the quarter, which completed a total of 14,843 meters of drilling.
- On May 14, 2025, Ivanhoe announced its independently verified, updated Mineral Resource estimate for the Makoko District in the Western Forelands. The total copper contained in the Makoko District has approximately doubled in the past 18 months, during which 86,000 metres of diamond drilling were completed. The Makoko District ranks as the world's fifth-largest copper discovery since Kakula in 2015.
- In Kazakhstan, drilling commenced in July on Ivanhoe's joint venture licences. Two rigs have been deployed for the 17,500-metre maiden diamond drilling program. In addition, over
95% of the planned 16,911 km² in licences have now been fully granted. Concurrent with the drilling program, extensive geophysical and geochemical programs are underway across the licence package.
- On July 19, 2025, representatives from the DRC and the Congo River Alliance/March 23 Movement (AFC/M23) signed a declaration of principles in Doha, Qatar. The declaration is intended as a roadmap towards a permanent settlement. Both parties agree to implement the terms of the deal by July 29, 2025. In addition, a final peace deal is expected to be agreed by August 18, 2025, and must align with last month's US-brokered Peace Agreement signed on June 27, 2025, between the DRC and Rwanda.
Africa's largest and greenest copper smelter at Kamoa-Kakula is expected to commence start-up in September.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_004full.jpg
This press release includes "EBITDA", "Adjusted EBITDA", "EBITDA margin", "Pro-rata cash and cash equivalents" and "Cash cost (C1)", which are non-GAAP financial performance measures. For a detailed description of each of the non-GAAP financial performance measures used herein and a detailed reconciliation to the most directly comparable measure under IFRS Accounting Standards, please refer to the non-GAAP Financial Performance Measures and Pro-Rata Financial Ratios sections of the company's MD&A for the three and six months ended June 30, 2025.
Conference call for investors on Thursday, July 31, 2025
Ivanhoe Mines will hold an investor conference call to discuss the results on Thursday, July 31, 2025, at 10:30 a.m. Eastern time / 7:30 a.m. Pacific time. The conference call will conclude with a question-and-answer (Q&A) session. Media are invited to attend on a listen-only basis.
To view the webcast, use the link:
https://meetings.400.lumiconnect.com/r/participant/live-meeting/400-061-613-503
Audience Phone Number:
Local - Toronto (+1) 289 514 5005
Toll Free - North America (+1) 800 206 4400
An audio webcast recording of the conference call, together with supporting presentation slides, will be available on Ivanhoe Mines' website at www.ivanhoemines.com.
After issuance, the condensed consolidated interim financial statements and Management's Discussion and Analysis will be available at www.ivanhoemines.com and www.sedarplus.ca.
Read Ivanhoe's Q2 2025 Sustainability Review:
To view an enhanced version of this graphic, please visit:
https://www.ivanhoemines.com/investors/document-library/#sustainability
During the second quarter of 2025, the group achieved a combined Lost Time Injury Frequency Rate (LTIFR) of 0.34 and a Total Recordable Injury Frequency Rate (TRIFR) of 1.06 per 1,000,000 hours worked. A breakdown of Ivanhoe's industry-leading health and safety performance can be found in the Q2 2025 Sustainability Review, on the company's website:
https://www.ivanhoemines.com/investors/document-library/#sustainability
Principal projects and review of activities
1. Kamoa-Kakula Copper Complex
Democratic Republic of Congo
The Kamoa-Kakula Copper Complex is operated as the Kamoa Holding joint venture between Ivanhoe Mines and Zijin Mining. The complex covers a licence area of 400 square kilometres and is approximately 25 kilometres southwest of the town of Kolwezi on the far western edge of the Central African Copperbelt.
Copper production at Kamoa-Kakula commenced in May 2021, following the completion of the Phase 1 concentrator. Since, the Phase 2 and Phase 3 mine and concentrator expansions have been completed, as well as the construction of a 500,000 tonne per annum direct-to-blister copper smelter. A production record was achieved in April 2025, with 50,000 tonnes of copper in concentrate produced during the month, exceeding the target annualized production capacity of 600,000 tonnes. Production since May 18, 2025, has been impacted by the seismic activity and subsequent flooding on the eastern side of the Kakula Mine, which has resulted in production rates being curtailed. Dewatering and rehabilitation work are underway with the target to increase production from underground to meet Phase 1 and 2 concentrator capacity. The Phase 3 concentrator, supplied by the Kamoa mines, continues uninterrupted.
Ivanhoe sold a
Kamoa-Kakula summary of operating and financial data | ||||||
Q2 2025 | Q1 2025 | Q4 2024 | Q3 2024 | Q2 2024 | ||
Ore tonnes milled (000's tonnes) | 3,622 | 3,723 | 3,655 | 3,266 | 2,381 | |
Copper ore grade processed (%) | ||||||
Copper recovery (%) | ||||||
Copper in concentrate produced (tonnes) | 112,009 | 133,120 | 133,819 | 116,313 | 100,812 | |
Payable copper sold (tonnes)(1) | 101,714 | 109,963 | 112,811 | 103,106 | 95,900 | |
Cost of sales per pound ($ per lb.) | 2.85 | 1.87 | 1.94 | 1.80 | 1.53 | |
Cash cost (C1) ($ per lb.) | 1.89 | 1.69 | 1.75 | 1.69 | 1.52 | |
Realized copper price ($ per lb.) | 4.34 | 4.19 | 4.08 | 4.16 | 4.34 | |
Sales revenue before remeasurement ($'000) | 868,846 | 922,411 | 895,758 | 836,871 | 813,817 | |
Remeasurement of contract receivables ($'000) | 6,443 | 50,986 | (52,428) | (8,983) | 3,256 | |
Sales revenue after remeasurement ($'000) | 875,289 | 973,397 | 843,330 | 827,888 | 817,073 | |
EBITDA ($'000) | 325,181 | 594,337 | 431,802 | 469,735 | 547,257 | |
EBITDA margin (% of sales revenue) |
All figures in the above tables are on a
(1) Payable copper sold is net of the payability factor of circa
C1 cash cost per pound of payable copper produced can be further broken down as follows:
Q2 2025 | Q1 2025 | Q4 2024 | Q3 2024 | Q2 2024 | ||||||||
Mining | ($ per lb.) | 0.73 | 0.63 | 0.61 | 0.62 | 0.45 | ||||||
Processing | ($ per lb.) | 0.34 | 0.29 | 0.30 | 0.26 | 0.21 | ||||||
Logistics charges | ($ per lb.) | 0.49 | 0.41 | 0.40 | 0.42 | 0.48 | ||||||
TC, RC, smelter charges | ($ per lb.) | 0.14 | 0.19 | 0.27 | 0.26 | 0.25 | ||||||
General & Administrative | ($ per lb.) | 0.19 | 0.17 | 0.17 | 0.13 | 0.13 | ||||||
Cash cost (C1) per pound of payable copper produced | ($ per lb.) | 1.89 | 1.69 | 1.75 | 1.69 | 1.52 |
The cost of power, which is allocated between mining and processing in the above cash cost split, can be split out as follows:
Q2 2025 | Q1 2025 | Q4 2024 | Q3 2024 | Q2 2024 | |||||||
Power costs included in Mining and Processing cost | ($ per lb.) | 0.20 | 0.24 | 0.22 | 0.19 | 0.12 | |||||
Power costs as a proportion of cash cost (C1) per pound of payable copper produced | (%) |
Cash cost (C1) is prepared on a basis consistent with the industry standard definitions by Wood Mackenzie cost guidelines, but is not a measure recognized under IFRS Accounting Standards. In calculating the C1 cash cost, the costs are measured on the same basis as the company's share of profit from the Kamoa Holding joint venture which is contained in the financial statements. C1 cash cost is used by management to evaluate operating performance and includes all direct mining, processing, and general and administrative costs. Smelter charges and freight deductions on sales to the final port of destination, which are recognized as a component of sales revenues, are added to C1 cash cost to arrive at an approximate cost of delivered, finished metal. C1 cash cost excludes royalties, production taxes, and non-routine charges as they are not direct production costs.
All figures are on a
Kamoa-Kakula produced 112,009 tonnes of copper in Q2 2025, following disruption from seismic activity in mid-May; rehabilitation plans advancing on track
During the second quarter of 2025, the Phase 1, 2, and 3 concentrators milled 3.62 million tonnes of ore, producing 112,009 tonnes of copper, representing an
In June, Kamoa-Kakula's Phase 1, 2, and 3 concentrators produced a total of 28,147 tonnes of copper. During the month, approximately 15,000 tonnes of copper were produced by the Phase 1 and 2 concentrators, at an average grade of
Underground development to a new mining area, located on the far eastern side of the Kakula Mine, commenced in early July. The development of the two new access drives will be conducted from existing underground infrastructure.
Kamoa-Kakula summary of quarterly production data: | ||||||||
Q2 2025 | Q1 2025 | Q4 2024 | Q3 2024 | Q2 2024 | ||||
Phase 1 & 2 | ||||||||
Ore tonnes milled (000's tonnes) | 1,991* | 2,211 | 2,329 | 2,215 | 2,288 | |||
Copper ore grade processed (%) | ||||||||
Copper recovery (%) | ||||||||
Copper in concentrate produced (tonnes) | 71,401* | 97,575 | 102,042 | 94,214 | 99,706 | |||
Phase 3 | ||||||||
Ore tonnes milled (000's tonnes) | 1,631 | 1,512 | 1,326 | 1,050 | 93 | |||
Copper ore grade processed (%) | ||||||||
Copper recovery (%) | ||||||||
Copper in concentrate produced (tonnes) | 40,608 | 35,545 | 31,777 | 22,099 | 1,106 | |||
Combined Phase 1, 2, and 3 | ||||||||
Ore tonnes milled (000's tonnes) | 3,622 | 3,723 | 3,655 | 3,266 | 2,381 | |||
Copper ore grade processed (%) | ||||||||
Copper recovery (%) | ||||||||
Copper in concentrate produced (tonnes) | 112,009 | 133,120 | 133,819 | 116,313 | 100,812 |
Data in bold denotes a quarterly record.
*As announced on May 20, 2025, Phase 1 & 2 production in Q2 2025 was impacted by seismic activity at the Kakula Mine
As revised on June 11, 2025, Kamoa-Kakula's annual production guidance of 370,000 to 420,000 tonnes of copper is maintained.
As at June 30, 2025, Kamoa-Kakula's useable ore surface stockpiles totaled approximately 3.0 million tonnes at an estimated blended average grade of
Phase 1 and 2 concentrators to operate at between
The Phase 1 and 2 concentrators commenced the processing of ore from the western side of the Kakula Mine on June 8, 2025. Kamoa-Kakula's management is targeting that for the remainder of the year, the Phase 1 and 2 concentrators will operate at between
As announced on June 11, 2025, mining on the western side of the Kakula Mine restarted. By mid-June, the mining rate had ramped up to 300,000 tonnes per month (3.6 million tonnes on an annualized basis), with grades ranging from
The Phase 3 concentrator milled a record 1.6 million tonnes of ore in the second quarter, producing a record 40,608 tonnes of copper. The milling record is equivalent to an annualized rate of 6.5 million tonnes, which is
During the second half of 2025, the combined mining rate from the Kamoa and Kansoko mines will increase, with up to 100,000 tonnes per month of this ore fed into the Phase 1 and 2 concentrators, replacing a portion of the stockpile feed.
Stage One dewatering continues as planned; shipping of Stage Two dewatering pumps has started and expected to arrive
As announced on June 2, 2025, following the seismic activity, Kamoa-Kakula has implemented a two-stage plan to dewater the eastern side of the Kakula Mine. "Stage One" dewatering activities, which involved the installation of temporary underground pumping infrastructure to stabilize and maintain current water levels, have been in place and operating to plan since early June 2025. This has enabled the water levels on the eastern side of the Kakula Mine to decrease modestly, ahead of "Stage Two" dewatering activities that are expected to commence in the coming weeks. In the meantime, the declining water levels have enabled mining crews to access additional areas and commence selective rehabilitation.
"Stage Two" dewatering involves the installation of high-capacity, submersible pumps and new permanent surface infrastructure to fully dewater the eastern side of the Kakula Mine from surface. Kamoa Copper has ordered five high-capacity, submersible pumps, each rated with pumping capacity of 650 litres per second, from Hefei Hengda Jianghai Pump Co., Ltd. of Anhui Province, China.
The transportation of four, out of the five, high-capacity, submersible pumps has commenced. The first of three cargo flights departed China on July 24, 2025, landing into Lubumbashi, DRC, the following day. The first equipment package has since arrived on site at Kamoa-Kakula. Two further cargo flights, carrying the remaining pumping equipment, are scheduled to land in Lubumbashi within the coming days. The remaining, fifth, pump will shipped at a later date and kept in reserve as a spare.
Concurrently, site preparation activities are advancing well. The high-capacity, submersible pumps will be installed in pairs down two adjacent shafts that access a deep section of the eastern side of the Kakula Mine, as shown in Figure 1. The pumps will be connected to piping and lowered down the existing shafts from the surface. Discharged water from the submersible pumps will be fed into existing surface water channels that feed into on-site settling and treatment ponds.
The total capital cost of the Stage One and Stage Two dewatering activities, including the purchase, transport, and installation of the high-capacity, submersible dewatering pumps, is expected to be up to

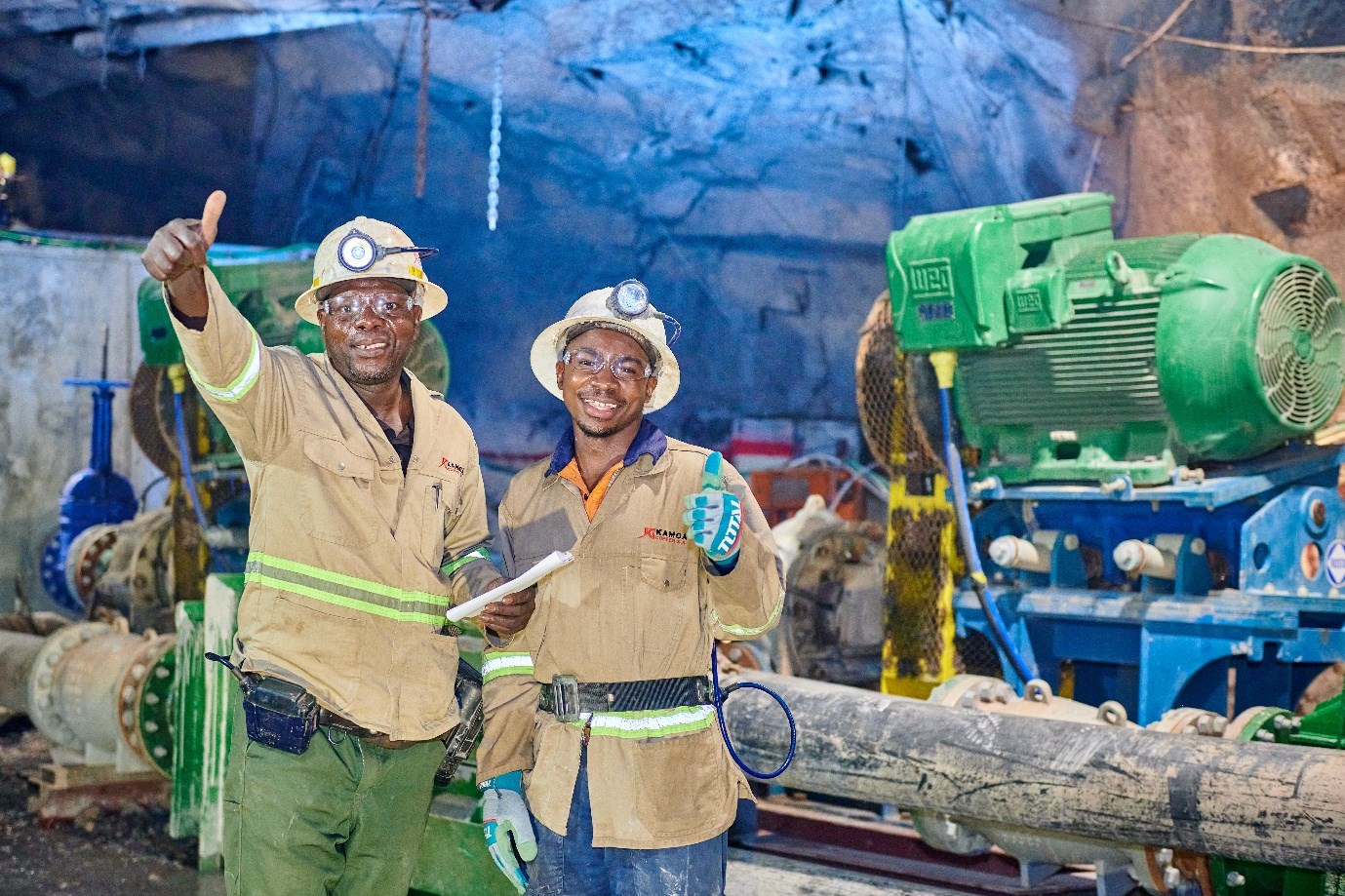

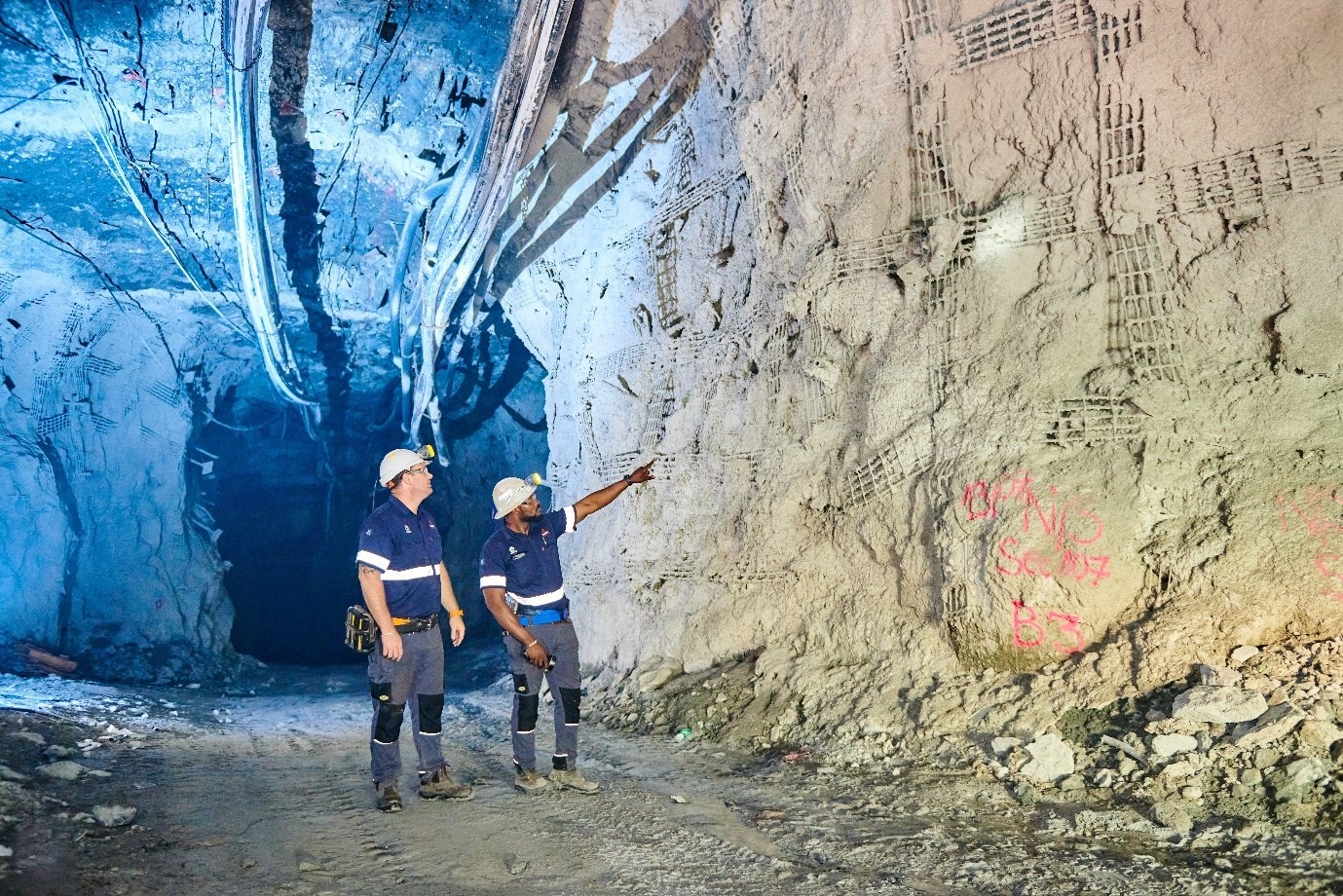

Kayembe Mundula Jean, Fitter and Baba Franck, General worker operating one of the nine temporary 'Stage One' dewatering pumps underground at Kakula, which in total are pumping to surface approximately 3,700 litres per second.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_006full.jpg

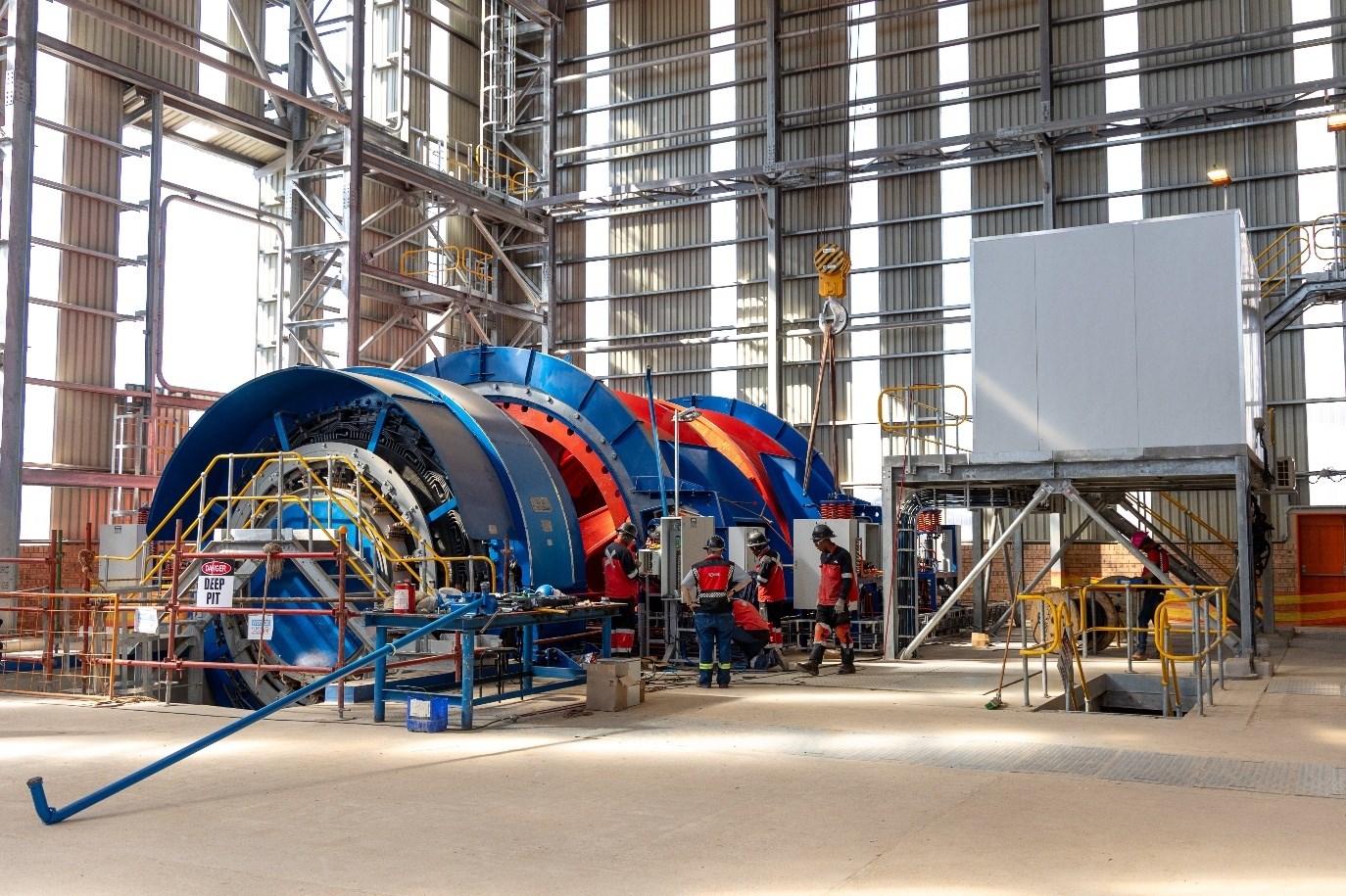

Mining Superintendents, Werner Basson and Tony Kongolo, are inspecting the recently installed rehab support underground at Kakula.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_007full.jpg

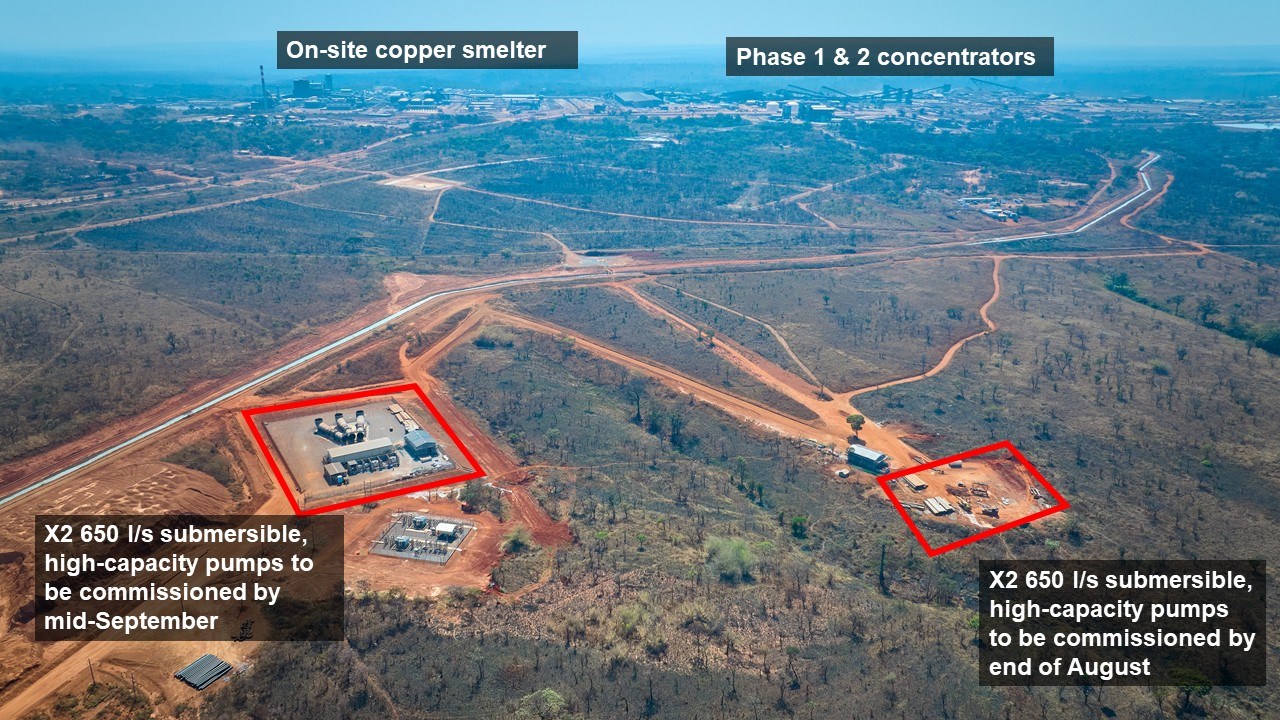

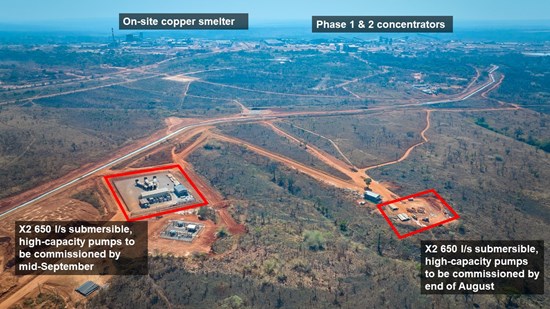

Site preparation for the Stage Two dewatering infrastructure is advancing well. Delivery of the submersible, high-capacity pumps has commenced, with pumping expected to commence next month.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_008full.jpg

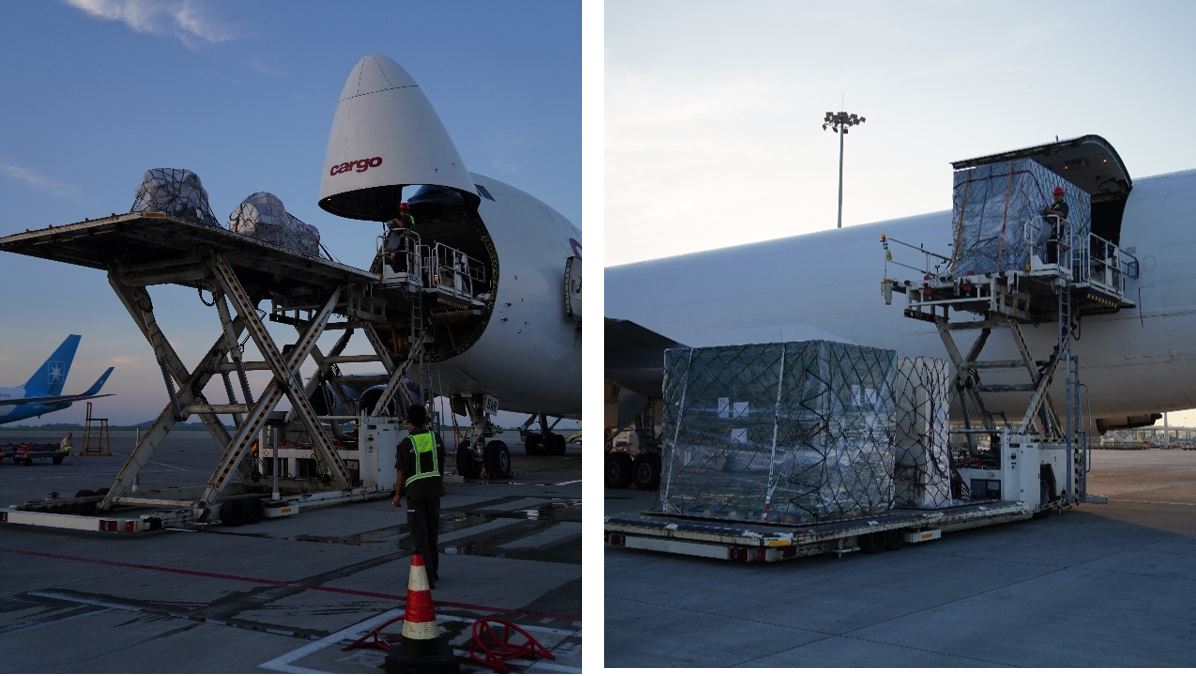

On Thursday, July 24, 2025, the first of three flights departed China, carrying the Stage Two dewatering pumping equipment. The flight landed in Lubumbashi, DRC, the following day and the cargo has since arrived on site. The remaining two flights are expected to arrive in Lubumbashi within the coming days.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_im.jpg

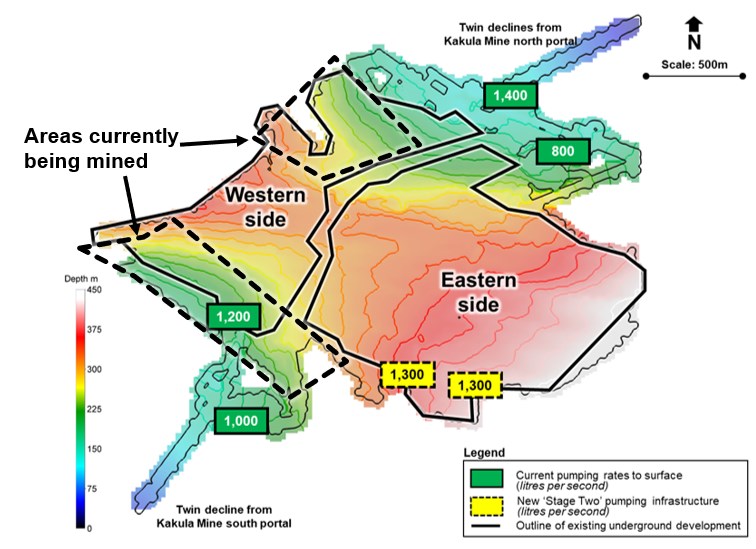

Figure 1. An illustration of the Kakula Mine's existing underground infrastructure as of July 2025, showing the depth profile of the western and eastern sections and existing Stage One vertical pumping locations (in green) and the new Stage Two vertical pumping locations (in yellow). The areas currently being mined are also highlighted.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_011full.jpg
Development to the new mining area on the far eastern side of the Kakula Mine has commenced
A new mining area, located on the far eastern side of the Kakula Mine, as indicated by the red arrows in Figure 2, will be initially accessed via two new access drives. The mining crews commenced construction of the access drives in early July.
Development of the new mining area is expected to be initially conducted in waste before entering ore from early 2026. Mining of the area is expected to commence in Q2 2026.
The new access drives will be developed simultaneously, advancing east from existing underground infrastructure. The new mining area will not require new mine access from the surface. The area will be accessed from existing underground infrastructure that is not affected by the ongoing dewatering activities.
Figure 2. An illustration of the Kakula Mine's existing underground infrastructure, showing the areas on the western side of the mine currently being mined, the copper grade profile, as well as the location of the two access drives (red arrows) to the new far eastern mining area.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_012full.jpg
Notes: Existing underground development as at July 2025. Illustration is based on the 2023 Kamoa-Kakula IDP showing the estimated average grade of each vertical stack of blocks above a
Smelter heat-up on schedule for start-up in September
The heat-up of Kamoa-Kakula's state-of-the-art, 500,000-tonne-per-annum direct-to-blister copper smelter is expected to commence in September 2025. The smelter can operate at a minimum operating capacity of
At the end of June, Kamoa-Kakula held approximately 53,600 tonnes of unsold copper in concentrate, compared to approximately 48,000 tonnes at the end of Q1 2025. Of the 53,600 tonnes of unsold copper in concentrate, approximately 31,500 tonnes are located at Kamoa-Kakula's on-site copper smelter. Kamoa-Kakula expects to hold at the smelter up to 35,000 tonnes of copper in stockpiles at the end of the third quarter as a buffer during ramp-up. Total unsold copper in concentrate at the smelter, held in stockpiles and the smelting circuit, is expected to reduce to approximately 17,000 tonnes as the smelter reaches full ramp-up.
Approximately 18,500 tonnes of the remaining unsold copper at the end of the second quarter were stored at the nearby Lualaba Copper Smelter (LCS) awaiting toll treatment. The stored copper in concentrate at LCS is expected to be treated throughout the remainder of 2025.
Kamoa-Kakula's on-site copper smelter, with the concentrate blending facility in the foreground. A buffer stockpile of up to 35,000 tonnes of copper in concentrate is being accumulated on-site in anticipation of the smelter start-up in September.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_013full.jpg
Kamoa-Kakula's Project 95 is approximately
Kamoa-Kakula's Project 95 is advancing well at
During the interim period, while the Kakula Mine is undergoing turnaround, a portion of the ore feed to the Phase 1 and 2 concentrators, sourced from both the Kakula and Kamoa mines, will be of lower grade. Kamoa-Kakula's engineering team aims to maintain a recovery rate from the lower-grade sources of at least
Project 95 construction works are advancing well, with completion expected in early Q2 2026. The foreground shows the civil works for the new thickeners, with the adjacent Phase 1 and 2 concentrator storage shed in the background, and the on-site copper smelter further behind.
To view an enhanced version of this graphic, please visit:

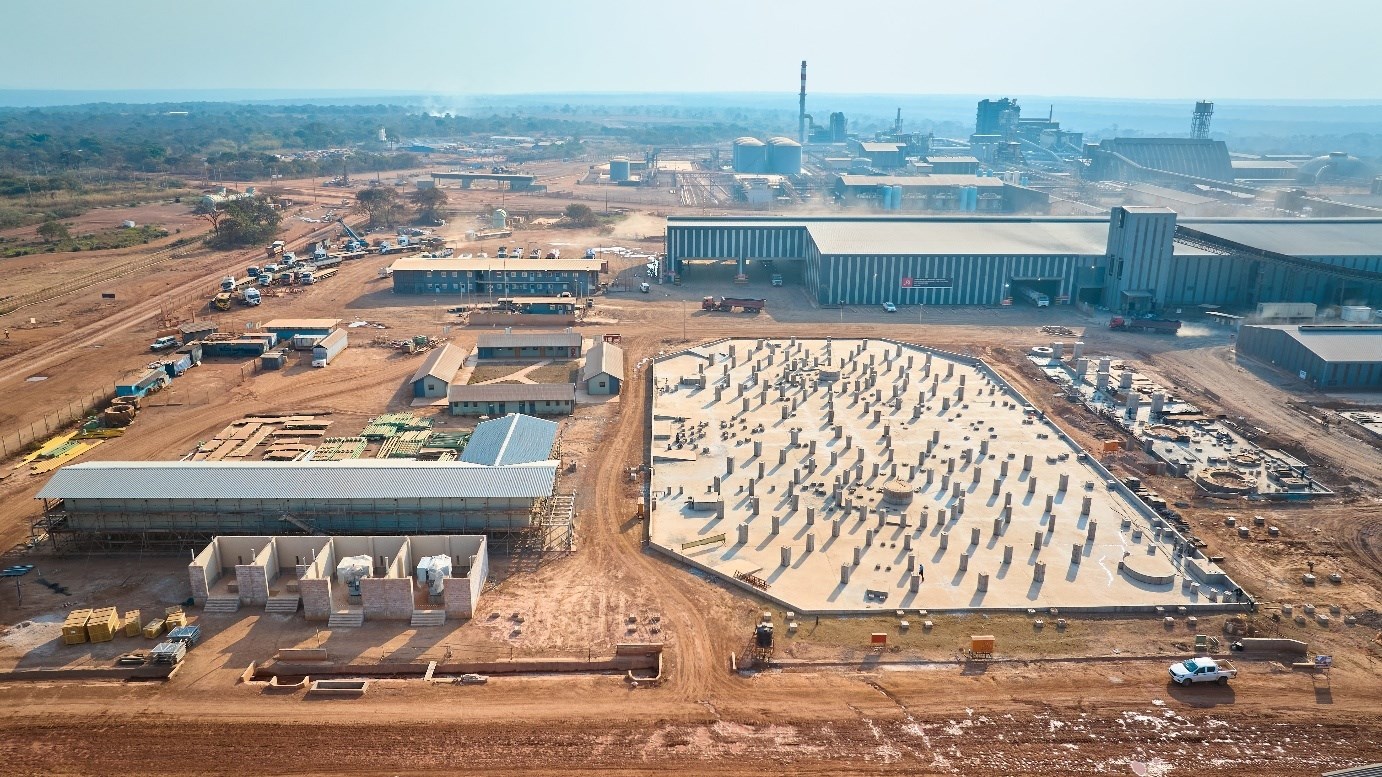

https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_014full.jpg
Final offtake agreement signed for copper anode production from Kamoa-Kakula's on-site smelter; offtake-linked advance payment facility of
In June, an agreement for the remaining
As previously announced on January 8, 2025, CITIC Metal Limited and Gold Mountains International Mining Company Limited, a subsidiary of Zijin Mining, signed offtake agreements with Kamoa Copper for a combined
Also in June, Kamoa Copper's existing
Site clearance and early earthworks for Kamoa-Kakula's 60-megawatt, on-site solar (PV) facility with battery storage have commenced
During late March and early April 2025, Kamoa Copper signed power purchase agreements (PPA) with CrossBoundary Energy DRC of Nairobi, Kenya, and La Societe Green World Energie SARL of Beijing, China, to provide up to 60 MW in baseload clean energy to Kamoa-Kakula's operations from an on-site solar facility. The facilities, which will be owned, operated, and funded by CrossBoundary Energy and Green World Energie, will comprise a total peak of 406 MW of solar photovoltaic (PV) capacity, with up to 1,107 megawatt hours (MWh) of battery energy storage (BESS) capacity. Kamoa Copper will be the sole off-taker of the electricity produced by both facilities.
Kamoa-Kakula plans to expand the on-site solar facilities further over time, targeting a capacity of up to 120 MW.
Early construction works commenced in the second quarter with geotechnical surveying of the site, site clearing, and the ordering of long-lead items, including the BESS, E-house, and mounting structures. Construction completion is expected in mid-2026.

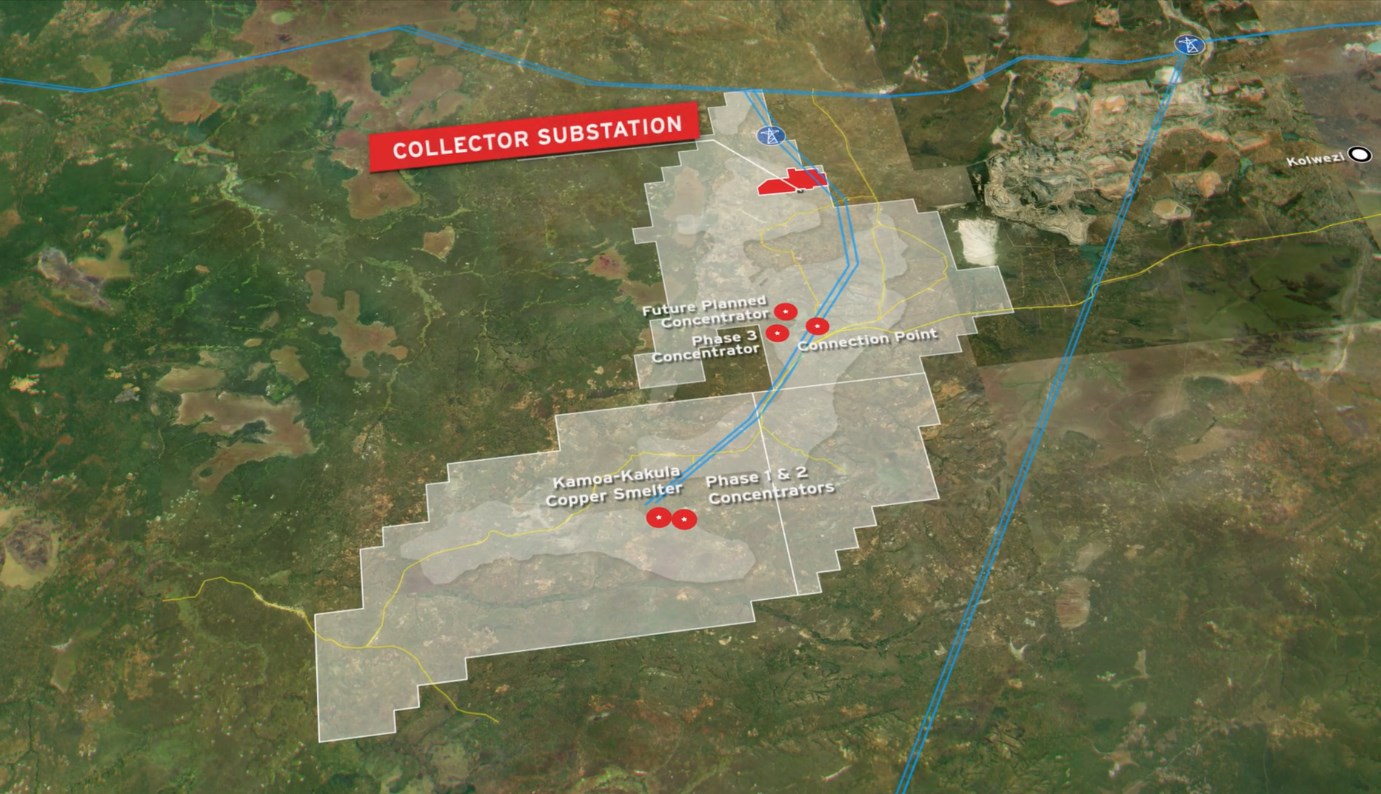

Map of Kamoa-Kakula's licence package, showing the existing powerlines (in blue) and the site of the on-site 60 MW solar PV power plant, battery storage, and substation (in red). The facility is scheduled for completion in mid-2026 and aims to supply up to
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_015full.jpg
Refurbishment of Inga II Hydroelectric facility nearing completion; mechanical installation complete and commissioning underway
Mechanical and electrical equipment installation for the refurbished Turbine #5 at the Inga II hydroelectric facility is now completed. Pre-commissioning activities have already commenced and are expected to be completed early in the fourth quarter. In addition, the replacement of the resistor banks at the Inga substation was completed during the quarter. The new resistors are expected to improve voltage stability and reliability of the network supply of electricity from the Inga hydroelectric facilities.
COPPER PRODUCTION, CAPITAL EXPENDITURE AND CASH COST GUIDANCE FOR 2025
Kamoa-Kakula 2025 Guidance | Previous | Revised | |
Cash cost (C1) ($ per pound of payable copper produced) | 1.65 – 1.85 | 1.90 – 2.20 | |
Capital expenditure ($ million) | 1,420 – 1,670 | 1,420 – 1,600 | |
Contained copper in concentrate (tonnes) | 520,000 – 580,000 | 370,000 – 420,000 |
Guidance figures are on a
Kamoa-Kakula's 2025 guidance is based on several assumptions and estimates. It involves estimates of known and unknown risks, uncertainties, and other factors that may cause the actual results to differ materially.
The 2025 production guidance, as revised on June 11, 2025, takes into account the probable effect of seismic activity as reported on May 20, 2025, and associated interruptions in mining operations at the Kakula Mine. Although mining in the western side of the Kakula Mine has restarted, risk factors remain, including that it is too early to accurately predict potential disruption caused by further unexpected seismic activity, the integrity of underground infrastructure, the ability to ramp up underground operations, the ability to complete dewatering activities and the time required to access the new mining areas. The updated 2025 production guidance is based on an assessment of these factors that management believes are reasonable at this time, given all available information. Metal reported in concentrate is before refining losses or deductions associated with smelter terms.
Cash cost (C1) guidance is based primarily on assumptions, including tonnes of ore mined, feed grades of processed copper ore, concentrator recoveries, as well as the timing and ramp-up of the on-site smelter, among other variables.
Cash cost (C1) is a non-GAAP measure used by management to evaluate operating performance and includes all direct mining, processing, stockpile rehandling charges, and general and administrative costs. Smelter charges and freight deductions on sales to the final port of destination (typically China), which are recognized as a component of sales revenues, are added to cash cost (C1) to arrive at an approximate cost of delivered finished metal.
For historical comparatives and a reconciliation to the most directly comparable measure under IFRS, see the non-GAAP Financial Performance Measures section of this release and the company's MD&A for the three and six months ended June 30, 2025.
Revised 2025 cash cost (C1) guidance for Kamoa-Kakula
The increase in cash cost (C1) guidance to
Revised 2025 capital expenditure guidance for Kamoa-Kakula
The guidance ranges provided reflected uncertainty in the turnaround of the Kakula underground mine during 2025 and 2026.
Kamoa-Kakula's revised 2025 capital expenditure of
The capital expenditure guidance range for 2026, as issued on February 19, 2025, has been widened from between
2. Kipushi Mine
Democratic Republic of Congo
The ultra-high grade Kipushi underground zinc-copper-germanium-silver-lead mine in the DRC is located adjacent to the town of Kipushi on the Zambian border, approximately 30 kilometres southwest of Lubumbashi on the Central African Copperbelt. Kipushi is approximately 250 kilometres southeast of the Kamoa-Kakula Copper Complex. Ivanhoe acquired a
Ivanhoe, together with its joint-venture partner, restarted the Kipushi zinc mine in mid-2024, with the ramp-up to steady state operations continuing during the quarter. On November 17, 2024, His Excellency Félix Tshisekedi, President of the Democratic Republic of the Congo, along with a government delegation, officially reopened the Kipushi zinc mine. Ramp up of Kipushi is ongoing, with the completion of a debottlenecking program expected to be completed in Q3 2025.
Kipushi summary of operating and financial data | |||||||
Q2 2025 | Q1 2025 | Q4 2024 | Q3 2024 | ||||
Ore tonnes milled (tonnes) | 153,342 | 151,403 | 119,619 | 108,065 | |||
Feed grade of ore processed (% zinc) | |||||||
Zinc recovery (%) | |||||||
Zinc in concentrate produced (tonnes) | 41,788 | 42,736 | 32,490 | 18,946 | |||
Payable zinc sold (tonnes) | 43,348 | 30,108 | 16,999 | – | |||
Cost of sales per pound ($ per lb.) | 1.05 | 1.23 | 1.38 | – | |||
Cash cost (C1) ($ per lb.) | 0.96 | 0.93 | 1.13 | – | |||
Realized zinc price ($ per lb.) | 1.23 | 1.29 | 1.38 | – | |||
Sales revenue before remeasurement ($'000) | 92,875 | 79,713 | 41,600 | – | |||
Remeasurement of contract receivables ($'000) | 3,882 | (2,693) | (782) | – | |||
Sales revenue after remeasurement ($'000) | 96,757 | 77,020 | 40,818 | – | |||
EBITDA ($'000) | 9,295 | 10,508 | 4,050 | – | |||
EBITDA margin (% of sales revenue) | – |
C1 cash cost per pound of payable zinc can be further broken down as follows:
Q2 2025 | Q1 2025 | Q4 2024 | |||
Mining | ($ per lb.) | 0.16 | 0.16 | 0.26 | |
Processing | ($ per lb.) | 0.08 | 0.12 | 0.12 | |
Logistics charges | ($ per lb.) | 0.50 | 0.47 | 0.48 | |
Treatment charges | ($ per lb.) | 0.07 | 0.05 | 0.17 | |
Support services | ($ per lb.) | 0.15 | 0.13 | 0.10 | |
Cash cost (C1) per pound of payable zinc sold | ($ per lb.) | 0.96 | 0.93 | 1.13 |
Cash cost (C1) is prepared on a basis consistent with the industry standard definitions by Wood Mackenzie cost guidelines, but cash cost per pound for the Kipushi Mine has been presented on a per ton sold basis to eliminate the impact of unsold tonnes of zinc concentrate in inventory. Cash cost (C1) and cash cost per pound are not measures recognized under IFRS Accounting Standards. C1 cash cost is used by management to evaluate operating performance and includes all direct mining, processing, and general and administrative costs. Smelter charges and freight deductions on sales to the final port of destination, which are recognized as a component of sales revenues, are added to C1 cash cost to arrive at an approximate cost of delivered, finished metal. C1 cash cost excludes royalties, production taxes, and non-routine charges as they are not direct production costs.
All figures are on a
Kipushi produced a near-record 41,788 tonnes of zinc; zinc production rates expected to significantly improve in the second half of 2025
Summary of quarterly production data from Kipushi
Q2 2025 | Q1 2025 | Q4 2024 | Q3 2024 | |||||
Kipushi Concentrator | ||||||||
Ore tonnes milled (tonnes) | 153,342 | 151,403 | 119,619 | 108,065 | ||||
Feed grade of ore processed (% zinc) | 33.37 | 32.16 | 31.72 | 32.12 | ||||
Zinc recovery (%) | 85.22 | 87.93 | 85.07 | 75.78 | ||||
Zinc in concentrate produced (tonnes) | 41,788 | 42,736 | 32,490 | 18,946 |
Data in bold denotes a quarterly record.
Zinc production from the Kipushi concentrator continued to improve during the second quarter as the ramp-up advances to steady state. Multiple production records were achieved in May, with a record 60,182 tonnes of ore processed, producing a record 18,305 tonnes of zinc. In June, only 41,107 tonnes of ore were processed due to a temporary feed of lower-grade ore for the three weeks ahead of a planned shutdown, and a nine-day shutdown to integrate the first phase of the debottlenecking program.
The first phase of the debottlenecking program focused on improving the tailings pumping systems to enable the concentrator to consistently operate at its nameplate capacity. This work is now complete.
Since the completion of the first phase of debottlenecking program, the Kipushi concentrator has achieved a number of additional production records. The daily zinc production record of 898 tonnes of zinc in concentrate, which was achieved in mid-July, is equivalent to 327,000 tonnes of zinc on an annualized basis. The weekly zinc production record of 5,545 tonnes of zinc in concentrate, which was also achieved in mid-July, is equivalent to 289,000 tonnes of zinc on an annualized basis.
The second and final phase of the debottlenecking program will upgrade certain processing equipment within the concentrator to boost the throughput by
Concurrent with the integrations of the debottlenecking program, the June shutdown also included upgrades to the concentrator's DMS circuit. As reported on October 7, 2024, excessive fine material in the ore (fines) was causing unscheduled shutdowns due to blockages in the DMS circuit. Following the completion of the upgrades, the availability of the DMS has increased from approximately 6 hours per day to 16 hours per day, resulting in a significant reduction in lost operating time. Further upgrades will take place during the planned August shutdown, after which DMS circuit availability is expected to further increase up to 22 hours per day.
Based on the completion of the above initiatives, Kipushi's 2025 production guidance remains unchanged at between 180,000 and 240,000 tonnes of zinc.

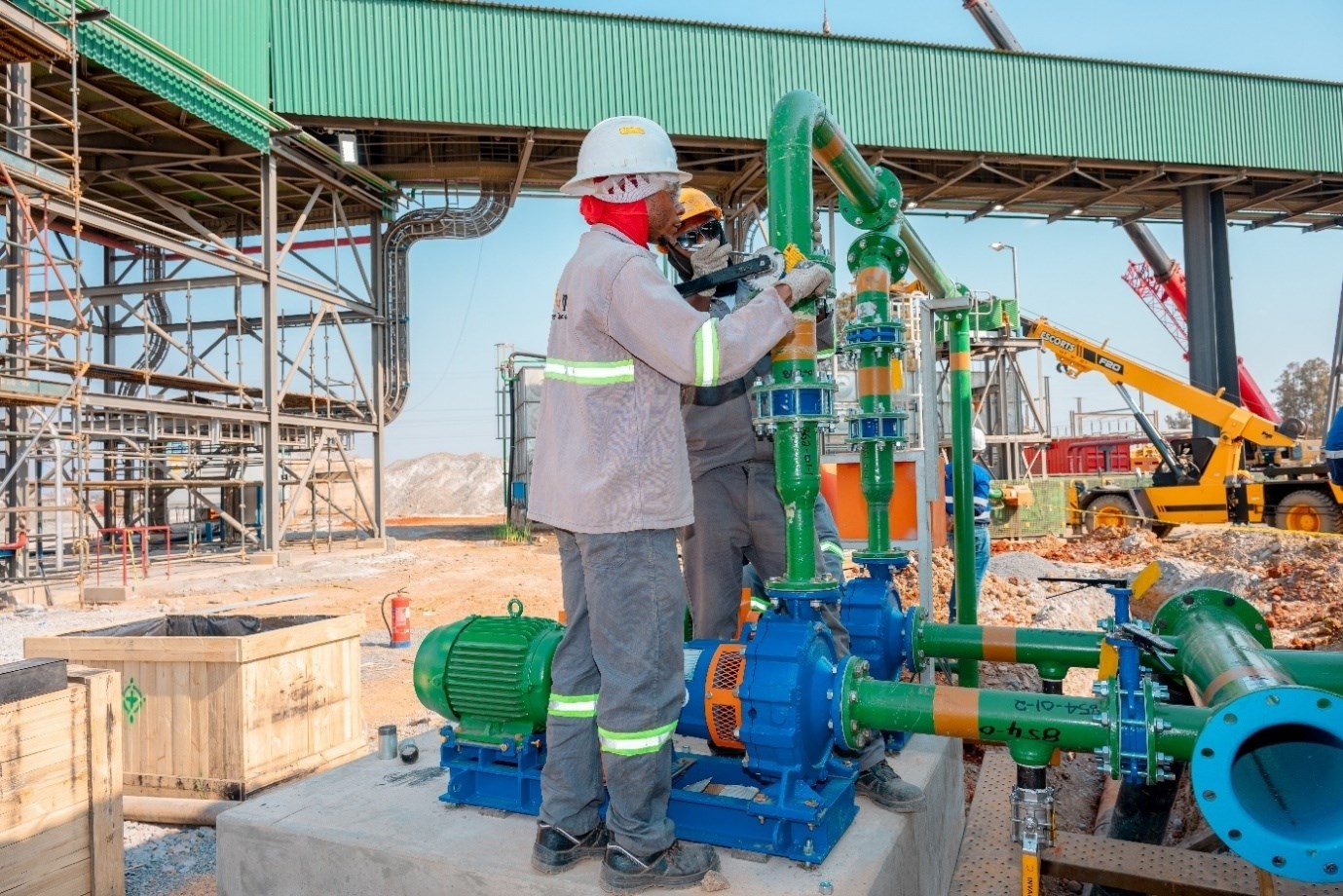

Fitters Albert Mukendi and Honoré Mwilambwe are installing piping and instrumentation as part of Kipushi's debottlenecking program. The debottlenecking program is nearing completion and is expected to increase concentrator processing capacity by
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_016full.jpg
Kipushi's project engineering team continues its strong track record of safe and reliable project delivery. The debottlenecking program, which commenced in Q3 2024, continues to advance on schedule with zero lost time injuries (LTI) reported. Since September 2022, when construction of the Kipushi concentrator commenced, up until today, the project engineering team has not recorded a single LTI, an incredibly rare industry feat.
3. Platreef Project
South Africa
The Platreef Project is located on the Northern Limb of the Bushveld Igneous Complex in Limpopo Province – approximately 280 kilometres northeast of Johannesburg and eight kilometres from the town of Mokopane in South Africa. The project is owned by Ivanplats (Pty) Ltd. (Ivanplats), which is
Platinum-group metals (PGM) mineralization in the Northern Limb is primarily hosted within a 30-kilometre mineralized sequence called the Platreef. The Platreef Project is contiguous with, and along strike from, Valterra's (formerly known as Anglo Platinum) Mogalakwena PGM operations. The Platreef Project hosts an underground deposit of platinum-group metals, nickel, copper, and gold mineralization, called the Flatreef deposit. The Flatreef is a thick, relatively flat-lying and high-grade orebody, which is amenable to highly mechanized, highly productive, underground bulk mining methods.
Since 2007, Flatreef has become one of the largest undeveloped precious metals deposits globally, with 56 million ounces in platinum equivalent Indicated Mineral Resources and 74 million ounces in platinum equivalent Inferred Mineral Resources, at a 2.0 g/t platinum, palladium, rhodium, and gold (3PE + AU) cut-off. The Flatreef is also host to one of the world's largest undeveloped nickel sulphide mineral resources.

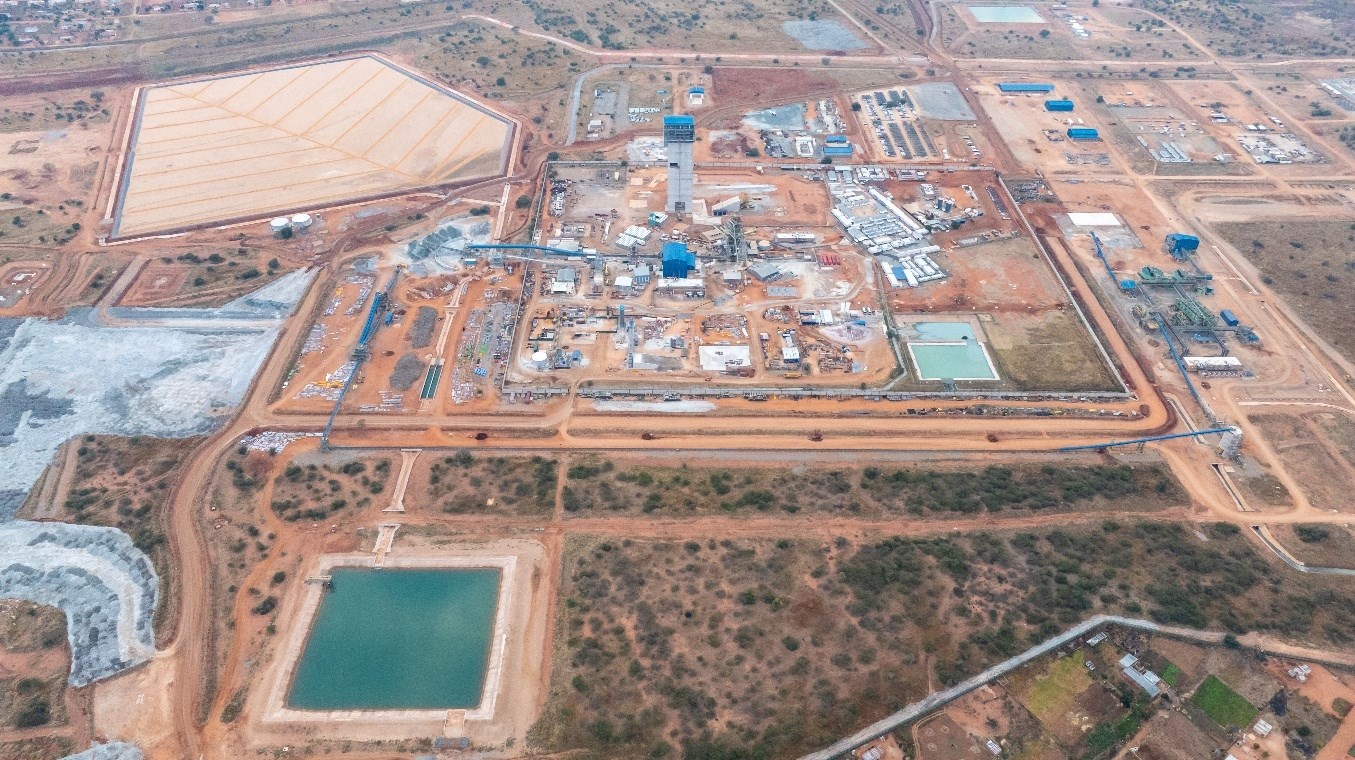

Aerial view of the Platreef Mine, showing the central shaft infrastructure, the Phase 1 concentrator (right), the dry stack tailings facility (top left), as well as the reef development ore stockpiles (bottom left).
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_017full.jpg
Platreef, one of the world's largest undeveloped precious metals deposits, set to be lowest cost platinum, palladium, rhodium, and gold producer, with significant nickel and copper
On February 18, 2025, two independent studies were completed on the three-phase development of the Platreef Mine. This included an updated Feasibility Study on the Phase 2 expansion to 4.1 million tonnes per annum (Mtpa) of processing capacity, as well as a Preliminary Economic Assessment covering a new Phase 3 expansion to 10.7 Mtpa of processing capacity. The excellent results from both studies reinforce the industry-leading margins of the multi-generational Platreef Mine.
The Platreef Mine is projected to be the lowest-cost primary platinum-group-metals producer globally. The Phase 2 life-of-mine total cash cost is estimated to be
Following the Phase 3 expansion, as shown in Figure 3, the Platreef Mine is expected to be one of the world's largest primary platinum group metal producers on a platinum-equivalent basis.
First production from the Phase 1 concentrator is expected in Q4 2025, ramping up to an annualized production of approximately 100,000 ounces of 3PE+Au. Development has already commenced on the Phase 2 expansion, which is expected to be completed 2 years later in Q4 2027. Annualized production increases almost five-fold following the Phase 2 expansion to over 460,000 ounces. of 3PE+Au, plus approximately 9,000 tonnes of nickel and 6,000 tonnes of copper. The Phase 3 expansion further doubles annualized production to over 1 million ounces of 3PE+Au, plus approximately 22,000 tonnes of nickel and 13,000 tonnes of copper.

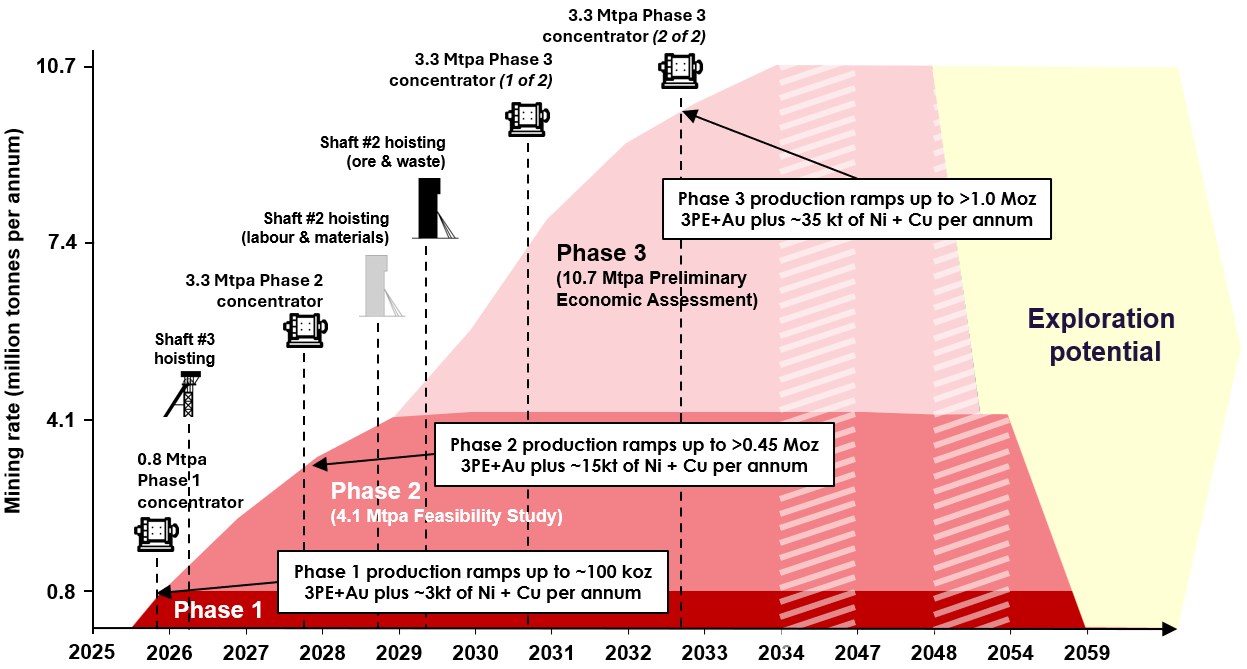

Figure 3: Phased development schematic of the Platreef Mine, showing the annualized mining rate over life of mine.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_018full.jpg
First production from the Platreef Mine's Phase 1 concentrator is on schedule for first production in the fourth quarter
As announced on May 8, 2025, underground development of the Flatreef orebody on the 850-metre level commenced on April 30, 2025. Since then, a total of 90 metres of reef development in ore has been completed. From now on, the rate of reef development is expected to increase to 80 metres per month. Reef development at the 750-metre level is scheduled to commence in October 2025.
Development ore is being hoisted to the surface and stored in stockpiles. The Ivanplats team aims to accumulate a stockpile of approximately 60,000 tonnes of development ore ahead of the first feed into the Phase 1 concentrator. First production from the Platreef Phase 1 concentrator remains on track to take place in the fourth quarter. The concentrator will be fed primarily by development ore during the initial stages of ramp-up. Stoping (production mining) is expected to commence in Q1 2026, following the completion of Shaft #3. The proportion of ore from stoping will gradually increase, compared with development ore, as the ramp-up advances.
The underground delineation drilling program, which commenced last year, is progressing well. The first ore block on the 850-metre level, where the initial stoping will take place, has been drilled, and the assays reconcile well with Ivanplats' grade models.
Equipping of Shaft #3 continues to progress well and is on schedule to be 'ready to hoist' ore in Q1 2026. The shaft's 5.1-metre-diameter barrel support is complete from surface to shaft bottom at 950 metres depth, and the excavation for the shaft loading box has also been completed. The head-gear assembly and rock winder installation are advancing well, with the rock winder mechanical installation nearing completion.
As the mining rate increases, as shown in Figure 3, the number of mining crews at Platreef is expected to double over the next 18 months. Currently, there are five development crews, primarily focused on reef development at the 850-metre and 950-metre levels. Two additional mining crews will be added during the second half of 2025, with a further three crews to be added in 2026. The increased number of crews aims to increase the mining development rate across all three levels from 500 metres per month at the end of 2025 to over 800 metres per month by the end of 2026.
Significant increase in platinum and palladium prices boosts project value
On February 18, 2025, Ivanhoe Mines announced the results of the 2025 Platreef Integrated Development Plan, which included two completed independent studies covering the three-phase development of the Platreef mine. This comprised the 4.1 Mtpa (Phase 2) expansion Feasibility Study, and the 10.7 Mtpa (Phase 3) expansion Preliminary Economic Assessment (PEA).
Since the 2025 Platreef Integrated Development Plan was released, the spot prices of platinum and palladium have risen by
Negotiations for the Platreef Mine's Phase 2 project finance are advancing well
In December 2023, Ivanplats concluded a
Following the completion of the 4.1 Mtpa feasibility study, Ivanhoe Mines has been focused on arranging an enlarged project finance package for the majority of the expansion capital requirements for Phase 2.
Negotiations are advancing well for a
Ivanhoe is anticipating that the new financing will be in place during Q1 2026.
Financing for the future Phase 3 expansion is expected to be underpinned by cash flow generated from Platreef's Phase 1 and 2 operations.
Shaft #3 head gear assembly and rock winder installation are advancing well, with the mechanical installation of the rock winder (pictured below) nearing completion. Shaft #3 is on schedule to be ready to hoist in Q1 2026.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_019full.jpg

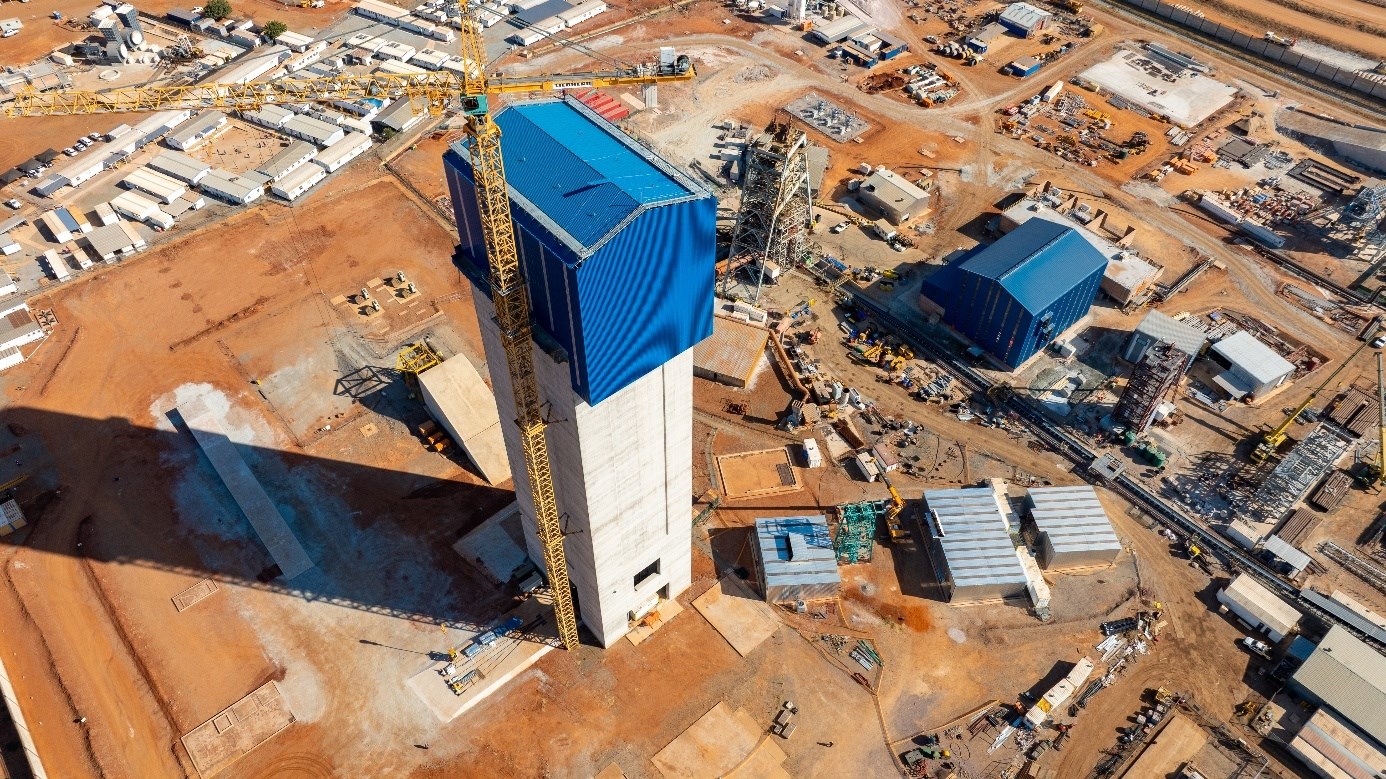

Structural steel and cladding to house the winder at the top of the Shaft #2 headgear were recently completed, taking the total height of Shaft #2 to 96 metres.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_020full.jpg
4. Global Exploration Portfolio
Western Forelands Exploration Project, DRC
The Western Forelands Exploration Project consists of a licence package covering 2,390 km2 adjacent to the Kamoa-Kakula Copper Complex. The area of the Western Forelands licence package is approximately six times larger than that of the Kamoa-Kakula Copper Complex.
Drilling efforts during the second quarter focused on the Makoko, Makoko West, and Kitoko areas, now called the Makoko District. The drilling program employed wide-spaced drilling to delineate the extent of the mineralized envelope. At Kitoko, mineralization remains open down-dip to the southeast. The deepest hole drilled to date in 2025 intersected mineralization, indicating strong potential for further resource expansion. Additionally, drilling south of Makoko West has confirmed mineralization between Makoko and Kitoko.
During the second quarter, nine contractor-operated diamond drill rigs were active, completing a total of 14,843 meters of drilling across 27 holes. This included four wedge holes, which were deviated from the original drill holes at depth. These wedges are used to collect additional mineralized samples for future metallurgical testing and to bypass difficult ground conditions.
An Audio-frequency Magnetotellurics (AMT) survey began in May and continued through June, covering two lines extending from the Kibaran basement across the Western Foreland Shelf. Completion is expected during the third quarter. A ground gravity survey is scheduled to begin in August.
Drilling doubles the size of Makoko-Kitoko copper discoveries in 18 months
On May 14, 2025, the company announced the independently verified, updated Mineral Resource estimate for the Makoko District. Since the maiden Mineral Resource on Makoko and Kiala was announced on November 13, 2023, more than 86,000 metres of diamond drilling were completed in the Western Forelands up to February 2025. Since November 2023, the Makoko District has increased by 2 kilometres to 13 kilometres in strike length, and the total contained copper has approximately doubled.
The Makoko District ranks as the world's fifth-largest copper discovery since Kakula in 2015. The Makoko discovery was first made in 2018 when drilling intersected flat-lying, sedimentary-hosted copper mineralization geologically similar, and at comparable depths to the nearby Kamoa and Kakula orebodies. Subsequent drilling has delineated a continuously mineralized region, now called the Makoko District, joining the three discoveries of Makoko, Makoko West, and Kitoko.
Copper mineralization in the Makoko District currently spans a corridor at least 13 kilometres in length and between 1.7 kilometres and 5.8 kilometres wide. The eastern edge of the Makoko District is situated approximately 10 kilometres from the western edge of Kakula. Mineralization remains open to the northeast and downdip of the current footprint, with a high potential for further resource expansion.
There is abundant deposition of copper across the Makoko District, with approximately two-thirds of holes drilled intersecting copper. In addition, there are higher-grade sub-zones at Makoko, Makoko West, and Kitoko, which mirror the style of mineralization of the Kamoa orebody that feeds the Phase 3 concentrator and will feed the future Phase 4 concentrator. The highest-grade section of the Makoko deposit occurs between 300 and 600 metres in depth and coincides with the Indicated Resource area.
The updated Mineral Resource estimate for the Makoko District is based on the results of 147,000 metres drilled in 311 holes, of which 86,000 metres in 123 holes have been added since the maiden Mineral Resource was announced in November 2023. The total area of the updated Mineral Resource has increased by 37.4 km2, with the Indicated Resource covering 1.6 km2 and the Inferred Resource covering 57 km2. The average dip of the mineralized zone in the Mineral Resource is between 11 and 18 degrees, dipping to the southeast.

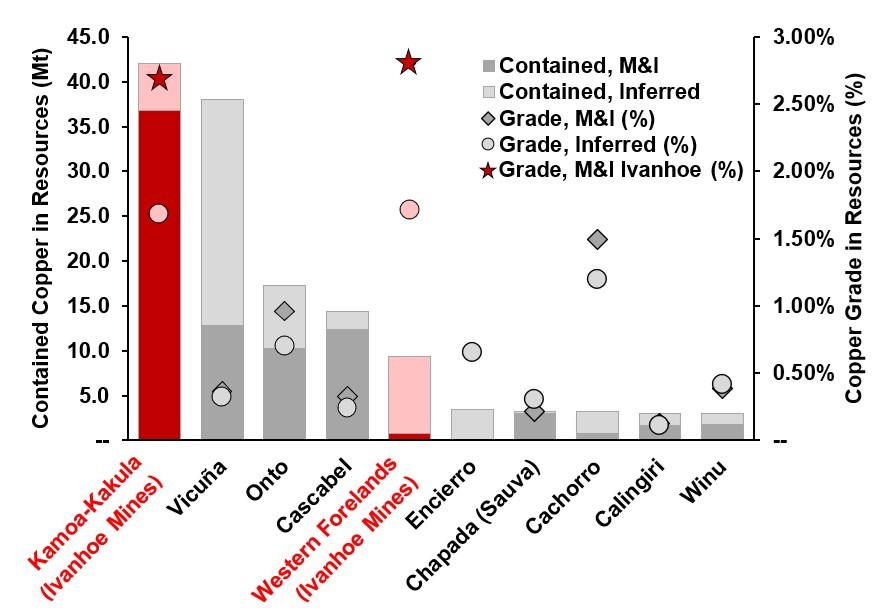

Figure 4: The Makoko District ranks as the world's fifth-largest copper discovery of the past decade. Ivanhoe's geologists have discovered a total of 52.5 million tonnes (115.7 billion pounds) of contained copper in the Western Foreland Shelf, including Kamoa-Kakula.
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/3396/260694_a06b2567342ff88f_021full.jpg
Source: Company filings, S&P Global Market Intelligence.
Notes: Chart ranks all other new copper discoveries made since 2015 based on contained copper in resources on a
Highlights of the interim, updated Mineral Resource estimate for the Makoko District
The interim, updated Mineral Resource estimate for the Makoko District, which has an effective date of May 1, 2025, was prepared by Ivanhoe Mines under the direction of the MSA Group of Johannesburg, South Africa, in accordance with the 2014 CIM Definition Standards for Mineral Resources and Mineral Reserves:
- Indicated Resources total 27.7 million tonnes at a grade of
2.79% copper, containing 773,000 tonnes (1.7 billion pounds) of copper at a1% copper cut-off. At a higher1.5% copper cut-off, Indicated Resources total 25.3 million tonnes at a grade of2.93% copper, containing 741,000 tonnes (1.6 billion pounds) of copper. - Inferred Resources total 494 million tonnes at a grade of
1.70% copper, containing 8.38 million tonnes (18.4 billion pounds) of copper, at a1% copper cut-off. At a higher1.5% copper cut-off, Inferred Resources total 221 million tonnes at a grade of2.23% copper, containing 4.93 million tonnes (10.9 billion pounds) of copper.
The Makoko District spans a mineralized strike length of 13 kilometres, with the Kitoko area extending laterally down-dip, to the southeast for approximately six kilometres. The stratiform copper lies close to surface along the western edge of Makoko and Makoko West, dipping down towards the southeast to Kitoko. Mineralization depth from surface ranges from 200 metres to as deep as 1,250 metres.
The highest-grade zone at Makoko lies between 400 and 700 metres below surface and coincides with the Indicated Resource area, which has been drilled on a 200-metre by 200-metre grid. A second, sub-parallel zone of shallower mineralization occurs up-dip across a strike extent of approximately 11 kilometres. Closer-spaced drilling in 2023 connected these two zones, allowing the entire area to be classified in the Inferred category of the 2025 Mineral Resource update.
North-Western Province, Zambia
As announced on April 2, 2025, the Government of the Republic of Zambia granted Ivanhoe Mines a 7,757-square-kilometre package of new exploration licences in the highly-prospective North-Western Province of Zambia. Ivanhoe's thesis behind the strategically selected licence package is to explore for an extension of the Central African Copperbelt. The award of licences follows a memorandum of understanding (MOU) that was signed between Ivanhoe Mines and the Republic of Zambia's Ministry of Mines and Minerals Development (Ministry of Mines) on September 10, 2024.
The new licence package is strategically located between Ivanhoe's Western Forelands Exploration Project (230 km to the northeast) and the company's Angolan exploration licence package (130 km southwest). The Zambia licences cover an area over three times larger than the Western Forelands Exploration Project.
Ivanhoe's geological team are targeting copper mineralization associated with Basement Domes, Katangan-age sediment-hosted copper systems, and iron-oxide-copper-gold (IOCG) systems. The western edge of the Central African Copperbelt in the DRC hosts the Western Foreland Shelf, where the Kamoa-Kakula Copper Complex and the Mineral Resources of Makoko and Kiala in the Western Forelands are located. Ivanhoe's geological team believes that the Western Foreland Shelf facies of the Nguba Group sediments continue to arc southwest into Zambia and Angola.
During the quarter, work was mostly focussed on recruitment of key personnel and establishing a local core storage warehouse. Stakeholder engagement on the licence area commenced after quarter end, which started with meeting many of the traditional leaders and district administrators across the licence area. In parallel, desktop work continues on the recovery of historical geophysical and geological data on the licence area, which was conducted by the previous licence holders, such as BHP and Anglo American.
Moxico and Cuando Cubango Provinces, Angola
Ivanhoe's exploration team is also targeting Western-Forelands-style sedimentary copper mineralization in Angola. The team is deploying its exploration expertise developed from its discoveries in the Western Forelands and from Kamoa-Kakula to its vast greenfield exploration package in Angola.
The team has developed an exploration thesis that the DRC's Western Forelands Shelf extends into eastern Angola. As announced on November 27, 2023, Ivanhoe acquired approximately 22,000 km2 of prospecting rights in the Moxico and Cuando Cubango provinces of Angola. Concurrently, Ivanhoe signed a mining investment contract with the Angolan National Agency for Mineral Resources.
After receiving the required permitting, access to the licenses was first made by Ivanhoe's geologists in August 2024. The team undertook a mapping and baseline soil geochemical sampling program over an area of 600 km2, which covered the same portion of the license flown by the airborne electromagnetic survey. A ground-based geophysics program was also completed, including Audio-frequency (AMT) and Magnetotellurics (MT) in conjunction with a Passive Seismic survey, down the eastern portion of the license area.
Results from the 2024 work streams have been analyzed, with several targets generated for drilling. The contract for 2025 diamond drilling program was recently awarded with mobilization expected in the coming weeks. Two diamond core drill rigs will conduct an initial 6,400-metre stratigraphic diamond drill program.
The Chu-Sarysu Basin Exploration Joint Venture, Central Kazakhstan
Ivanhoe Mines has formed an exploration joint venture with UK-based private company Pallas Resources to explore the Chu-Sarysu Copper Basin in Kazakhstan, the world's third-largest sediment-hosted copper district. The joint venture covers a highly prospective licence package of up to 16,911 km2, which spans an accumulated dataset of Soviet-era exploration data.
As announced on February 12, 2025, Ivanhoe has committed to fund
Exploration activities began on the joint venture licences in the first quarter of 2025, including the hiring of an exploration team and tendering of the drilling and airborne geophysics contracts. Drilling subsequently commenced in July 2025, with the mobilization of two rigs for a maiden 17,500-metre diamond drilling program. In addition, over
Mokopane Feeder Project, South Africa
Ivanhoe Mines is exploring the Northern Limb of South Africa's Bushveld Complex, adjacent to Ivanplats' Platreef Project. Ivanhoe's geologists are testing a large gravity-high anomaly based on wide-spaced historical Council for Geoscience data. The anomaly is interpreted to represent. The working hypothesis is that the large gravity-high anomaly is interpreted by scientific research to represent a potential primary feeder zone of magma and mineralization into the Northern Limb of the Bushveld Complex, essentially the sources of mineralization that make up the Platreef and other Northern Limb deposits.
The collection, interpretation, and review process of all geological and geophysical data was completed early in 2024. The geological understanding of the anomaly continues to evolve, with numerous targets identified for drilling.
Following the completion of heritage surveys and community engagement around the proposed drilling sites, Geosearch, a diamond drilling contractor, commenced a 6,000-metre diamond-core drill program in Q1 2025. By the end of the second quarter, the drilling of the first hole of 2,000 metres was completed. The drill rig is currently being mobilized to a new site nearby, while downhole geophysics is being conducted on the completed hole. Completion of the program is expected by the end of 2025.
SELECTED QUARTERLY FINANCIAL INFORMATION
The following table summarizes selected financial information for the prior eight quarters. Revenue from commercial production at the Kipushi Mine commenced in Q4 2024. All revenue from production at Kamoa-Kakula is recognized within the Kamoa Holding joint venture. Ivanhoe did not declare or pay any dividend or distribution in any financial reporting period.
Three months ended | ||||||
June 30, | March 31, | December 31, | September 30, | |||
2025 | 2025 | 2024 | 2024 | |||
$'000 | $'000 | $'000 | $'000 | |||
Revenue | 96,757 | 77,020 | 40,818 | – | ||
Cost of sales | (100,217) | (81,771) | (51,563) | – | ||
Share of profit from joint venture | 15,704 | 107,948 | 73,620 | 83,507 | ||
Finance income | 43,583 | 41,623 | 56,041 | 60,164 | ||
Deferred tax recovery | 7,842 | 4,374 | 12,663 | 575 | ||
General administrative expenditure | (10,378) | (9,957) | (19,633) | (10,573) | ||
Exploration and project evaluation expenditure | (8,585) | (9,145) | (15,845) | (12,813) | ||
Finance costs | (4,947) | (7,838) | (6,849) | (471) | ||
Share-based payments | (4,447) | (2,418) | (2,977) | (7,504) | ||
Loss on fair valuation of embedded derivative liability | – | – | – | (4,171) | ||
Profit (loss) attributable to: | ||||||
Owners of the Company | 44,051 | 129,760 | 99,344 | 117,942 | ||
Non-controlling interests | (8,726) | (7,560) | (11,338) | (9,760) | ||
Total comprehensive income (loss) attributable to: | ||||||
Owners of the Company | 60,900 | 135,033 | 60,964 | 141,525 | ||
Non-controlling interest | (7,066) | (7,161) | (15,158) | (7,469) | ||
Basic profit per share | 0.03 | 0.10 | 0.07 | 0.09 | ||
Diluted profit per share | 0.03 | 0.10 | 0.07 | 0.09 | ||
Three months ended | ||||||
June 30, | March 31, | December 31, | September 30, | |||
2024 | 2024 | 2023 | 2023 | |||
$'000 | $'000 | $'000 | $'000 | |||
Share of profit from joint venture | 89,616 | 45,165 | 49,272 | 69,829 | ||
Finance income | 62,873 | 62,457 | 63,110 | 56,671 | ||
(Loss) gain on fair valuation of embedded derivative liability | (20,727) | (139,271) | (39,961) | 12,218 | ||
General administrative expenditure | (12,345) | (14,001) | (14,947) | (9,841) | ||
Finance costs | (32,871) | (8,944) | (6,741) | (8,752) | ||
Share-based payments | (8,505) | (8,933) | (7,715) | (6,732) | ||
Exploration and project evaluation expenditure | (10,589) | (8,901) | (8,637) | (6,264) | ||
Deferred tax recovery | 1,398 | 3,221 | 4,201 | 1,212 | ||
(Loss) profit attributable to: | ||||||
Owners of the Company | 76,401 | (65,552) | 27,739 | 112,510 | ||
Non-controlling interests | (9,885) | (3,858) | (1,980) | (4,988) | ||
Total comprehensive (loss) income attributable to: | ||||||
Owners of the Company | 88,223 | (73,648) | 37,155 | 109,681 | ||
Non-controlling interest | (8,672) | (4,728) | (1,003) | (5,250) | ||
Basic (loss) profit per share | 0.06 | (0.05) | 0.02 | 0.09 | ||
Diluted (loss) profit per share | 0.06 | (0.05) | 0.02 | 0.08 |
DISCUSSION OF RESULTS OF OPERATIONS
Review of the three months ended June 30, 2025, vs. June 30, 2024
The company recorded a profit for Q2 2025 of
The Kamoa-Kakula Copper Complex sold 101,714 tonnes of payable copper in Q2 2025, realizing revenue of
Three months ended | |||
June 30, | |||
2025 | 2024 | ||
$'000 | $'000 | ||
Company's share of profit from joint venture | 15,704 | 89,616 | |
Interest on loan to joint venture | 34,927 | 58,123 | |
Company's income recognized from joint venture | 50,631 | 147,739 |
The company's share of profit from the Kamoa Holding joint venture was
The company's share of profit from the Kamoa Holding joint venture is broken down in the following table:
Three months ended | ||||
June 30, | ||||
2025 | 2024 | |||
$'000 | $'000 | |||
Revenue from contract receivables | 868,846 | 813,817 | ||
Remeasurement of contract receivables | 6,443 | 3,256 | ||
Revenue | 875,289 | 817,073 | ||
Cost of sales | (640,194) | (324,428) | ||
Gross profit | 235,095 | 492,645 | ||
General and administrative costs | (40,087) | (26,712) | ||
Amortization of mineral property | (4,799) | (3,071) | ||
Profit from operations | 190,209 | 462,862 | ||
Finance costs | (52,873) | (71,143) | ||
Impairment | (59,025) | – | ||
Foreign exchange loss | (15,926) | (12,258) | ||
Finance income and other | 5,405 | 1,058 | ||
Profit before taxes | 67,790 | 380,519 | ||
Current tax expense | (147,856) | (141,020) | ||
Deferred tax recovery (expense) | 116,773 | (3,056) | ||
Profit after taxes | 36,707 | 236,443 | ||
Non-controlling interest of Kamoa Holding | (4,982) | (55,401) | ||
Total comprehensive income for the period | 31,725 | 181,042 | ||
Company's share of profit from joint venture ( | 15,704 | 89,616 |
The realized and provisional copper prices used for the remeasurement (mark-to-market) of contract receivables for the three months ended June 30, 2025, and for the same period in 2024, can be summarized as follows:
Three months ended | |||
June 30, | |||
2025 | 2024 | ||
$'000 | $'000 | ||
Realized during the period - open at the start of the period | |||
Opening forward price ($/lb.)(1) | 4.44 | 3.99 | |
Realized price ($/lb.)(1) | 4.27 | 4.30 | |
Payable copper tonnes sold | 64,422 | 29,142 | |
Remeasurement of contract receivables ($'000) | (23,066) | 20,218 | |
Realized during the period - new copper sold in the current period | |||
Provisional price ($/lb.)(1) | 4.23 | 4.31 | |
Realized price ($/lb.)(1) | 4.42 | 4.37 | |
Payable copper tonnes sold | 63,522 | 31,345 | |
Remeasurement of contract receivables ($'000) | 25,473 | 4,453 | |
Open at the end of the period - new copper sold in current period | |||
Provisional price ($/lb.)(1) | 4.45 | 4.47 | |
Closing forward price ($/lb.)(1) | 4.50 | 4.32 | |
Payable copper tonnes sold | 38,192 | 64,555 | |
Remeasurement of contract receivables ($'000) | 4,036 | (21,415) | |
Total remeasurement of contract receivables ($'000) | 6,443 | 3,256 |
(1) Calculated on a weighted average basis
The finance costs recognized in the Kamoa Holding joint venture can be broken down as follows:
Three months ended | ||||
June 30, | ||||
2025 | 2024 | |||
$'000 | $'000 | |||
Interest on shareholder loans | 70,521 | 117,386 | ||
Interest on provisional and advance payment facilities | 35,137 | 26,704 | ||
Interest on syndicated loans | 11,376 | – | ||
Interest on bank loans and overdraft facilities | 7,250 | 3,280 | ||
Lease liability unwinding | 1,651 | 1,778 | ||
Interest on equipment financing facilities | 1,643 | 2,537 | ||
Rehabilitation unwinding | 759 | – | ||
Interest capitalized as borrowing costs | (75,464) | (80,542) | ||
52,873 | 71,143 |
Ivanhoe's exploration and project evaluation expenditure amounted to
Finance income for Q2 2025 amounted to
The company sold 43,348 tonnes of payable zinc produced by the Kipushi Mine in the second quarter of 2025, realizing revenue of
The realized, provisional, and forward zinc prices used for the remeasurement (mark-to-market) of contract receivables of Kipushi for the three months ended June 30, 2025, can be summarized as follows:
Q2 2025 | Q1 2025 | ||
$'000 | $'000 | ||
Realized during the period - open at the start of the period | |||
Opening forward price ($/lb.)(1) | 1.29 | 1.34 | |
Realized price ($/lb.)(1) | 1.31 | 1.28 | |
Payable zinc tonnes sold | 9,690 | 11,596 | |
Remeasurement of contract receivables ($'000) | 425 | (1,496) | |
Realized during the period - new zinc sold in the current period | |||
Provisional price ($/lb.)(1) | 1.19 | 1.32 | |
Realized price ($/lb.)(1) | 1.20 | 1.30 | |
Payable zinc tonnes sold | 21,800 | 20,432 | |
Remeasurement of contract receivables ($'000) | 484 | (878) | |
Open at the end of the period - new zinc sold in the current period | |||
Provisional price ($/lb.)(1) | 1.20 | 1.31 | |
Closing forward price ($/lb.)(1) | 1.26 | 1.29 | |
Payable zinc tonnes sold | 21,547 | 9,676 | |
Remeasurement of contract receivables ($'000) | 2,973 | (319) | |
Total remeasurement of contract receivables ($'000) | 3,8824 | (2,693) |
(1) Calculated on a weighted average basis
Review of the six months ended June 30, 2025, vs. June 30, 2024
The company recorded a profit of
The company's share of profit from the Kamoa Holding joint venture for the six months ended June 30, 2025, was impacted by the seismic activity on the eastern side of the Kakula Mine in May 2025, which resulted in the suspension of underground mining activities at the Kakula Mine until June 7, 2025.
The Kamoa-Kakula Copper Complex sold 211,677 tonnes of payable copper in the first six months of 2025, realizing revenue of
Six months ended | |||
June 30, | |||
2025 | 2024 | ||
$'000 | $'000 | ||
Company's share of profit from joint venture | 123,652 | 134,781 | |
Interest on loan to joint venture | 69,007 | 113,514 | |
Company's income recognized from joint venture | 192,659 | 248,295 |
The joint venture recorded an impairment of
Cost of sales of the joint venture includes certain costs incurred during the six months ended June 30, 2025, that were excluded from the inventory valuation in accordance with IAS 2 and classified within cost of sales for presentation purposes. These costs, amounting to
The company's share of profit from the Kamoa Holding joint venture was
Six months ended | |||
June 30, | |||
2025 | 2024 | ||
$'000 | $'000 | ||
Revenue from contract receivables | 1,791,257 | 1,426,313 | |
Remeasurement of contract receivables | 57,429 | 9,080 | |
Revenue | 1,848,686 | 1,435,393 | |
Cost of sales | (1,093,457) | (606,769) | |
Gross profit | 755,229 | 828,624 | |
General and administrative costs | (74,607) | (73,740) | |
Amortization of mineral property | (9,795) | (5,836) | |
Profit from operations | 670,827 | 749,048 | |
Finance costs | (112,229) | (144,859) | |
Foreign exchange loss | (16,741) | (20,988) | |
Finance income and other | 10,721 | 5,109 | |
Impairment | (68,202) | – | |
Profit before taxes | 484,376 | 588,310 | |
Current tax expense | (250,084) | (201,319) | |
Deferred tax recovery (expense) | 68,835 | (17,388) | |
Profit after taxes | 303,127 | 369,603 | |
Non-controlling interest of Kamoa Holding | (53,325) | (97,319) | |
Total comprehensive income for the period | 249,802 | 272,284 | |
Company's share of profit from joint venture ( | 123,652 | 134,781 |
The realized and provisional copper prices used for the remeasurement (mark-to-market) of contract receivables for the six months ended June 30, 2025, and for the same period in 2024, can be summarized as follows:
Six months ended | |||
June 30, | |||
2025 | 2024 | ||
$'000 | $'000 | ||
Realized during the period - open at the start of the period | |||
Opening forward price ($/lb.)(1) | 4.01 | 3.86 | |
Realized price ($/lb.)(1) | 4.14 | 3.78 | |
Payable copper tonnes sold | 79,985 | 35,966 | |
Remeasurement of contract receivables ($'000) | 21,811 | (6,040) | |
Realized during the period - new copper sold in the current period | |||
Provisional price ($/lb.)(1) | 4.25 | 3.96 | |
Realized price ($/lb.)(1) | 4.33 | 4.11 | |
Payable copper tonnes sold | 173,485 | 116,500 | |
Remeasurement of contract receivables ($'000) | 31,582 | 36,535 | |
Open at the end of the period - new copper sold in current period | |||
Provisional price ($/lb.)(1) | 4.45 | 4.47 | |
Closing forward price ($/lb.)(1) | 4.50 | 4.32 | |
Payable copper tonnes sold | 38,192 | 64,555 | |
Remeasurement of contract receivables ($'000) | 4,036 | (21,415) | |
Total remeasurement of contract receivables ($'000) | 57,429 | 9,080 |
(1) Calculated on a weighted average basis
The finance costs recognized in the Kamoa Holding joint venture for the six months ended June 30, 2025, can be broken down as follows.
Six months ended | |||
June 30, | |||
2025 | 2024 | ||
$'000 | $'000 | ||
Interest on shareholder loans | 139,338 | 229,257 | |
Interest on provisional and advance payment facilities | 75,334 | 47,772 | |
Interest on syndicated loans | 22,619 | – | |
Interest on bank loans and overdraft facilities | 14,748 | 5,069 | |
Rehabilitation unwinding | 3,012 | – | |
Lease liability unwinding | 3,434 | 3,605 | |
Interest on equipment financing facilities | 3,400 | 5,324 | |
Interest capitalized as borrowing costs | (149,656) | (146,168) | |
112,229 | 144,859 |
Ivanhoe's exploration and project evaluation expenditure amounted to
Finance income amounted to
The company sold 73,456 tonnes of payable zinc produced by the Kipushi Mine in the first half of 2025, realizing revenue of
Financial position as at June 30, 2025, vs. December 31, 2024
The company's total assets increased by
The company's investment in the Kamoa Holding joint venture increased by
June 30, | December 31, | ||
2025 | 2024 | ||
$'000 | $'000 | ||
Company's share of net assets in joint venture | 2,014,624 | 1,890,974 | |
Loan advanced to joint venture | 1,211,749 | 1,142,742 | |
Total investment in joint venture | 3,226,373 | 3,033,716 |
The company's share of the net assets in the Kamoa Holding joint venture can be broken down as follows:
June 30, 2025 | December 31, 2024 | ||||||||
$'000 | $'000 | $'000 | $'000 | ||||||
Assets | |||||||||
Property, plant and equipment | 6,557,941 | 3,246,181 | 6,122,292 | 3,030,535 | |||||
Mineral property | 753,423 | 372,944 | 763,217 | 377,792 | |||||
Indirect taxes receivable | 796,314 | 394,175 | 651,915 | 322,698 | |||||
Current inventory | 741,592 | 367,088 | 564,685 | 279,519 | |||||
Long-term loan receivable | 403,234 | 199,601 | 374,485 | 185,370 | |||||
Other receivables | 423,777 | 209,770 | 371,077 | 183,683 | |||||
Trade receivables | 323,164 | 159,966 | 280,795 | 138,993 | |||||
Cash and cash equivalents | 246,436 | 121,986 | 100,641 | 49,817 | |||||
Run of mine stockpile | 220,364 | 109,080 | 318,688 | 157,751 | |||||
Right-of-use asset | 29,761 | 14,732 | 51,764 | 25,623 | |||||
Deferred tax asset | 27,079 | 13,404 | 27,594 | 13,659 | |||||
Prepaid expenses | 14,409 | 7,132 | 17,377 | 8,602 | |||||
Non-current deposits | 1,872 | 927 | 1,872 | 927 | |||||
Liabilities | |||||||||
Shareholder loans | (2,448,322) | (1,211,919) | (2,308,984) | (1,142,947) | |||||
Trade and other payables | (688,277) | (340,697) | (700,803) | (346,896) | |||||
Advance payment facilities | (1,014,778) | (502,315) | (681,345) | (337,266) | |||||
Term loan facilities | (675,948) | (334,594) | (668,508) | (330,911) | |||||
Deferred tax liability | (276,622) | (136,928) | (323,546) | (160,155) | |||||
Overdraft facility | (215,672) | (106,758) | (232,475) | (115,075) | |||||
Rehabilitation provision | (151,383) | (74,935) | (123,668) | (61,216) | |||||
Provisional payment facilities | (99,710) | (49,356) | (78,993) | (39,102) | |||||
Other provisions | (64,335) | (31,846) | (58,279) | (28,848) | |||||
Lease liability | (44,337) | (21,947) | (52,093) | (25,786) | |||||
Income taxes payable | (129,922) | (64,311) | 9,227 | 4,567 | |||||
Dividends payable | (117,251) | (58,039) | – | – | |||||
Non-controlling interest | (542,863) | (268,717) | (606,788) | (300,360) | |||||
Net assets of the joint venture | 4,069,946 | 2,014,624 | 3,820,147 | 1,890,974 |
Before commencing commercial production in July 2021, the Kamoa Holding joint venture principally used loans from its shareholders to develop the Kamoa-Kakula Copper Complex through investing in development costs and other property, plant, and equipment. No additional shareholder loans were advanced from 2022 to date, with joint venture cashflow and joint venture-level facilities funding its operations and expansions.
Advance payment facilities represent financing arrangements linked to Kamoa-Kakula's offtake agreements with its customers. Each customer has provided advance payment facilities, which are repaid by offsetting amounts payable in terms of provisional invoices in accordance with the terms of each agreement. Kamoa-Kakula received
Overdraft facilities represent drawn unsecured financing facilities from DRC financial institutions at an attractive cost of capital, utilized to augment cash generated from operations for Kamoa-Kakula's continued expansion and working capital. Total current overdraft facilities amount to
The term loan facilities of the Kamoa Holding joint venture can be summarized as follows:
Description | Repayment terms | June 30, | December 31, | |
2025 | 2024 | |||
$'000 | $'000 | |||
Syndicated term facility | Repayable in eight equal quarterly installments starting from March 31, 2026 | 400,657 | 403,568 | |
Facility agreement | Full repayment on June 25, 2026 | 200,879 | 199,911 | |
Equipment financing facilities | Installments on each quarterly facility repayment date, with | 50,858 | 65,029 | |
Bank of Africa facility agreement | Repayable in 18 monthly installments starting June 21, 2025, with final payment due November 2026 | 23,555 | – | |
Total term loan facilities | 675,949 | 668,508 |
The repayments of the advanced payment facilities of the Kamoa Holding joint venture can be summarized as follows:
More than | ||||||||||
0-3 months | 3-6 months | 6-12 months | 12-24 months | 24 months | ||||||
$'000 | $'000 | $'000 | $'000 | $'000 | ||||||
As at June 30, 2025 | 260,000 | 160,000 | 177,000 | 354,000 | 63,300 |
The cash flows of the Kamoa Holding joint venture can be summarized as follows:
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | $'000 | $'000 | |||||
Net cash generated from operating activities before change in working capital items | 232,222 | 306,213 | 787,911 | 644,601 | ||||
Change in working capital items | 127,930 | 31,635 | (381,301) | (72,596) | ||||
Net cash used in investing activities | (265,307) | (567,476) | (563,769) | (1,099,063) | ||||
Net cash generated from financing activities | 77,926 | 379,428 | 320,674 | 809,893 | ||||
Effect of foreign exchange rates on cash | (3,926) | 4,611 | (917) | 2,784 | ||||
Net cash inflow | 168,845 | 154,411 | 162,598 | 285,619 | ||||
Cash and cash equivalents (1) - beginning of the period | (138,081) | 25,919 | (131,834) | (105,289) | ||||
Cash and cash equivalents (1) - end of the period | 30,764 | 180,330 | 30,764 | 180,330 |
(1) Cash and cash equivalents in the above table are shown net of overdraft facilities.
The Kamoa Holding joint venture's net increase in property, plant, and equipment from December 31, 2024, to June 30, 2025, amounted to
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | $'000 | $'000 | |||||
Kamoa Holding joint venture | ||||||||
Expansion capital | 192,892 | 481,628 | 399,894 | 929,307 | ||||
Sustaining capital | 81,501 | 59,218 | 171,275 | 129,019 | ||||
274,393 | 540,846 | 571,169 | 1,058,326 | |||||
Depreciation capitalized | 16,752 | 13,283 | 30,465 | 26,393 | ||||
Total capital expenditure | 291,145 | 554,129 | 601,634 | 1,084,719 | ||||
Borrowing costs capitalized | 75,463 | 80,542 | 149,655 | 146,168 | ||||
Total additions to property, plant, and equipment for Kamoa Holding | 366,608 | 634,671 | 751,289 | 1,230,887 | ||||
Less depreciation, impairment, disposals, and foreign exchange translation | (186,665) | (87,700) | (315,640) | (166,599) | ||||
Net increase in property, plant, and equipment of Kamoa Holding | 179,943 | 546,971 | 435,649 | 1,064,288 |
Ivanhoe's cash and cash equivalents increased by
The net increase in property, plant, and equipment amounted to
The main components of the additions to property, plant and equipment - including capitalized development costs - at the Platreef Project and Kipushi Mine for the six months ended June 30, 2025, and for the same period in 2024, are set out in the following tables:
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | $'000 | $'000 | |||||
Platreef Project | ||||||||
Phase 2 construction | 26,554 | 46,258 | 48,376 | 71,030 | ||||
Phase 1 construction | 3,133 | 4,033 | 6,186 | 18,887 | ||||
Salaries and benefits | 9,338 | 4,852 | 18,522 | 9,021 | ||||
Administrative and other expenditure | 2,384 | 2,789 | 7,322 | 4,956 | ||||
Depreciation | 2,655 | 2,212 | 5,024 | 4,144 | ||||
Social and environmental | 882 | 995 | 1,908 | 1,229 | ||||
Site costs | 12,117 | 1,353 | 22,564 | 2,253 | ||||
Studies and contracting work | 2,541 | 802 | 3,217 | 1,623 | ||||
Total development costs | 59,604 | 63,294 | 113,119 | 113,143 | ||||
Other additions to property, plant, and equipment | 903 | 3,580 | 935 | 7,201 | ||||
Total additions to property, plant, and equipment for Platreef | 60,507 | 66,874 | 114,054 | 120,344 |
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | $'000 | $'000 | |||||
Kipushi Mine | ||||||||
Initial and expansion capital | 15,121 | 77,087 | 22,589 | 147,046 | ||||
Sustaining capital | 13,782 | - | 26,103 | – | ||||
28,903 | 77,087 | 48,692 | 147,046 | |||||
Depreciation capitalized | – | 1,549 | – | 3,225 | ||||
Total capital expenditure | 28,903 | 78,636 | 48,692 | 150,271 | ||||
Total additions to property, plant, and equipment | 28,903 | 78,636 | 48,692 | 150,271 |
The company's total liabilities increased by
On January 23, 2025, the company issued debt securities with an aggregate principal of
Transaction costs of
The company's borrowings increased by
LIQUIDITY AND CAPITAL RESOURCES
The company had
The company's capital expenditure can be summarized as follows:
Capital Expenditure | H1 2025 Actuals | 2025 Guidance | 2026 Guidance | |||
($' million) | ($' million) | ($' million) | ||||
Kamoa-Kakula | ||||||
Phase 3 and other expansion capital | 400 | 950 – 1,050 | ||||
Sustaining capital | 171 | 470 – 550 | ||||
571 | 1,420 – | 700 - 1,200 | ||||
Platreef | ||||||
Phase 1 initial capital | 25 | 70 | – | |||
Phase 2 capital | 84 | 180 – 210 | 350 - 380 | |||
109 | 250 – 280 | 350 - 380 | ||||
Kipushi | ||||||
Initial and expansion capital | 23 | 30 | – | |||
Sustaining capital | 26 | 40 | 35 | |||
49 | 70 | 35 |
Figures in the above table are presented on a
The capital expenditure guidance range for 2026, for Kamoa-Kakula, as issued on February 19, 2025, has been widened from between
Construction of Platreef's Phase 1 concentrator was completed on schedule in Q3 2024 and is currently on care and maintenance until Q4 2025, as Shaft #1 prioritizes the hoisting of waste from the development required to bring forward the start of Phase 2. First production of Phase 1 is expected in Q4 2025, with the Phase 2 expansion accelerated to 2027.
Ivanhoe's exploration budget for 2025 has been set to approximately
PRO-RATA FINANCIAL RATIOS
The following pro-rata financial ratios have been calculated by aggregating the contributions of the company with the contributions from the Kamoa-Kakula joint venture, pro-rata to the company's effective shareholding in the Kamoa-Kakula joint venture.
(in millions of $, except ratios) | June 30, | December 31, | ||
2025 | 2024 | |||
Pro-rata total debt | 1,951.7 | 1,016.3 | ||
Pro-rata cash | 773.5 | 163.5 | ||
Pro-rata net debt | 1,178.2 | 852.8 | ||
Pro-rata net debt to Adjusted EBITDA (1) | 1.83x | 1.36x |
(1) Pro-rata net debt to Adjusted EBITDA ratio is a non-GAAP financial measure. Pro-rata net debt to Adjusted EBITDA ratio is pro-rata net debt divided by Adjusted EBITDA for the twelve months ended at the reporting period, expressed as the number of times Adjusted EBITDA needs to be earned to repay the pro-rata net debt.
The company's pro-rata total debt is summarized as follows:
June 30, | December 31, | ||
2025 | 2024 | ||
$'millions | $'millions | ||
Consolidated indebtedness of the company: | |||
Senior notes | 757.0 | – | |
Senior debt facility | 93.2 | 63.4 | |
Advance payment facilities | 121.0 | 120.0 | |
Other borrowings | 186.0 | 175.0 | |
1,157.2 | 358.4 | ||
Pro-rata indebtedness of Kamoa Holding joint venture | |||
Term loan facilities | 267.7 | 264.7 | |
Advance payment facilities | 401.9 | 269.8 | |
Provisional payment facilities | 39.5 | 31.3 | |
Overdraft facilities | 85.4 | 92.1 | |
794.5 | 657.9 | ||
Pro-rata total debt | 1,951.7 | 1,016.3 |
The pro-rata cash and cash equivalents of the company are summarized as follows:
June 30, | December 31, | |||
2025 | 2024 | |||
$'millions | $'millions | |||
Consolidated cash and cash equivalents of the Company | 671.7 | 117.3 | ||
Pro-rata cash and cash equivalents of Kamoa Holding joint venture | 101.8 | 46.2 | ||
Pro-rata cash and cash equivalents | 773.5 | 163.5 |
The pro-rata net debt of the company is summarized as follows:
June 30, | December 31, | |||
2025 | 2024 | |||
$'millions | $'millions | |||
Pro-rata total debt | 1,951.7 | 1,016.3 | ||
Pro-rata cash and cash equivalents | 773.5 | 163.5 | ||
Pro-rata net debt | 1,178.2 | 852.8 |
The Adjusted EBITDA of the company for the twelve months ended June 30, 2025, is summarized as follows:
Twelve months ended | ||||||||||
June 30, | ||||||||||
2025 | Q2 2025 | Q1 2025 | Q4 2024 | Q3 2024 | ||||||
$'millions | $'millions | $'millions | $'millions | $'millions | ||||||
Profit after taxes | 353.7 | 35.3 | 122.2 | 88.0 | 108.2 | |||||
Finance income | (201.4) | (43.6) | (41.6) | (56.0) | (60.2) | |||||
Current and deferred tax | (23.0) | (7.2) | (4.0) | (12.4) | 0.6 | |||||
Finance costs | 20.0 | 4.9 | 7.8 | 6.8 | 0.5 | |||||
Unrealized foreign exchange loss (gain) | 2.9 | 0.7 | 0.7 | 2.8 | (1.3) | |||||
Depreciation | 35.7 | 11.3 | 11.9 | 11.5 | 1.0 | |||||
Amortization of mineral property | 12.9 | 5.2 | 2.3 | 5.4 | – | |||||
EBITDA | 200.8 | 6.6 | 99.3 | 46.1 | 48.8 | |||||
Share of profit from joint venture net of tax | (280.7) | (15.7) | (107.9) | (73.6) | (83.5) | |||||
Company's share of EBITDA from Kamoa-Kakula joint venture (1) | 702.7 | 127.8 | 231.3 | 158.9 | 184.7 | |||||
Non-cash share-based payments | 18.4 | 4.6 | 3.7 | 4.3 | 5.8 | |||||
Loss on fair valuation of embedded derivative liability | 4.2 | – | – | – | 4.2 | |||||
Adjusted EBITDA | 645.4 | 123.3 | 226.4 | 135.7 | 160.0 |
SUMMARY OF DEBT FACILITIES
On January 23, 2025, the company issued debt securities with an aggregate principal of
On or after January 23, 2027, the company has the right to redeem all or part of the Senior Notes at the following redemption prices, expressed as a percentage of the principal amount, plus any unpaid accrued interest.
Redemption price | ||||||
Period of 12 months from January 23, 2027 | ||||||
Period of 12 months from January 23, 2028 | ||||||
Period of 12 months from January 23, 2029 |
On December 10, 2024, Kipushi entered into a
On October 25, 2024, Ivanhoe Marketing and RMB entered into a
During the second quarter of 2024, Kipushi entered into a
On December 22, 2023, Ivanplats entered into a common terms and senior secured facility agreement between, amongst others, Société Générale and Nedbank Limited (acting through its Nedbank Corporate and Investment Banking Division) (Nedbank) as lenders; Ivanplats as borrower; Ivanplats Holding S.À.R.L, ITC, and Ivanhoe Mines SA (Pty) Ltd. as guarantors; Ivanhoe Mines Ltd. as sponsor; and Nedbank Limited as global facility agent (as amended and amended and restated from time to time, the Platreef Senior Debt Financing Agreement). Under the Platreef Senior Debt Financing Agreement, the lenders thereunder make available to Ivanplats a senior secured facility in an aggregate principal amount of up to
On August 4, 2023, the company entered into an
The company has a mortgage bond outstanding on its offices in London, United Kingdom, of £3.2 million (
In 2013, the company became a party to a loan payable to ITC Platinum Development Limited, which had a carrying value and contractual value of
The company has an implied commitment in terms of spending on work programs submitted to regulatory bodies to maintain the good standing of exploration and exploitation permits at its mineral properties. The following table sets forth the company's long-term obligations:
Contractual obligations as at June 30, 2025 | Payments Due By Period | |||||||||
Total | Less than 1 year | 1-3 years | 4-5 years | After 5 years | ||||||
$'000 | $'000 | $'000 | $'000 | $'000 | ||||||
Debt | 1,541,346 | 216,063 | 308,965 | 980,006 | 36,312 | |||||
Lease commitments | 863 | 417 | 446 | – | – | |||||
Total contractual obligations | 1,542,209 | 216,480 | 309,411 | 980,006 | 36,312 |
Debt in the above table represents the senior notes, the senior debt facility, the advance payment facilities, the RMB loan facilities, mortgage bond owing to Citibank, the loan payable to ITC Platinum Development Limited, the loan from FirstBank, the aircraft loan as described above.
NON-GAAP FINANCIAL PERFORMANCE MEASURES
Cash cost (C1) per pound is a non-GAAP financial measure. These are disclosed to enable investors to better understand the performance of Kamoa-Kakula and Kipushi in comparison to other copper and zinc producers, respectively, who present results on a similar basis.
Cash cost (C1) is prepared on a basis consistent with the industry standard definitions by Wood Mackenzie cost guidelines, but is not measures recognized under IFRS Accounting Standards. In calculating the C1 cash cost for Kamoa-Kakula, the costs are measured on the same basis as the company's share of profit from the Kamoa Holding joint venture that is contained in the financial statements. C1 cash cost is used by management to evaluate operating performance and includes all direct mining, processing, and general and administrative costs. Smelter charges and freight deductions on sales to the final port of destination, which are recognized as a component of sales revenues, are added to C1 cash cost to arrive at an approximate cost of finished metal. C1 cash cost and C1 cash cost per pound exclude royalties, production taxes, and non-routine charges as they are not direct production costs.
Reconciliation of Kamoa-Kakula's cost of sales to C1 cash cost, including on a per pound basis:
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | $'000 | $'000 | |||||
Cost of sales | 640,194 | 324,428 | 1,093,457 | 606,769 | ||||
General and administrative expenditure | 39,230 | 26,713 | 73,751 | 73,740 | ||||
Logistics, treatment, and refining charges | 101,838 | 119,603 | 212,228 | 224,515 | ||||
Depreciation | (141,390) | (77,230) | (245,009) | (136,742) | ||||
Costs classified as abnormal due to seismic activity | (90,064) | – | (90,064) | – | ||||
General and administrative expenditures of other group entities | (4,004) | (580) | (4,690) | (2,121) | ||||
Royalties and production taxes | (71,309) | (65,070) | (137,553) | (121,470) | ||||
Non-cash adjustments to inventory | (18,268) | 5,794 | 42,715 | 4,397 | ||||
Power rebate | (3,356) | (4,487) | (7,125) | (8,955) | ||||
Extraordinary taxes | (514) | (722) | (960) | (21,857) | ||||
C1 cash costs | 452,357 | 328,449 | 936,750 | 618,276 | ||||
Cost of sales per pound of payable copper sold ($ per lb.) | 2.85 | 1.53 | 2.34 | 1.52 | ||||
C1 cash costs per pound of payable copper produced ($ per lb.) | 1.89 | 1.52 | 1.78 | 1.54 | ||||
Payable copper produced in concentrate (tonnes) | 108,867 | 98,213 | 238,598 | 182,158 |
Figures in the above table are for the Kamoa-Kakula joint venture on a
Reconciliation of Kipushi's cost of sales to C1 cash cost, including on a per-pound basis:
Three months ended | Six months ended | ||||||||
June 30, | June 30, | ||||||||
2025 | 2024 | 2025 | 2024 | ||||||
$'000 | $'000 | $'000 | $'000 | ||||||
Cost of sales | 100,217 | – | 181,988 | – | |||||
Logistics and treatment charges | 18,716 | – | 22,638 | – | |||||
General and administrative expenditure | 386 | – | 434 | – | |||||
Royalties and production taxes | (10,801) | – | (20,654) | – | |||||
Depreciation and amortization | (15,518) | – | (29,095) | – | |||||
General and administrative expenditures of other group entities | (1,477) | – | (2,321) | – | |||||
C1 cash costs | 91,523 | – | 152,990 | – | |||||
Cost of sales per pound of payable zinc sold ($ per lb.) | 1.05 | – | 1.12 | – | |||||
C1 cash costs per pound of payable zinc sold ($ per lb.) | 0.96 | – | 0.94 | – | |||||
Payable zinc sold in concentrate (tonnes) | 43,348 | – | 73,456 | – |
EBITDA, Adjusted EBITDA, and EBITDA margin, normalized profit after tax, and normalized profit per share
EBITDA and Adjusted EBITDA are non-GAAP financial measures. Ivanhoe believes that Kamoa-Kakula's EBITDA and Kipushi's EBITDA are valuable indicators of each mine's respective ability to generate liquidity by producing operating cash flow to fund its working capital needs, service debt obligations, fund capital expenditures, and distribute cash to its shareholders. EBITDA and Adjusted EBITDA are also frequently used by investors and analysts for valuation purposes. Kamoa-Kakula's EBITDA, Kipushi's EBITDA, and the EBITDA and Adjusted EBITDA for the company are intended to provide additional information to investors and analysts and do not have any standardized definition under IFRS Accounting Standards and should not be considered in isolation or as a substitute for measures of performance prepared per IFRS Accounting Standards. EBITDA and Adjusted EBITDA exclude the impact of cash cost of financing activities and taxes, and the effects of changes in operating working capital balances and impairments, and therefore are not necessarily indicative of operating profit or cash flow from operations as determined under IFRS Accounting Standards. Other companies may calculate EBITDA and Adjusted EBITDA differently.
The EBITDA margin is an indicator of Kamoa-Kakula's and Kipushi's respective overall health and denotes their respective profitability, which is calculated by dividing EBITDA by revenue. The EBITDA margin is intended to provide additional information to investors and analysts, does not have any standardized definition under IFRS Accounting Standards, and should not be considered in isolation or as a substitute for measures of performance prepared per IFRS Accounting Standards.
Reconciliation of profit after tax to Kamoa-Kakula's EBITDA and Adjusted EBITDA:
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | $'000 | $'000 | |||||
Profit after taxes | 36,707 | 236,443 | 303,127 | 369,603 | ||||
Depreciation | 146,189 | 80,302 | 254,804 | 142,578 | ||||
Impairment (1) | 59,025 | – | 68,202 | – | ||||
Current and deferred tax expense | 31,083 | 144,076 | 181,249 | 218,707 | ||||
Finance costs | 52,873 | 71,143 | 112,229 | 144,859 | ||||
Unrealized foreign exchange loss | 4,697 | 15,571 | 10,406 | 19,638 | ||||
Other taxes | 514 | 722 | 960 | 21,857 | ||||
Finance income | (5,907) | (1,000) | (11,459) | (5,092) | ||||
EBITDA | 325,181 | 547,257 | 919,518 | 912,150 |
(1) The impairment recognized for the six months ended June 30, 2025 comprises of
Figures in the above table are for the Kamoa-Kakula joint venture on a
Reconciliation of loss after tax to Kipushi's EBITDA:
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | $'000 | $'000 | |||||
Segmented loss after taxes | (6,131) | (2,229) | (11,214) | (1,141) | ||||
Depreciation and amortization | 15,519 | – | 29,095 | – | ||||
Finance costs | 8,047 | – | 14,467 | – | ||||
Current and deferred tax expense | (7,865) | 1,939 | (12,165) | 424 | ||||
Finance income | (592) | (611) | (1,204) | (1,205) | ||||
Unrealized foreign exchange loss | 317 | 425 | 824 | 1,414 | ||||
EBITDA | 9,295 | (476) | 19,803 | (508) |
Reconciliation of profit after tax to Ivanhoe's EBITDA and adjusted EBITDA:
Three months ended | Six months ended | |||||||
June 30, | June 30, | |||||||
2025 | 2024 | 2025 | 2024 | |||||
$'000 | $'000 | |||||||
Profit (loss) after taxes | 35,325 | 66,516 | 157,525 | (2,894) | ||||
Finance income | (43,583) | (62,873) | (85,206) | (125,330) | ||||
Depreciation | 11,282 | 688 | 23,210 | 1,446 | ||||
Amortization of mineral property | 5,233 | – | 7,539 | – | ||||
Current and deferred tax (recovery) expense | (7,229) | 782 | (11,182) | (2,377) | ||||
Finance costs | 4,947 | 32,871 | 12,785 | 41,815 | ||||
Unrealized foreign exchange loss | 661 | 2,257 | 1,325 | 8,372 | ||||
EBITDA | 6,636 | 40,241 | 105,996 | (78,968) | ||||
Share of profit from joint venture net of tax | (15,704) | (89,616) | (123,652) | (134,781) | ||||
Company's share of EBITDA from Kamoa-Kakula joint venture(1) | 127,839 | 224,113 | 362,750 | 368,277 | ||||
Non-cash share-based payments | 4,553 | 7,459 | 8,220 | 14,799 | ||||
Loss on fair valuation of embedded derivative liability | – | 20,727 | – | 159,998 | ||||
Adjusted EBITDA | 123,324 | 202,924 | 353,314 | 329,325 |
The company's attributable share of adjusted EBITDA from the Kamoa-Kakula joint venture is calculated using the company's effective shareholding in Kamoa Copper SA (
DISCLOSURE OF TECHNICAL INFORMATION
Disclosures of a scientific or technical nature at the Kamoa-Kakula Copper Complex, the Platreef Mine and the Kipushi Mine, other than stockpiles, in this press release have been reviewed and approved by Steve Amos, who is considered, by virtue of his education, experience, and professional association, a Qualified Person under the terms of NI 43-101. Mr. Amos is not considered independent under NI 43-101 as he is Ivanhoe Mines' Executive Vice President, Projects. Mr. Amos has verified the technical data disclosed in this press release.
Disclosures of a scientific or technical nature regarding the stockpiles in this press release have been reviewed and approved by Joshua Chitambala, who is considered, by virtue of his education, experience, and professional association, a Qualified Person under the terms of NI 43-101. Mr. Chitambala is not considered independent under NI 43-101 as he is the Resource Manager for Ivanhoe Mines. Mr. Chitambala has verified the other technical data regarding the surface stockpiles disclosed in this press release.
Disclosures of a scientific or technical nature regarding the Western Forelands Exploration Project in this press release have been reviewed and approved by Tim Williams, who is considered, by virtue of his education, experience, and professional association, a Qualified Person under the terms of NI 43-101. Mr. Williams is not considered independent under NI 43-101 as he is the Vice President, Geosciences, at Ivanhoe Mines. Mr. Williams has verified the technical data regarding the Western Forelands Exploration Project disclosed in this press release.
Ivanhoe has prepared an independent, NI 43-101-compliant technical report for the Kamoa-Kakula Copper Complex, the Platreef Mine, and the Kipushi Mine, each of which is available on the company's website and under the company's SEDAR+ profile at www.sedarplus.ca
- Kamoa-Kakula Integrated Development Plan 2023 Technical Report, filed on March 16, 2023, prepared by OreWin Pty Ltd., China Nerin Engineering Co. Ltd., DRA Global, Epoch Resources, Golder Associates Africa, Metso Outotec Oyj, Paterson and Cooke, SRK Consulting Ltd., and The MSA Group.
- The Kipushi 2022 Feasibility Study, filed on March 4, 2022, prepared by OreWin Pty Ltd., MSA Group (Pty) Ltd., SRK Consulting (South Africa) (Pty) Ltd, and METC Engineering.
- The Platreef Integrated Development Plan 2025, filed on March 31, 2025, prepared by OreWin Pty Ltd., Mine Technical Services, SRK Consulting Inc., DRA Projects (Pty) Ltd, and Golder Associates Africa.
These technical reports include relevant information regarding the effective dates and the assumptions, parameters, and methods of the mineral resource estimates on the Platreef Project, the Kipushi Mine, and the Kamoa-Kakula Copper Complex cited in this press release, as well as information regarding data verification, exploration procedures, and other matters relevant to the scientific and technical disclosure contained in this press release in respect of the Platreef Project, Kipushi Mine, and Kamoa-Kakula Copper Complex.
Information contact
Follow Robert Friedland (@robert_ivanhoe) and Ivanhoe Mines (@IvanhoeMines_) on Twitter.
Investors
Vancouver: Matthew Keevil +1 604 558 1034
London: Tommy Horton +44 7866 913 207
Media
Tanya Todd +1 604 331 9834
Website www.ivanhoemines.com
Forward-looking statements
Certain statements in this news release constitute "forward-looking statements" or "forward-looking information" within the meaning of applicable securities laws. Such statements and information involve known and unknown risks, uncertainties, and other factors that may cause the actual results, performance, or achievements of the company, its projects, or industry results, to be materially different from any future results, performance, or achievements expressed or implied by such forward-looking statements or information. Such statements can be identified using words such as "may", "would", "could", "will", "intend", "expect", "believe", "plan", "anticipate", "estimate", "scheduled", "forecast", "predict" and other similar terminology, or state that certain actions, events, or results "may", "could", "would", "might" or "will" be taken, occur or be achieved. These statements reflect the company's current expectations regarding future events, performance, and results and speak only as of the date of this release.
Such statements include, without limitation: (i) statements that Kamoa-Kakula's 500,000-tonne-per-annum on-site, direct-to-blister copper smelter, the largest in Africa, is expected to start up in September and that all concentrates produced by Phase 1, 2, and 3 concentrators are expected to be treated by the on-site smelter; (ii) statements that Kamoa-Kakula's 60 MW, on-site solar facility with battery storage is expected to be operational in mid-2026 and that once operational, the solar plant can provide up to one-third of Kamoa-Kakula's power requirements; (iii) statements that pre-commissioning activities at the refurbished Turbine #5 at the Inga II hydroelectric facility are expected to be completed early in the fourth quarter; (iv) statements that the production rate at Kipush in H2 2025 is expected to significantly improve following improved availability of the DMS circuit and the imminent completion of the debottlenecking program; (v) statements that first production from Phase 2 at Platreef is expected in Q4 2027 and that the expansion is expected to produce over 460,000 ounces of platinum, palladium, rhodium, and gold per annum, plus approx. 9,000 tonnes of nickel and 6,000 tonnes of copper; (vi) statements that the Platreef Mine is projected to be the lowest-cost primary platinum-group-metals producer globally, and that the Phase 2 life-of-mine total cash cost is estimated to be
Also, all of the results of the 4.1 Mtpa FS, the 10.7 Mtpa PEA, the Kamoa-Kakula 2023 IDP, the Platreef 2022 feasibility study, and the Kipushi 2022 feasibility study constitute forward-looking statements or information and include future estimates of internal rates of return, net present value, future production, estimates of cash cost, proposed mining plans and methods, mine life estimates, cash flow forecasts, metal recoveries, estimates of capital and operating costs and the size and timing of phased development of the projects.
Furthermore, concerning this specific forward-looking information concerning the operation and development of the Kamoa-Kakula Copper Complex, Platreef Project and Kipushi Mine, and the exploration of the Western Forelands Exploration Project, the Mokopane Feeder Exploration Project and the Chu-Sarya Basin Exploration JV, the company has based its assumptions and analysis on certain factors that are inherently uncertain. Uncertainties include: (i) the adequacy of infrastructure; (ii) geological characteristics; (iii) metallurgical characteristics of the mineralization; (iv) the ability to develop adequate processing capacity; (v) the price of copper, nickel, zinc, platinum, palladium, rhodium and gold; (vi) the availability of equipment and facilities necessary to complete development and exploration; (vii) the cost of consumables and mining and processing equipment; (viii) unforeseen technological and engineering problems; (ix) accidents or acts of sabotage or terrorism; (x) currency fluctuations; (xi) changes in regulations; (xii) the compliance by joint venture partners with terms of agreements; (xiii) the availability and productivity of skilled labour; (xiv) the regulation of the mining industry by various governmental agencies; (xv) the ability to raise sufficient capital to develop such projects; (xvi) changes in project scope or design; (xvii) recoveries, mining rates and grade; (xviii) political factors; (xviii) water inflow into the mine and its potential effect on mining operations; and (xix) the consistency and availability of electric power.
This release also contains references to estimates of Mineral Resources. The estimation of Mineral Resources is inherently uncertain and involves subjective judgments about many relevant factors. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability. The accuracy of any such estimates is a function of the quantity and quality of available data and of the assumptions made and judgments used in engineering and geological interpretation (including estimated future production from the company's projects, the anticipated tonnages and grades that will be mined and the estimated level of recovery that will be realized), which may prove to be unreliable and depend, to a certain extent, upon the analysis of drilling results and statistical inferences that ultimately may prove to be inaccurate. Mineral Resource estimates may have to be re-estimated based on: (i) fluctuations in copper, nickel, zinc, platinum group elements (PGE), gold or other mineral prices; (ii) results of drilling; (iii) metallurgical testing and other studies; (iv) proposed mining operations, including dilution; (v) the evaluation of mine plans after the date of any estimates and/or changes in mine plans; (vi) the possible failure to receive required permits, approvals and licences; and (vii) changes in law or regulation.
Forward-looking statements and information involve significant risks and uncertainties, should not be read as guarantees of future performance or results, and will not necessarily be accurate indicators of whether such results will be achieved. Many factors could cause actual results to differ materially from the results discussed in the forward-looking statements or information, including, however not limited to, the factors discussed above and under the "Risk Factors" heading in the company's MD&A for the three and six months ended June 30, 2025, in the company's current annual information form, and elsewhere in this release, as well as unexpected changes in laws, rules or regulations, or their enforcement by applicable authorities; the failure of parties to contracts with the company to perform as agreed; social or labour unrest; changes in commodity prices; and the failure of exploration programs or studies to deliver anticipated results or results that would justify and support continued exploration, studies, development or operations.
Although the forward-looking statements contained in this release are based upon what management of the company believes are reasonable assumptions, the company cannot assure investors that actual results will be consistent with these forward-looking statements. These forward-looking statements are made as of the date of this release and are expressly qualified in their entirety by this cautionary statement. Subject to applicable securities laws, the company does not assume any obligation to update or revise the forward-looking statements contained herein to reflect events or circumstances occurring after the date of this release.
The company's actual results could differ materially from those anticipated in these forward-looking statements as a result of the factors outlined in the "Risk Factors" section in the company's MD&A for the three and six months ended June 30, 2025, in the company's current annual information and elsewhere in this release.
ADDITIONAL INFORMATION
Additional information regarding the company, including the company's Annual Information Form, is available on SEDAR+ at www.sedarplus.ca.
To view the source version of this press release, please visit https://www.newsfilecorp.com/release/260694
