Copper Fox Provides Execution Plan for PFS on Van Dyke ISCR Project
Copper Fox Metals (OTCQX: CPFXF) has announced the completion of a Project Execution Plan for a Prefeasibility Study (PFS) on its 100% owned Van Dyke in-situ copper recovery project in Arizona. The plan, prepared by Stantec Consultants, outlines a comprehensive three-year study estimated at US$23.4M, including a 10% contingency.
The execution plan includes a two-phase drilling program of 12,620 meters focused on expanding and upgrading resource categories. The study will encompass detailed metallurgical testing, hydrogeological analysis, and updated resource estimates. The company's previous PEA indicated that each US$0.25/lb increase in copper price could increase the project's after-tax NPV by approximately US$90 million.
A final decision to proceed with the PFS is expected before the end of October 2025.
Copper Fox Metals (OTCQX: CPFXF) ha annunciato il completamento di un Piano di Esecuzione del Progetto per uno Studio di Prefattibilità (PFS) sul suo progetto di recupero in sito del rame Van Dyke, di proprietà al 100% in Arizona. Il piano, redatto da Stantec Consultants, delinea uno studio triennale completo stimato in 23,4 milioni di dollari USA, comprensivo di una contingenza del 10%.
Il piano esecutivo prevede un programma di perforazione in due fasi per 12.620 metri volto ad espandere e aggiornare le categorie di risorse. Lo studio includerà test metallurgici dettagliati, analisi idrogeologiche e stime aggiornate delle risorse. Il precedente PEA della società indicava che un aumento del prezzo del rame di 0,25 USD/libbra potrebbe incrementare il VAN after-tax del progetto di circa 90 milioni di dollari.
La decisione finale di avviare il PFS è prevista prima della fine di ottobre 2025.
Copper Fox Metals (OTCQX: CPFXF) ha anunciado la finalización de un Plan de Ejecución del Proyecto para un Estudio de Prefactibilidad (PFS) sobre su proyecto de recuperación in situ de cobre Van Dyke, 100% de su propiedad en Arizona. El plan, preparado por Stantec Consultants, describe un estudio integral de tres años estimado en 23,4 MUSD, incluyendo una contingencia del 10%.
El plan de ejecución incluye un programa de perforación en dos fases de 12.620 metros centrado en ampliar y reclasificar las categorías de recursos. El estudio abarcará pruebas metalúrgicas detalladas, análisis hidrogeológicos y estimaciones actualizadas de recursos. El anterior PEA de la compañía indicaba que cada aumento de 0,25 USD/libra en el precio del cobre podría aumentar el VAN después de impuestos del proyecto en aproximadamente 90 millones de dólares.
Se espera una decisión final para proceder con el PFS antes de finales de octubre de 2025.
Copper Fox Metals (OTCQX: CPFXF)는 애리조나에 위치한 자사 100% 소유의 Van Dyke 인사이트(현장) 구리 회수 프로젝트에 대한 타당성사전조사(PFS) 실행계획서를 완료했다고 발표했습니다. Stantec Consultants가 작성한 이 계획서는 10%의 예비비를 포함한 미화 2,340만 달러 규모의 3년간 종합 연구를 제시합니다.
실행계획에는 자원 범주를 확대·상향 조정하기 위한 12,620미터의 2단계 시추 프로그램이 포함되어 있습니다. 연구에는 상세한 야금학 시험, 수문지질 분석 및 갱신된 자원 추정이 포함됩니다. 회사의 이전 PEA에 따르면 구리 가격이 파운드당 0.25달러 오를 때마다 프로젝트의 세후 NPV가 약 9,000만 달러 증가할 수 있다고 합니다.
PFS를 진행할지에 대한 최종 결정은 2025년 10월 말 이전에 내려질 예정입니다.
Copper Fox Metals (OTCQX: CPFXF) a annoncé l'achèvement d'un Plan d'Exécution de Projet pour une Étude de Préfaisabilité (PFS) concernant son projet de récupération in-situ du cuivre Van Dyke, détenu à 100% en Arizona. Le plan, préparé par Stantec Consultants, décrit une étude globale sur trois ans estimée à 23,4 M$ US, incluant une provision de 10 %.
Le plan d'exécution comprend un programme de forage en deux phases de 12 620 mètres visant à étendre et reclasser les catégories de ressources. L'étude comprendra des essais métallurgiques détaillés, des analyses hydrogéologiques et des estimations de ressources actualisées. L'EPF précédent de la société indiquait que chaque hausse de 0,25 $/lb du prix du cuivre pourrait augmenter la VAN après impôts du projet d'environ 90 M$.
La décision finale de lancer la PFS est attendue avant la fin d'octobre 2025.
Copper Fox Metals (OTCQX: CPFXF) hat den Abschluss eines Projekt-Ausführungsplans für eine Vor-Finanzierungsstudie (PFS) zu seinem 100%igen Van Dyke In-situ-Kupfergewinnungsprojekt in Arizona bekanntgegeben. Der von Stantec Consultants erstellte Plan skizziert eine umfassende dreijährige Studie mit geschätzten Kosten von 23,4 Mio. USD, einschließlich einer 10%igen Reserve.
Der Ausführungsplan sieht ein zweiphasiges Bohrprogramm über 12.620 Meter vor, mit dem die Ressourcenkategorien erweitert und hochgestuft werden sollen. Die Studie wird detaillierte metallurgische Tests, hydrogeologische Analysen und aktualisierte Ressourcenschätzungen umfassen. Die vorherige PEA des Unternehmens wies darauf hin, dass ein Anstieg des Kupferpreises um 0,25 USD/lb das nachsteuerliche NPV des Projekts um etwa 90 Mio. USD erhöhen könnte.
Eine endgültige Entscheidung zum Fortgang der PFS wird voraussichtlich vor Ende Oktober 2025 getroffen.
- None.
- High capital requirement of US$23.4M for PFS completion
- Extended timeline of three years to complete the study
- Complex permitting requirements due to WQARF designation
- Success dependent on hydrogeological conditions and well interconnectivity
Calgary, Alberta--(Newsfile Corp. - September 5, 2025) - Copper Fox Metals Inc. (TSXV: CUU) (OTCQX: CPFXF) (FSE: HPU) ("Copper Fox" or the "Company") through its wholly owned subsidiary Desert Fox Van Dyke Co., is pleased to announce completion of the Project Execution Plan For Van Dyke Prefeasibility Study (the "Plan") prepared by Stantec Consultants Services Inc. ("Stantec") (see News Release dated June 23, 2025) on its
In 2020, Copper Fox completed an updated Mineral Resource Estimate (MRE) and Preliminary Economic Assessment (PEA) on Van Dyke using a US
- each US
$0.25 /lb increase in copper price increased the project's after-tax NPV by ~US$90 million (M), - significant exploration potential to increase the project's mineral resources, and
- recommendation to advance the project to PFS stage.
Highlights of the Plan
- Outlines plan for completion of a PFS level report on the Van Dyke project.
- Outlines the objectives, work programs and expected timelines for the main components of the study.
- A two-phase, multi-purpose drilling program (12,620 meter (m)) focused primarily on expanding and upgrading the resource categories within the Van Dyke copper deposit.
- Estimated three years completion time, subject to time required to complete metallurgical testwork.
- Estimated cost of ~ US
$23.4M including a10% (US$2.17M ) contingency.
Elmer B. Stewart, President and CEO of Copper Fox, stated, "Copper Fox thanks the team of mining professionals led by Stantec, a global leader in surface and underground mining engineering, design, and project delivery, for preparation of the Plan. The team's knowledge and work experience at two other advanced-stage ISCR projects in Arizona contributed to the development of a concise, focused plan, including a permitting strategy to achieve a PFS level study on the Van Dyke project. A decision to proceed to advance the project to the PFS stage is expected to be made before the end of October 2025."
A brief discussion of the main components of the Plan follows.
Project Management

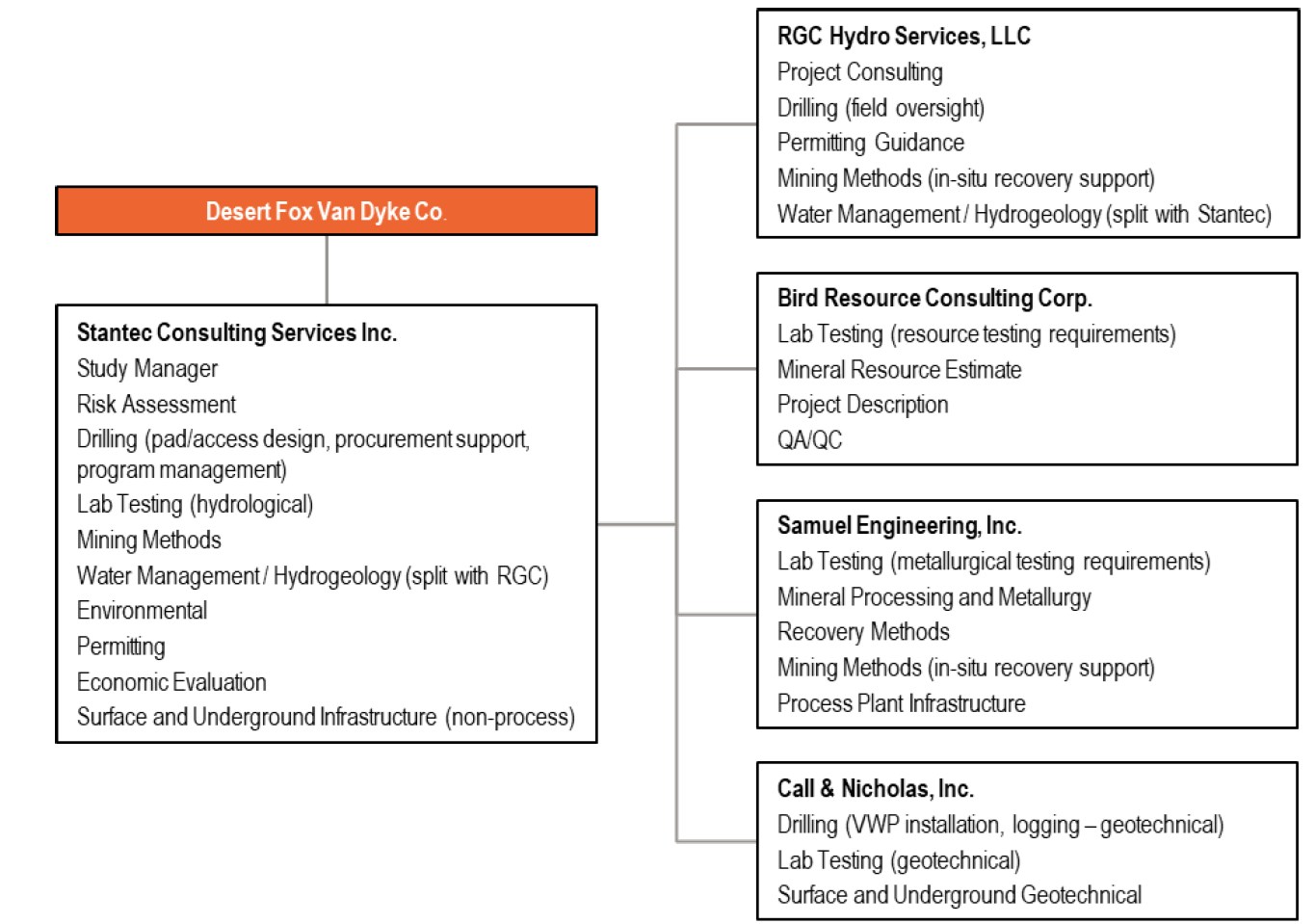

The consultants and responsibilities of the team preparing the Plan are outlined in Figure 1.
Figure 1 - Project Management for Van Dyke PFS Execution Plan
To view an enhanced version of this graphic, please visit:
https://images.newsfilecorp.com/files/2177/265204_163e727134891bf9_001full.jpg
Drilling
A two-phase drilling program is proposed focused on upgrading the mineral resource categories to meet the requirements of a PFS level study and allows for additional metallurgical and geotechnical sampling, and installation of hydrogeological monitoring and water quality sampling stations.
The program consists of 12,620m of reverse-circulation (RC) and diamond core (core) drilling in 25 locations. Phase I (estimated 6 months to complete) focuses primarily on resources and consists of 11,120m in 21 holes with Phase II consisting of 1,500m in 4 holes for additional hydrogeology monitoring wells, a deeper aquifer pump test well and two geotechnical core holes if required for portal selection. The timing between Phase I and Phase II depends on laboratory turnaround, particularly for metallurgical testwork plus time for analysis and interpretation.
Laboratory Testwork
The Plan outlines additional metallurgical, geotechnical, hydrogeological and water quality testwork to enable completion of prefeasibility studies and engineering works to support a PFS level of study.
Metallurgical testing includes sample characterization, mineralogy, locked-cycle and/or small pilot-scale leaching tests to evaluate/confirm optimum acid addition and consumption, leach cycle, and copper recovery; tracer tests to evaluate effluent conductivity over time (indicative of copper leaching progression in-situ); and pressurized rinse tests.
Geotechnical testwork includes core sampling to determine rock strength and elastic properties of the Gila Conglomerate, small-scale direct shear tests, Atterberg limits testing, and USCS particle size classification of bulk samples to characterize material properties.
The water quality monitoring wells and vibrating wire piezometers (VWPs) established during the drilling program allows for the collection of hydrogeological data, water level measurements, and sampling for ground water quality analysis in accordance with EPA and Arizona state requirements.
Updated Resource and Initial Reserve Estimates
The results of the proposed drilling program would be used to complete an updated MRE in accordance with National Instrument 43-101 - Standards of Disclosure for Mineral Projects incorporating updated geological, structural, mineral zonation and hydrogeological models, geotechnical data, and estimated copper recoveries by zone/material type. Provided that a PFS level of study is achieved, a reserve statement would be completed that quantifies mineralization with reasonable expectation of economic extraction.
Mine Plan
Additional geotechnical characterization of the site incorporating geotechnical and structure orientation data from the Gila Conglomerate to access the Van Dyke copper deposit is required. The mine plan would be scheduled to a PFS level and incorporate trade-off studies related to the portal type and site selection, mining methodology, mine design, ventilation, ground support design and an assessment to determine if the historical mine workings could be incorporated into the mine plan. The mine plan also includes lateral and vertical development distances, tonnages and rock volumes that follows a leaching schedule and the mobile equipment to support the life-of-mine (LOM) activities. The "Deswik" scheduling software would be used to create the mine plan and schedule for development and production activities.
ISCR
Understanding the hydrogeological conditions is a significant parameter in predicting future copper production in an ISCR operation. The mineralization in the Van Dyke deposit is hosted in oxidized and weathered Pinal Schist primarily in fractures with lesser concentrations occurring along schistosity surfaces and in quartz veinlets.
Copper recovery using ISCR techniques was historically successful on the Van Dyke property by Occidental Minerals Corp, following hydraulic fracturing of several injection and recovery test wells within a localized area near the Van Dyke shaft. Historic ISCR well spacings at Van Dyke ranged between 24m to 38m.
The injection and recovery wellfield would be designed using a distributed pattern of injection and recovery wells, typically consisting of one central injection well to four surrounding recovery wells, with calculated spacing between collars.
Hydrogeological data would be used to determine interconnectivity between the injection and recovery wells and establish conceptual operational layouts to assist with drilling and construction diameters required for operation of injection and recovery pump equipment in operational designs. Sweep efficiencies obtained from baseline hydrogeology testing would be used to determine the operational flows required to maintain interconnectivity between injection and recovery wells within the mineralized zone.
Reclamation of leach blocks would be achieved by injecting and recovering a fresh water solution to return the formation to pre-leaching water quality conditions or Aquifer Water Quality Standards (AWQS) as defined in an Aquifer Production Permit.
Mineral Processing and Recovery
Additional metallurgical testwork results, would be used to update the Conceptual Geometallurgical Model and develop prediction algorithms for copper recovery, product quality, operating cost, throughput rates to better inform deposit variability in terms of leach kinetics, acid consumption, and deleterious elements to allow evaluation of various processing options and optimization of short- and long-term operational performance.
The eight VWP locations and three water quality monitoring locations installed during the drilling program expands the hydrogeology and groundwater coverage to establish hydraulic gradients across the site and guide water management options to better characterize the hydrogeology of the Van Dyke deposit guide water management options and support permitting efforts. Groundwater monitoring wells would be designed to meet or exceed "Special Well Construction and Abandonment Procedures for Pinal Creek, Water Quality Assurance Revolving Fund Site" guidelines.
PFS Infrastructure Engineering
The infrastructure required for an ISCR operation includes the solvent extraction/electrowinning (SX/EW) plant, water treatment/neutralization, power distribution, surface infrastructure and all infrastructure associated with the underground wellfield. Base engineering criteria would include significant infrastructure areas (e.g., surface civil) to support a PFS level of study and lay the foundation for each major engineering discipline (civil, mechanical, electrical, instrumentation and controls, and structural) for future engineering studies/designs in compliance with applicable codes and standards. Prefeasibility and engineering studies include data analysis, modeling, trade-off evaluations, and engineering design to identify risk, explore potential options, and assess the viability of the project to optimized cost and schedule outcomes.
Economic Evaluation
The Plan included the use of "InEight" estimating software to an AACEI Class 4 prefeasibility level of detail with a -
The preparation of a market study that includes the sale of copper and aggregate based on product pricing, marketability, offtake or sales agreements, long-term view of the copper market and local supply/demand for aggregate is planned.
The preparation of a financial model and sensitivity analysis following industry standards includes pre- and after-tax calculations, net present value (NPV), internal rate of return (IRR), and payback period, estimated annual cash flows, operating and sustaining costs, and predicted copper sales is planned. The sensitivity analysis includes four key cost and revenue drivers, discount rate, copper price and capital and operating costs to assess the impact on cashflow, NPV, IRR and payback period. Monte Carlo simulations would be used to show the distribution of NPV based on sensitivity analysis and key factors, such as grade, production, and schedule.
Environmental
The Plan contemplates development of Environmental and Water Management Plans focused on proactive waste management and waste reduction practices addressing; waste and vegetation management, water, noise, air quality and hazardous goods and outlines responsibilities, procedures, training, as well as communication, mitigation, emergency response and incident investigation and reporting, reclamation, permitting, social and community factors related to the project. The WQARF designation to the project site means extra care is required to seal off potentially contaminated groundwater within alluvium and upper Gila aquifers to prevent mixing. Community outreach, engagement, and public information based on the ongoing Desert Fox Community Relations Program with Town of Miami officials and the local community is proposed.
Permitting
The Plan outlines the estimated timeline and anticipated permitting requirements to complete the work programs required to support completion of the PFS. The project permitting strategy would be to apply for all inclusive APP and UIC permits after completion of the proposed PFS level study outlined in the Plan.
Qualified Person
Elmer B. Stewart, MSc. P. Geol., President, and CEO of Copper Fox, is the Company's non-independent, nominated Qualified Person pursuant to National Instrument 43-101, Standards for Disclosure for Mineral Projects, and has reviewed and approves the scientific and technical information disclosed in this news release.
